USS Drum (SS-228)

Drum restoration

Around the year 2000, Tom Bowser, a MM1 (SS) nuclear submarine veteran, was passing through the Mobile, Alabama area. He spotted the USS Drum on a billboard and decided to stop by. He was able to make a few more visits on through 2004 and got to know Lesley Waters, a Battleship Park maintenance employee who was doing her best to take care of the Drum any way she could. Lesley had already been working on the Drum for several years. In 2004, Tom's job changed to where he was driving through Mobile every other week so he would stop by on Mondays and Fridays to bring Lesley supplies and to help her. After Tom's wife passed away, he moved to the area and started working at Battleship Memorial Park in the gift shop just so he could help restore the Drum (when he wasn't in the gift shop). Finally able to retire, Tom spends 60 to 70 hours a week working with Lesley at restoring and maintaining the Drum as well as giving tours.

Below you will see photos of what Tom Bowser and Lesley Waters, along with other volunteer workers, have been doing with the USS Drum. If you want to help them, click on the "How to Help" link up top for more information.

Click on any photo to see the full-size version. Restoration progress is shown in reverse chronological order (newest updates at the top).

January 2010

Tom and Lesley created a new battle flag during this cold month.

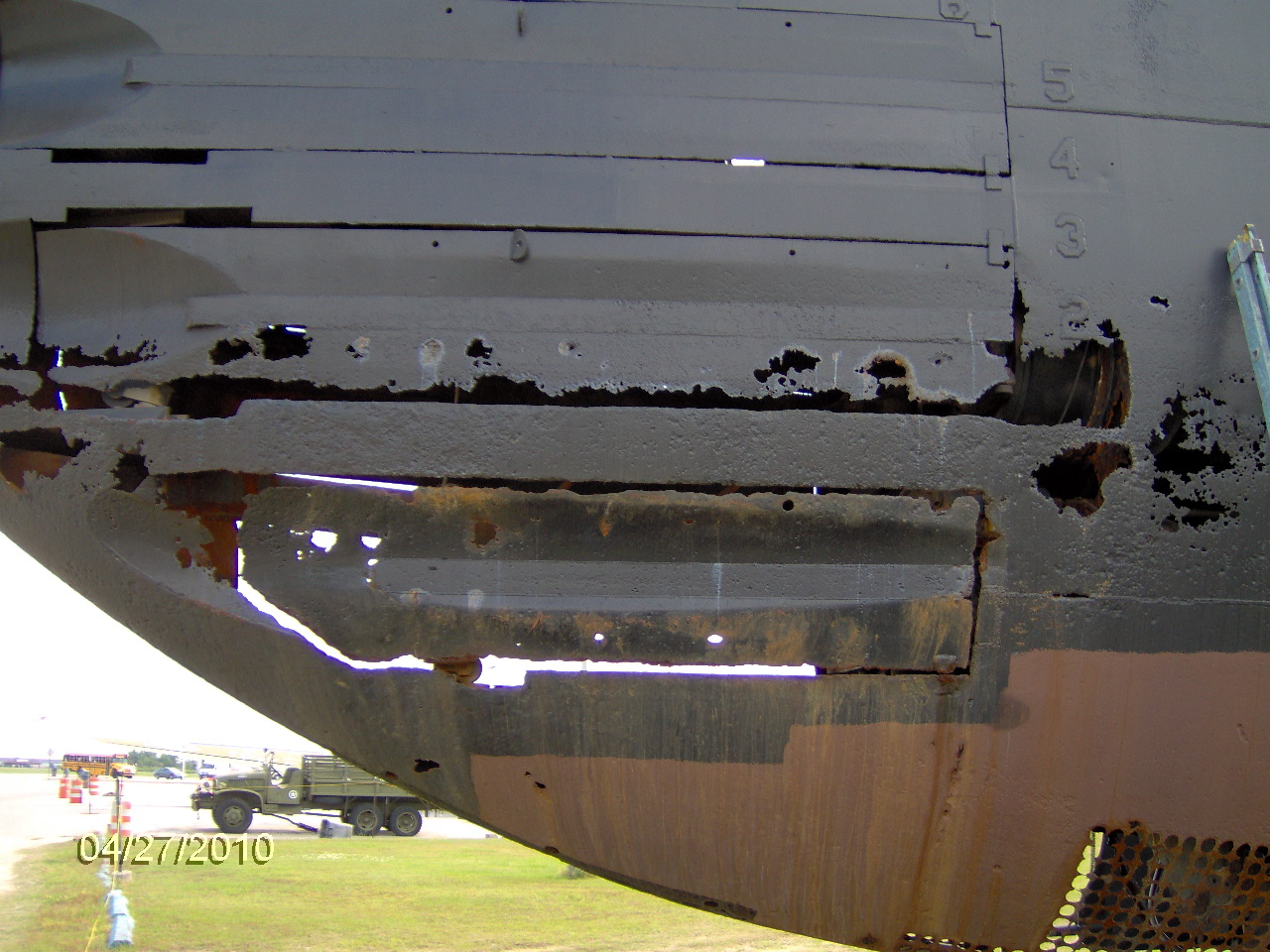

January 23rd battle flag

November 2009

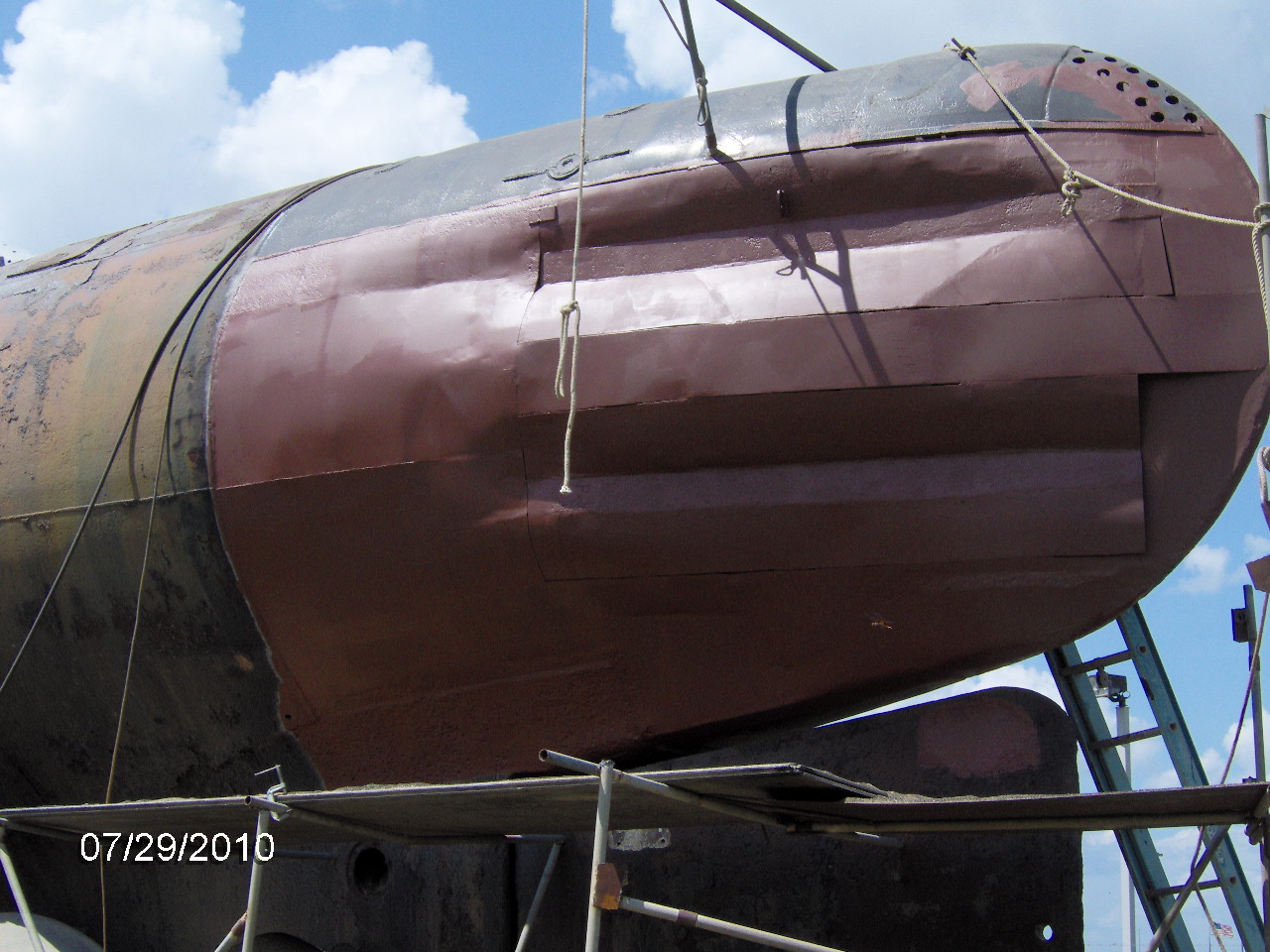

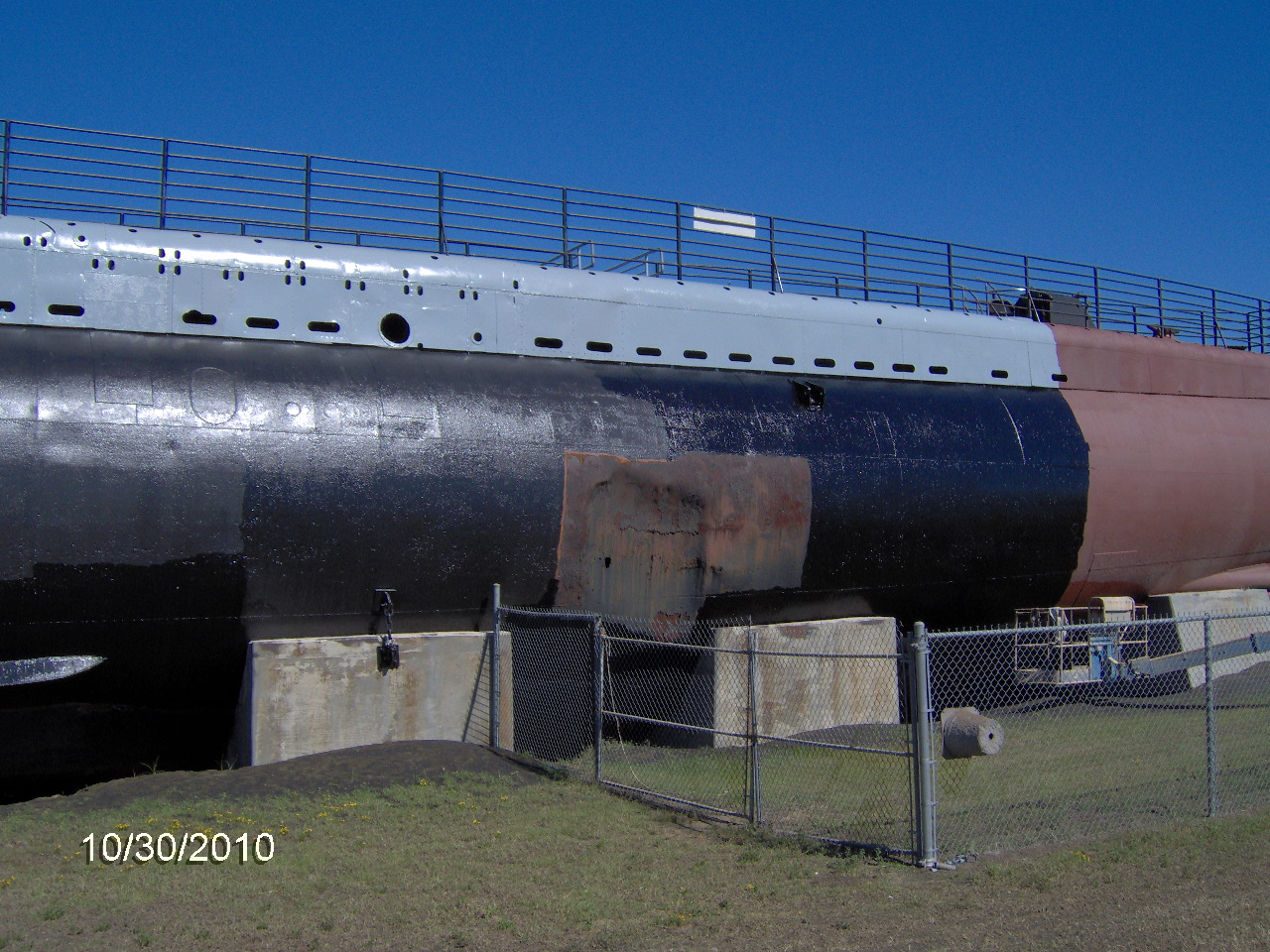

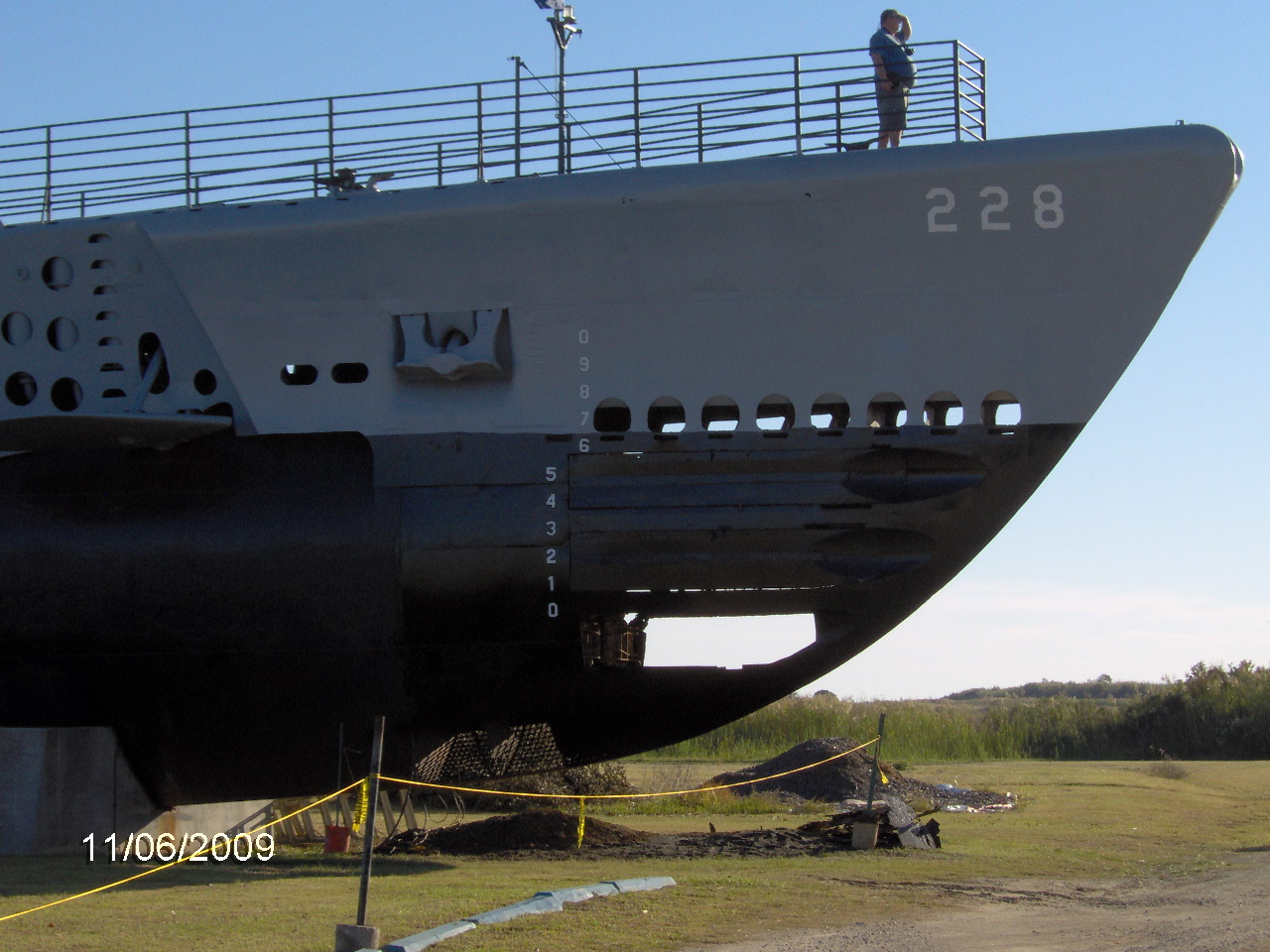

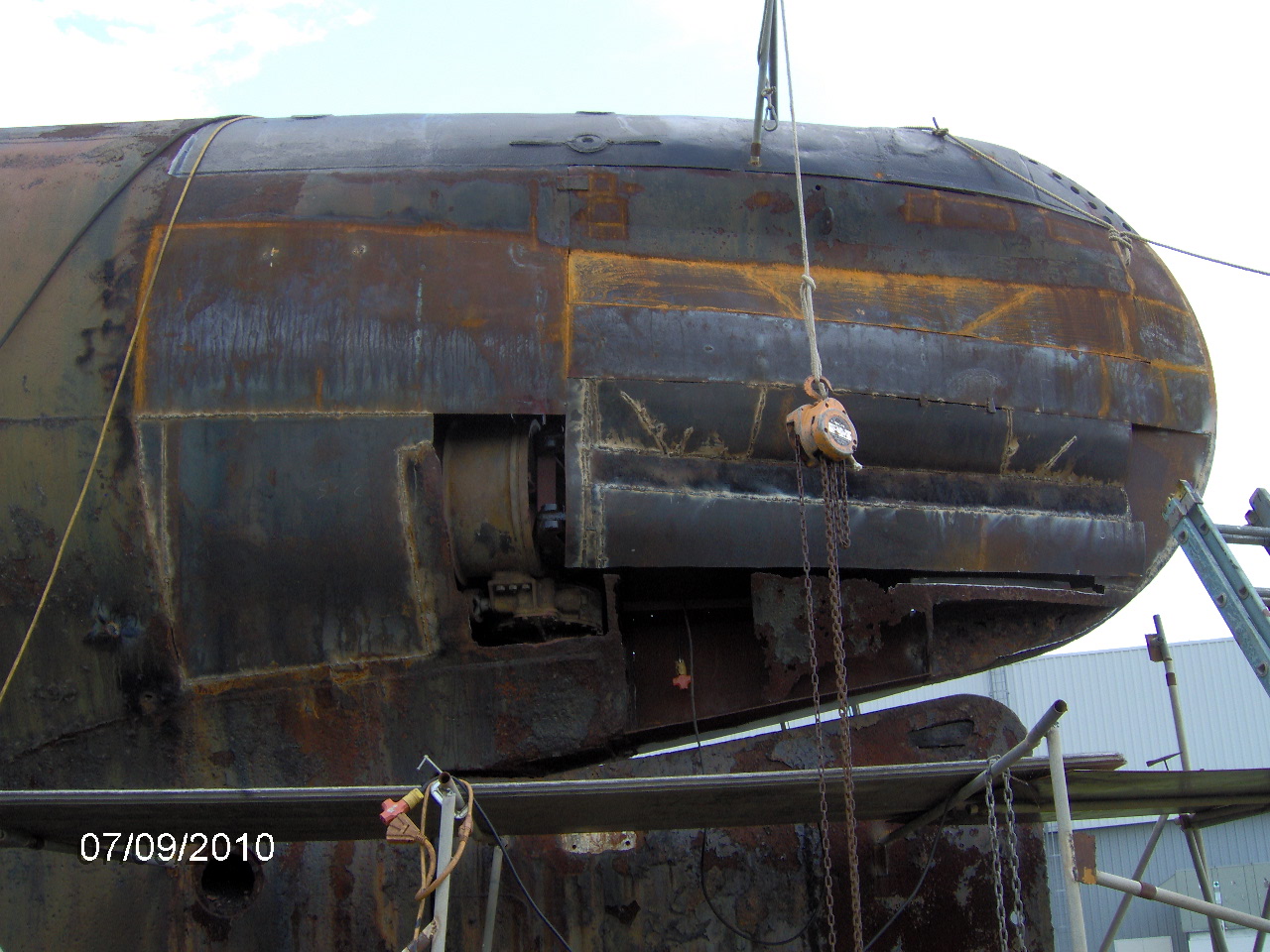

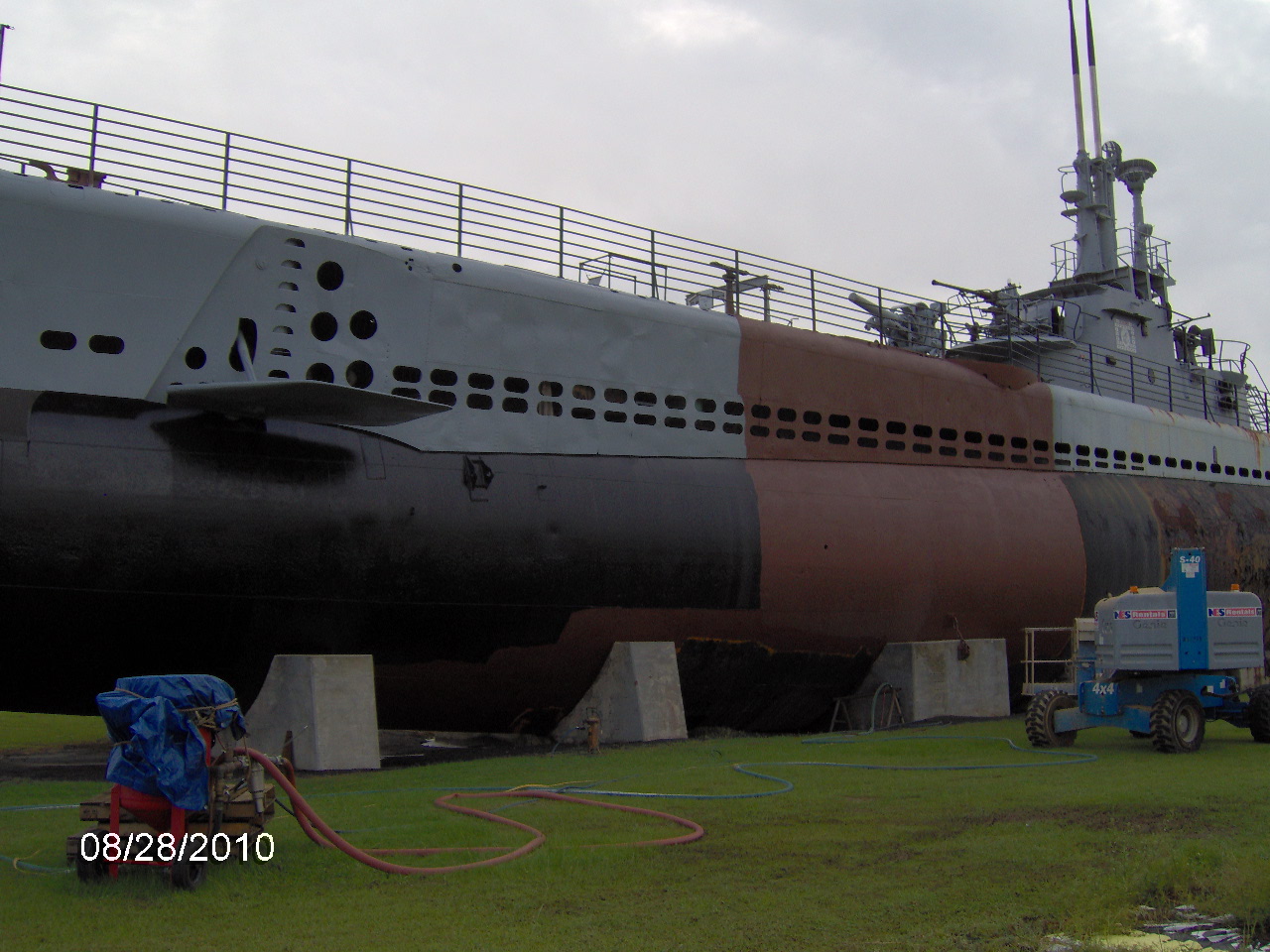

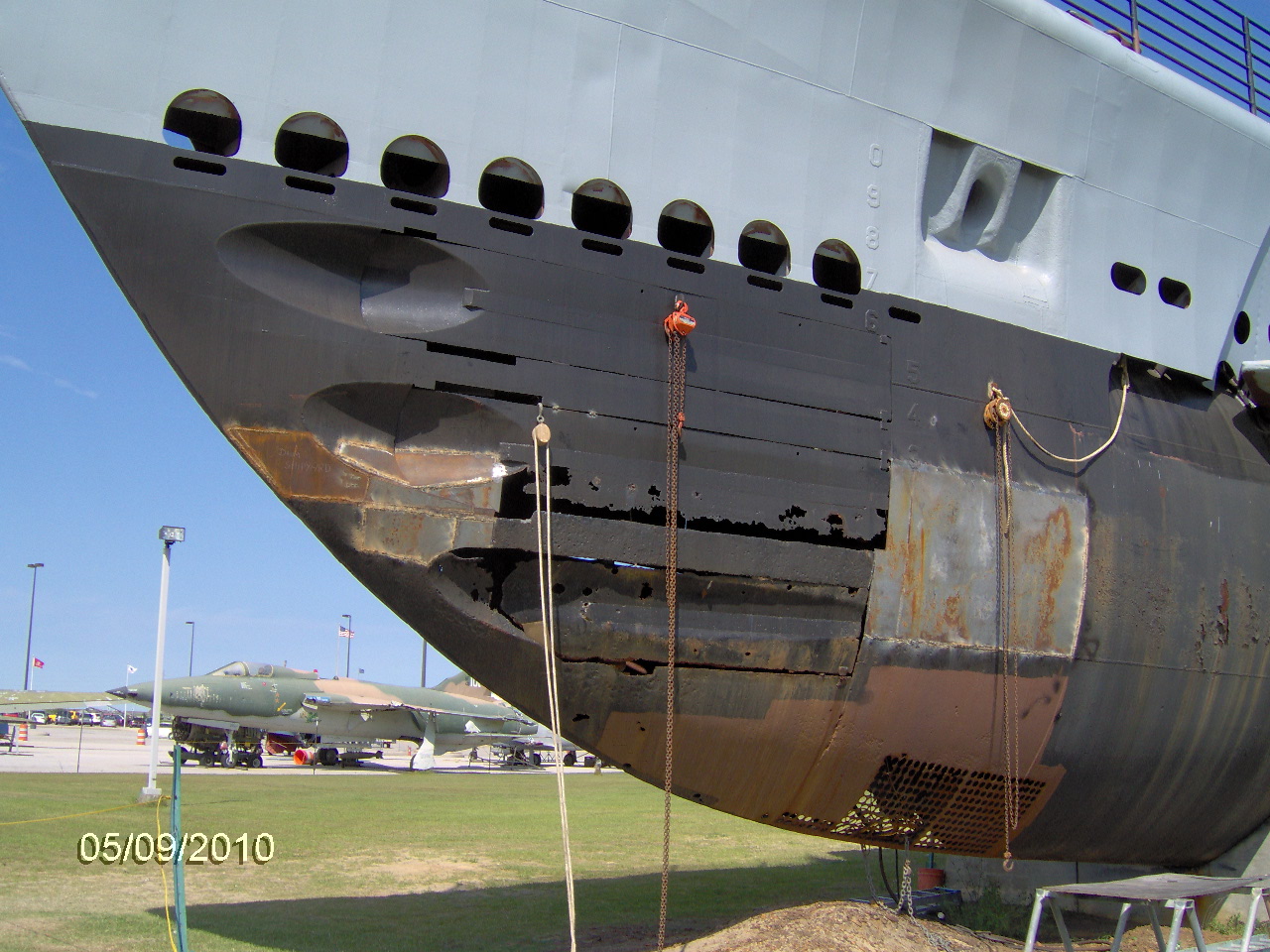

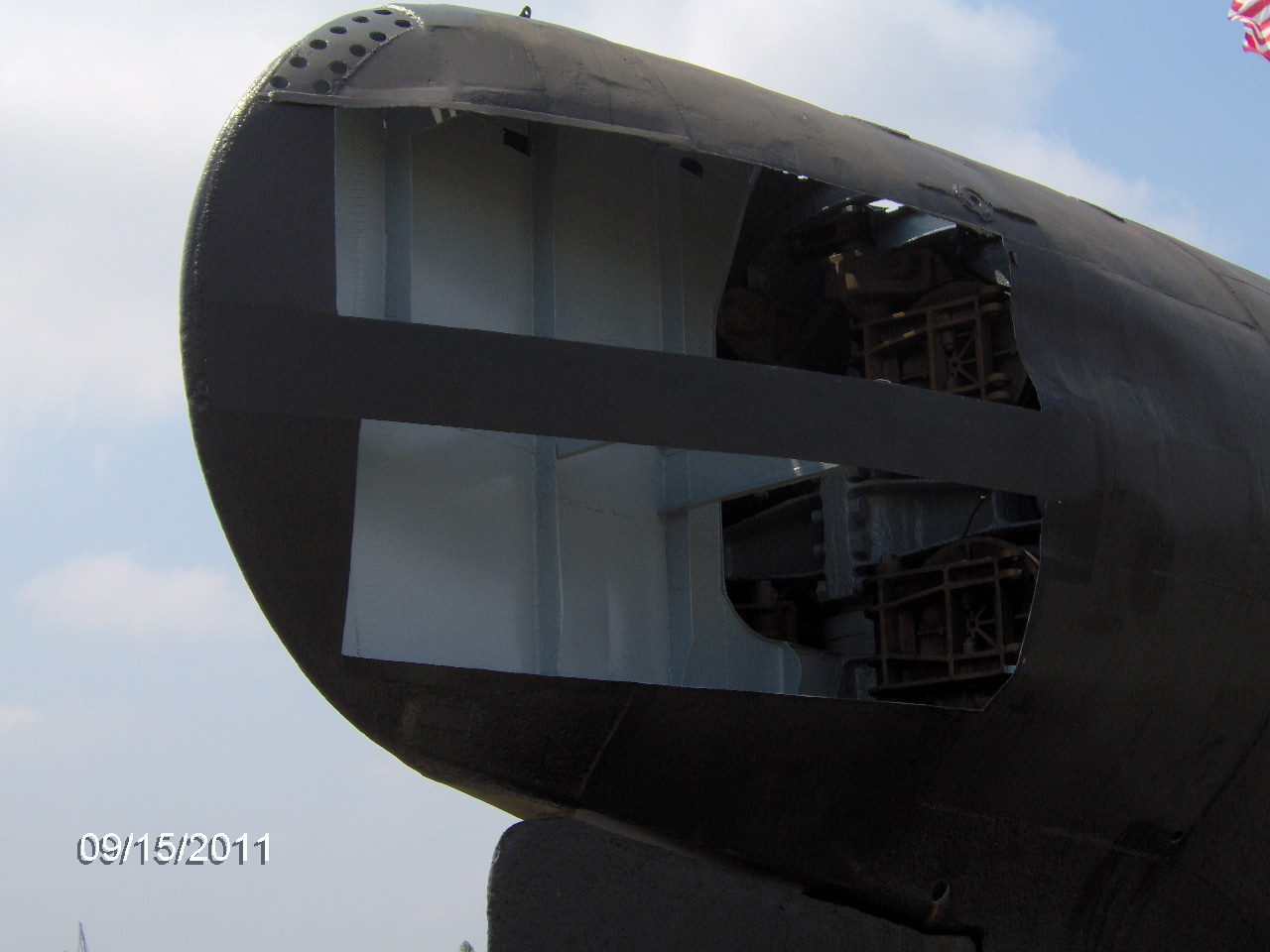

Here are photos from 11/6. The starboard bow is almost complete except for the #5 outer shutter door.

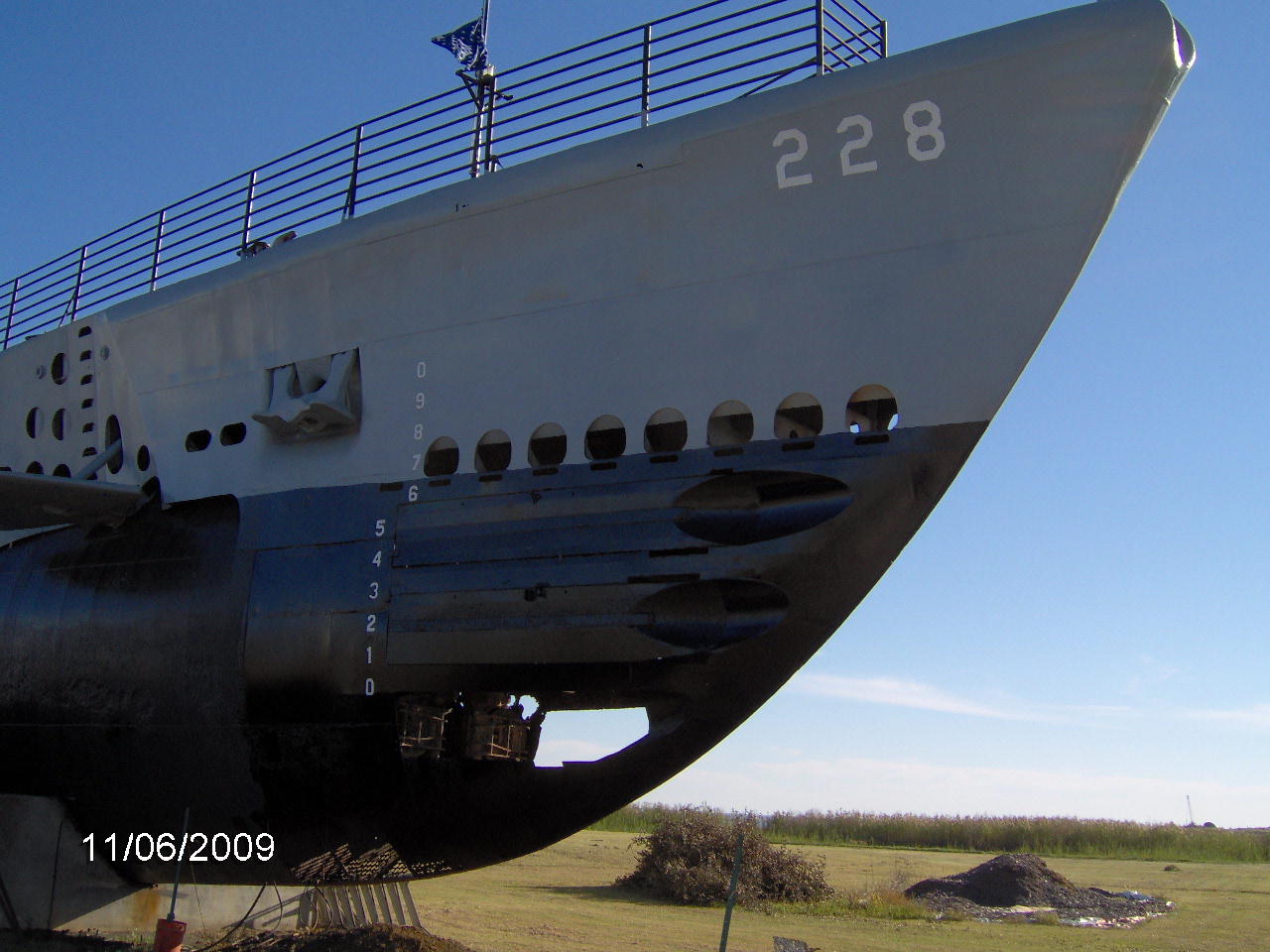

November 6th starboard bow November 6th starboard bow

October 2009

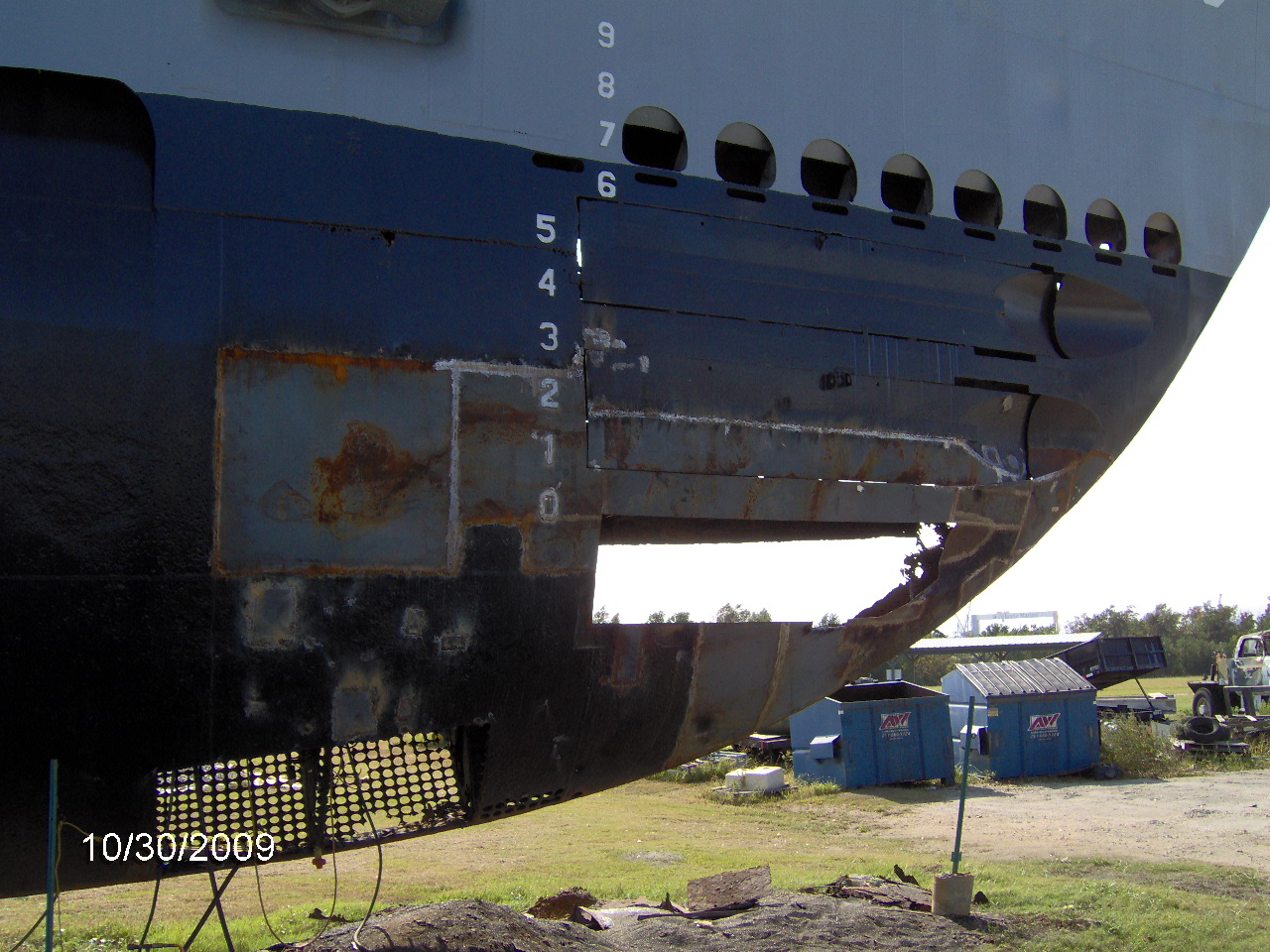

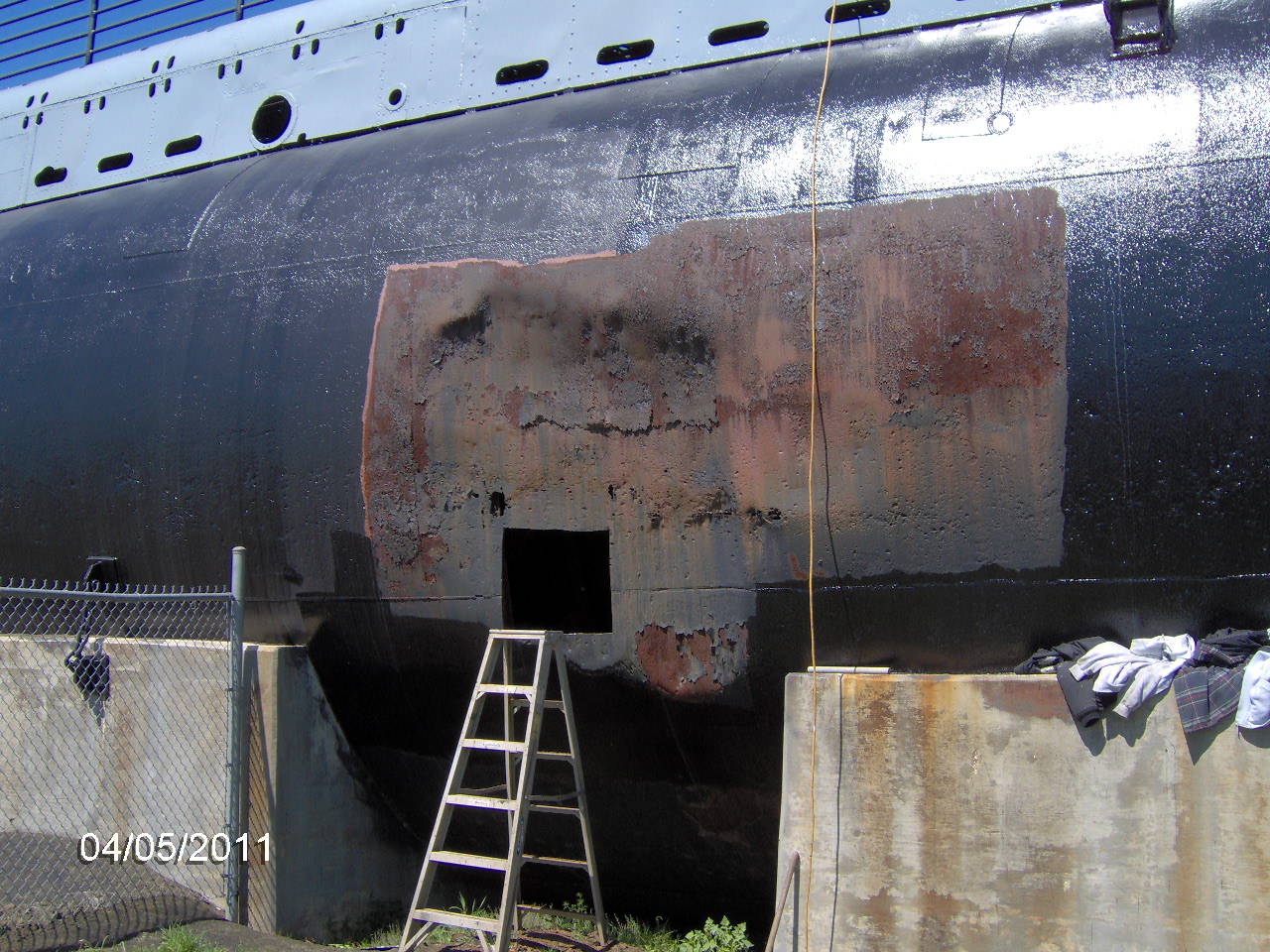

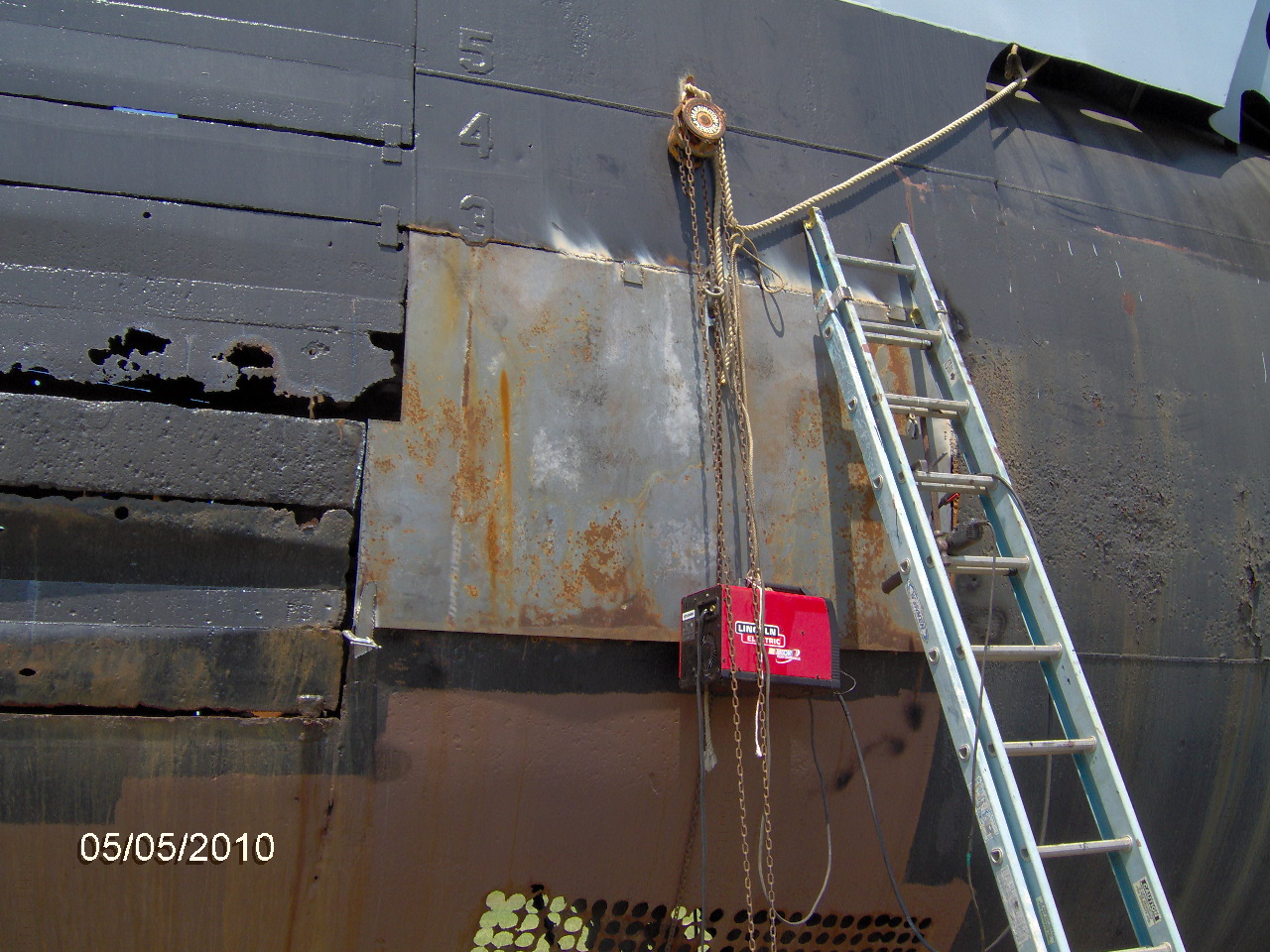

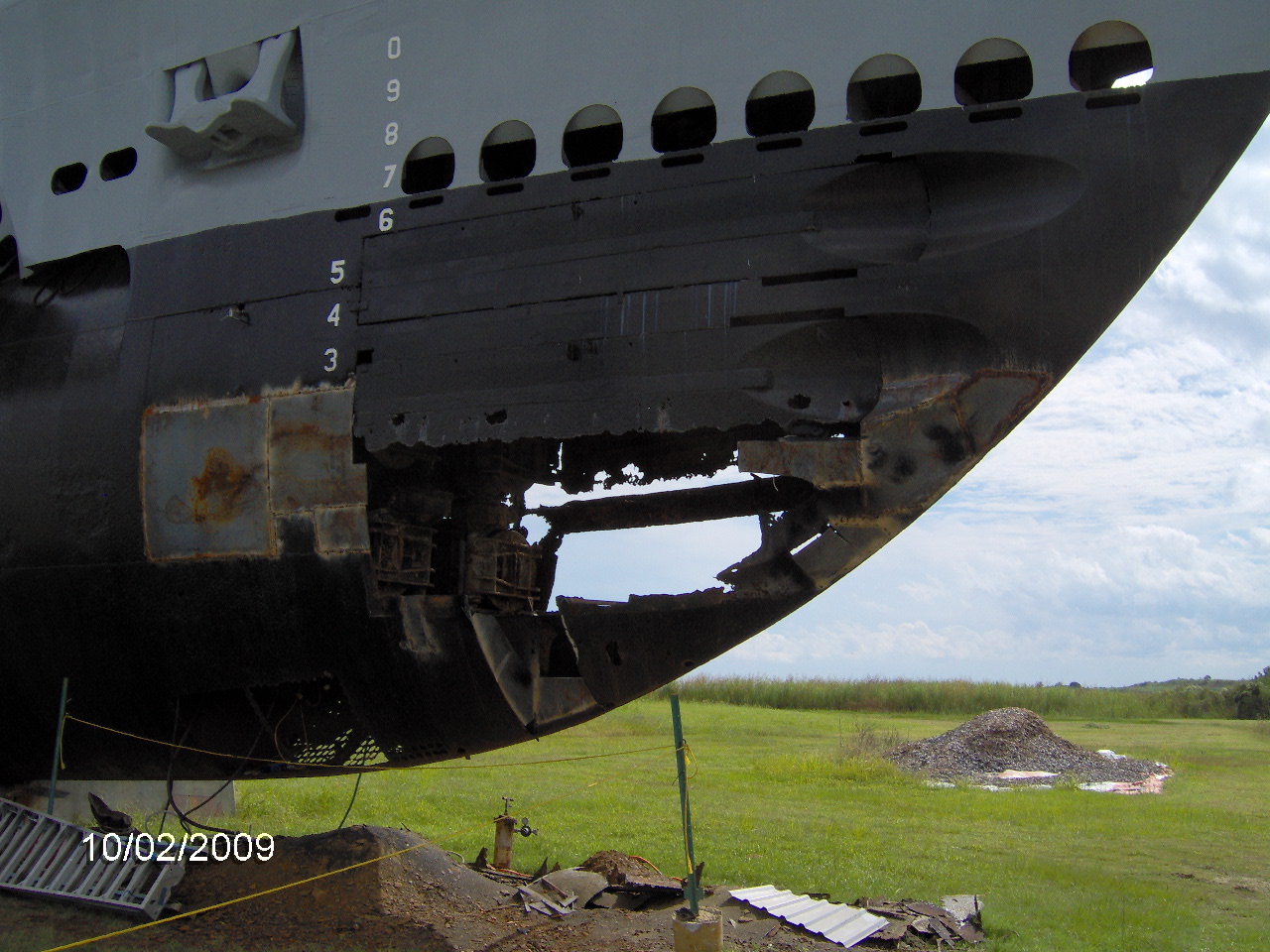

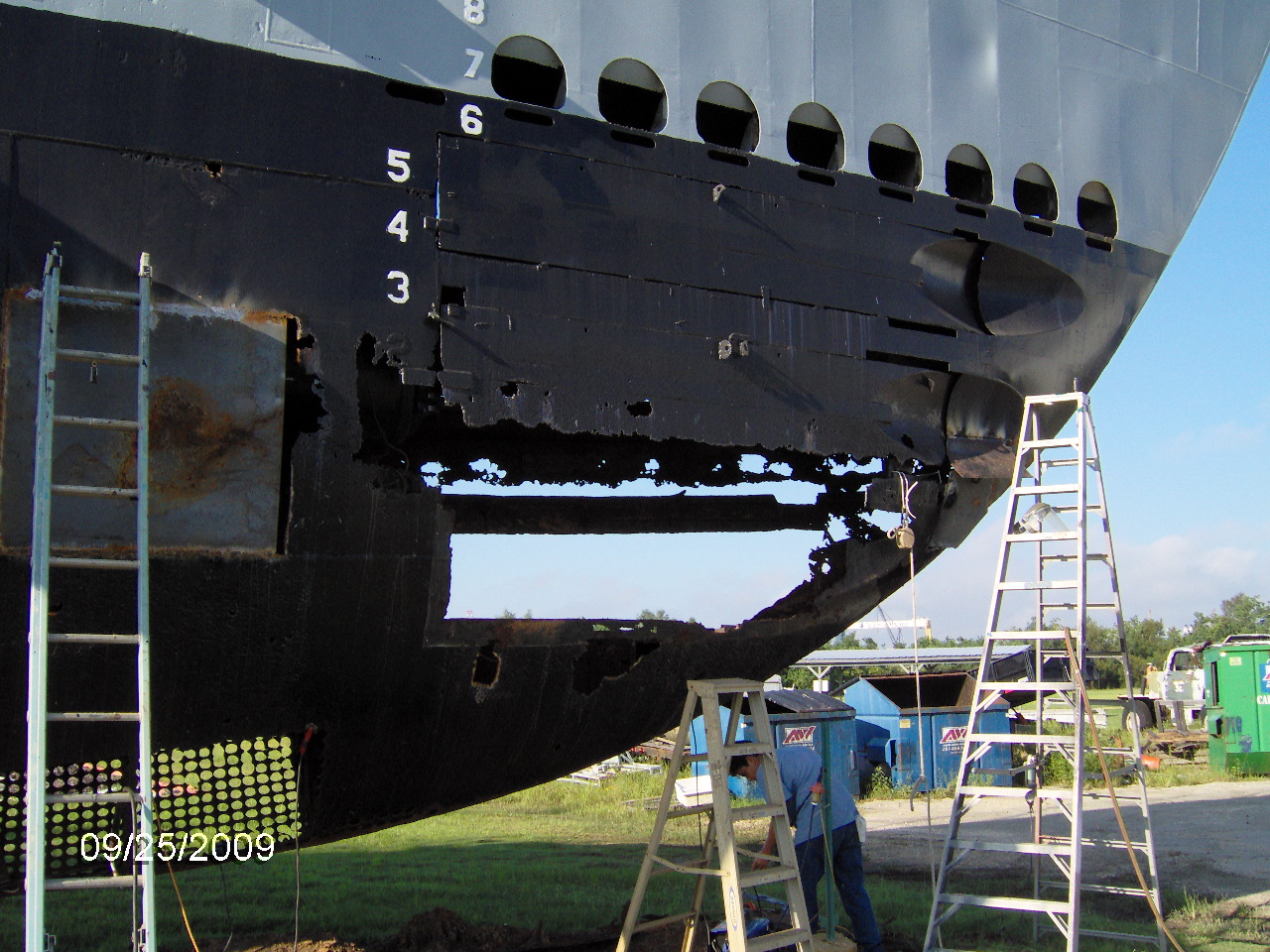

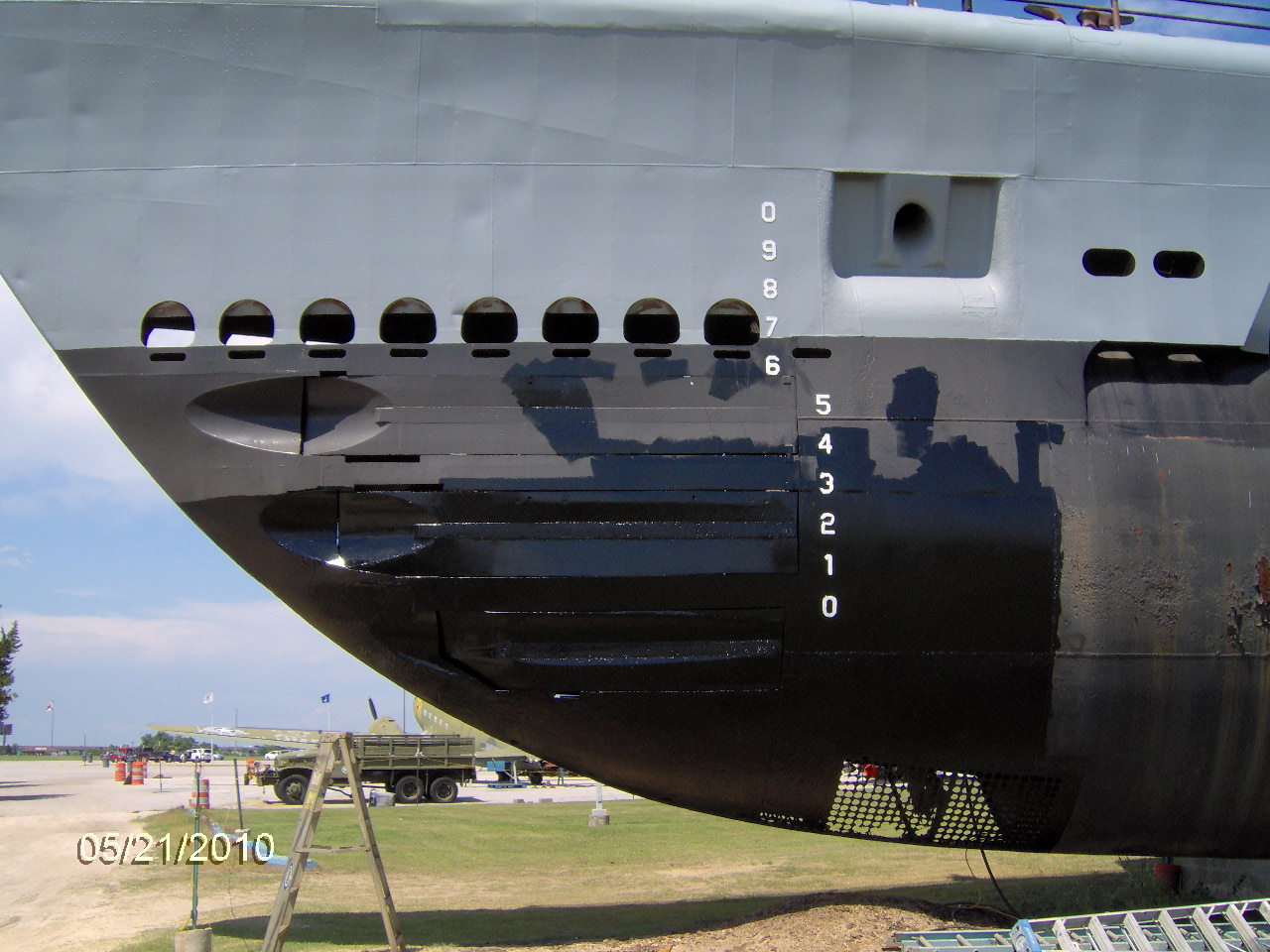

Here's how the starboard bow looked at the end of October. Note the draft numbers 0, 1, and 2. Lesley cut those out of 1/8" steel plate with a torch. Nice work!

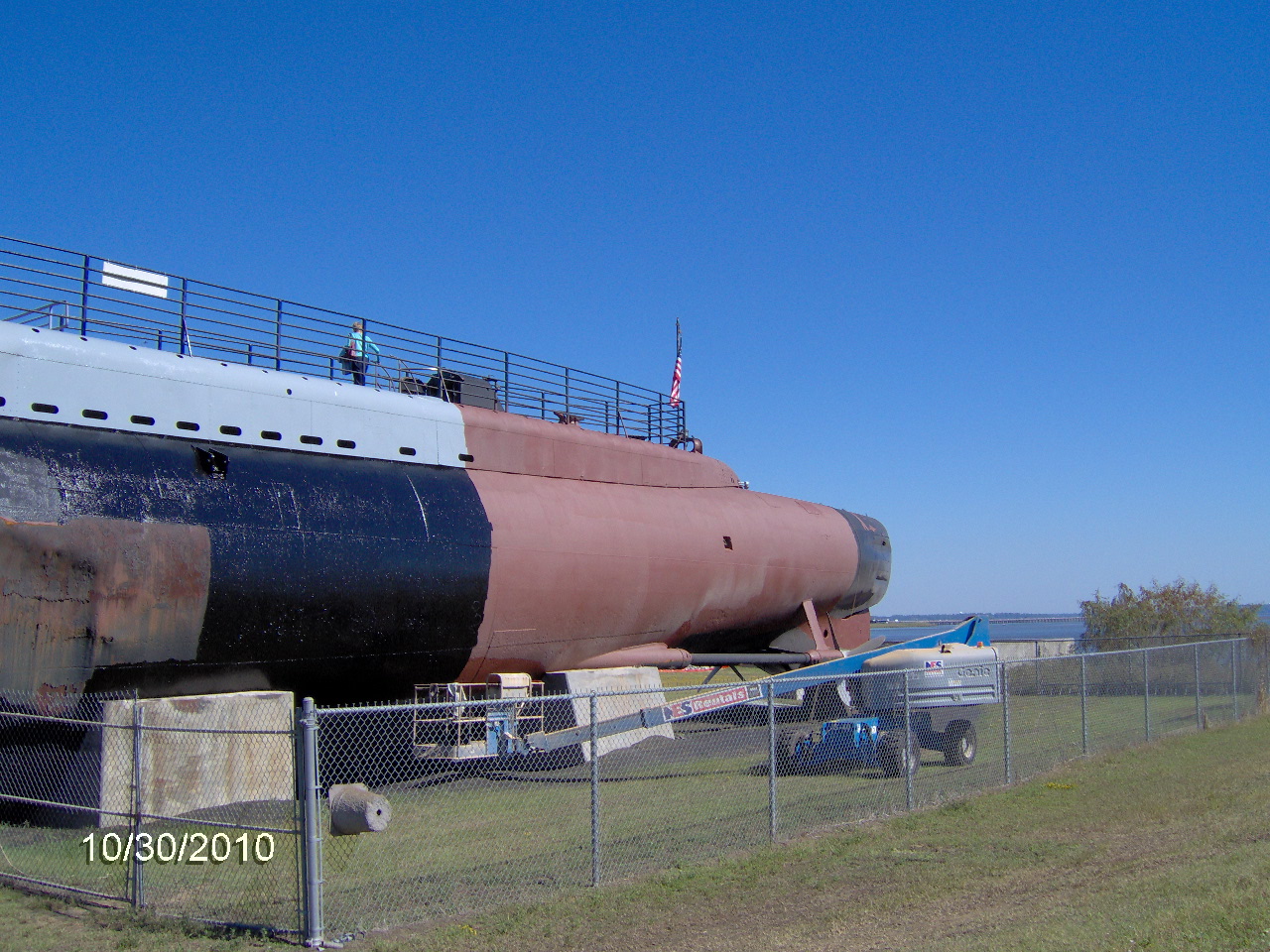

October 30th bow work

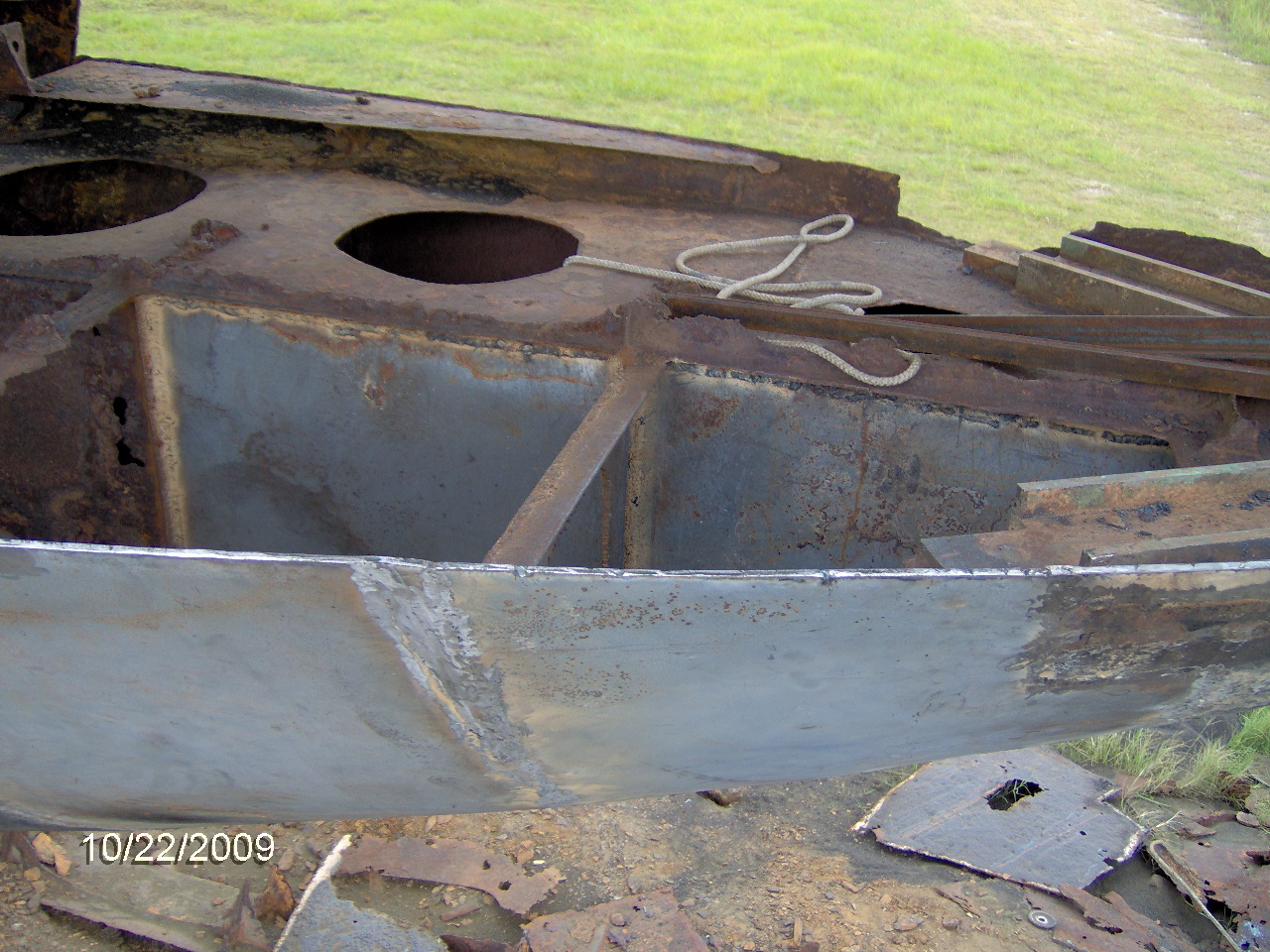

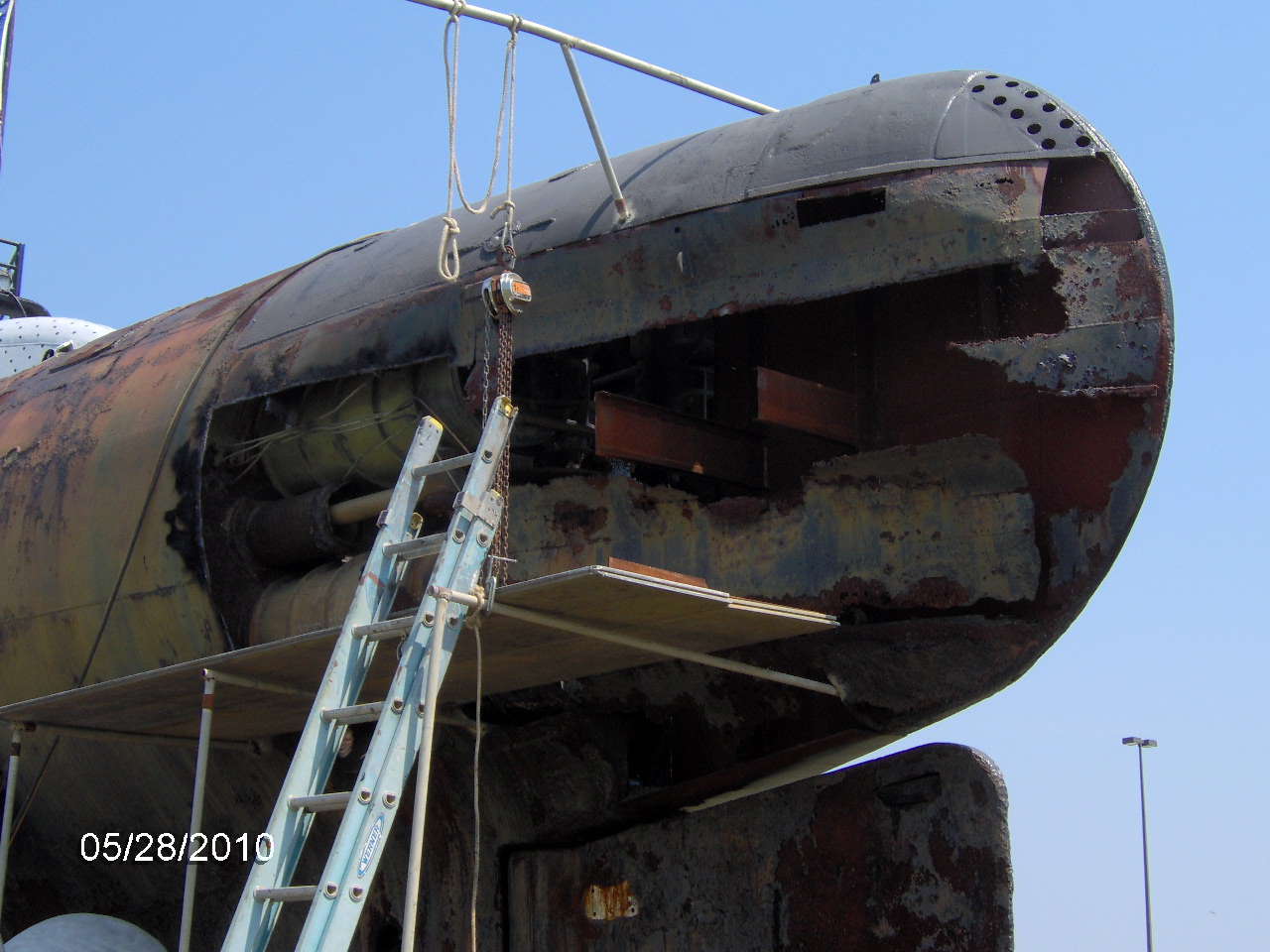

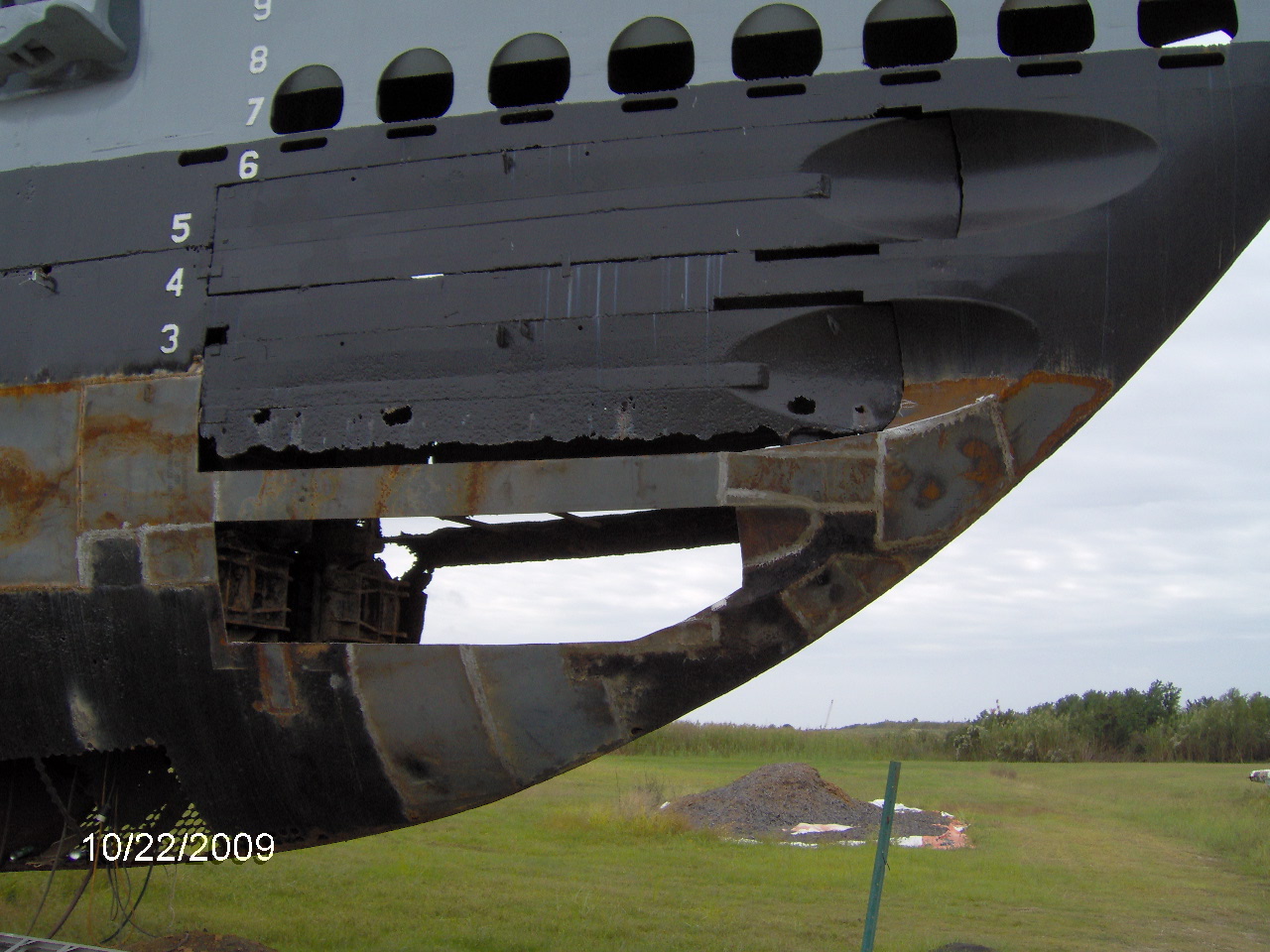

Update for 10/22, bow restoration still ongoing. Tom and Lesley are getting ready to fabricate shutter doors.

October 22nd bow work October 22nd bow work

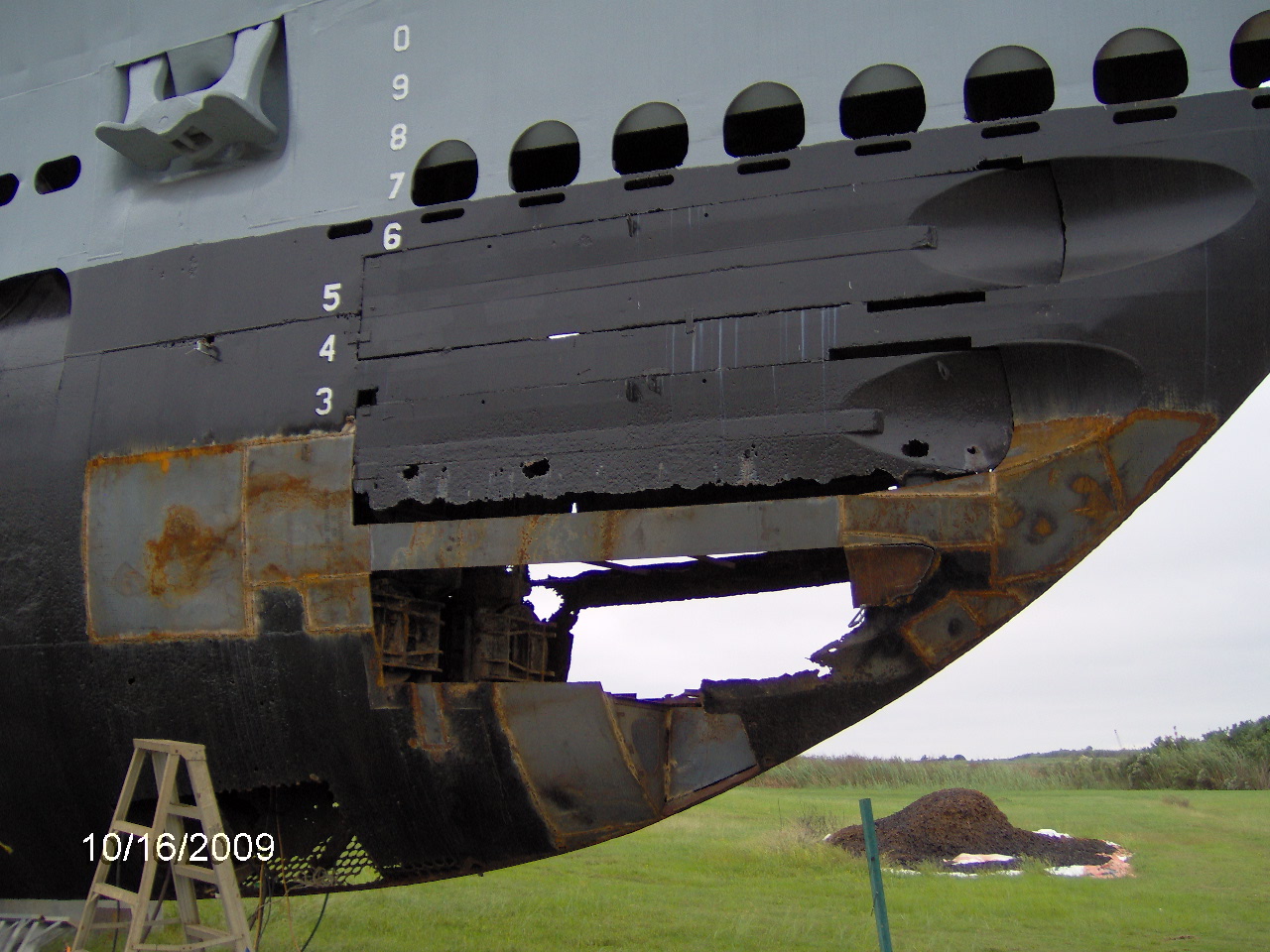

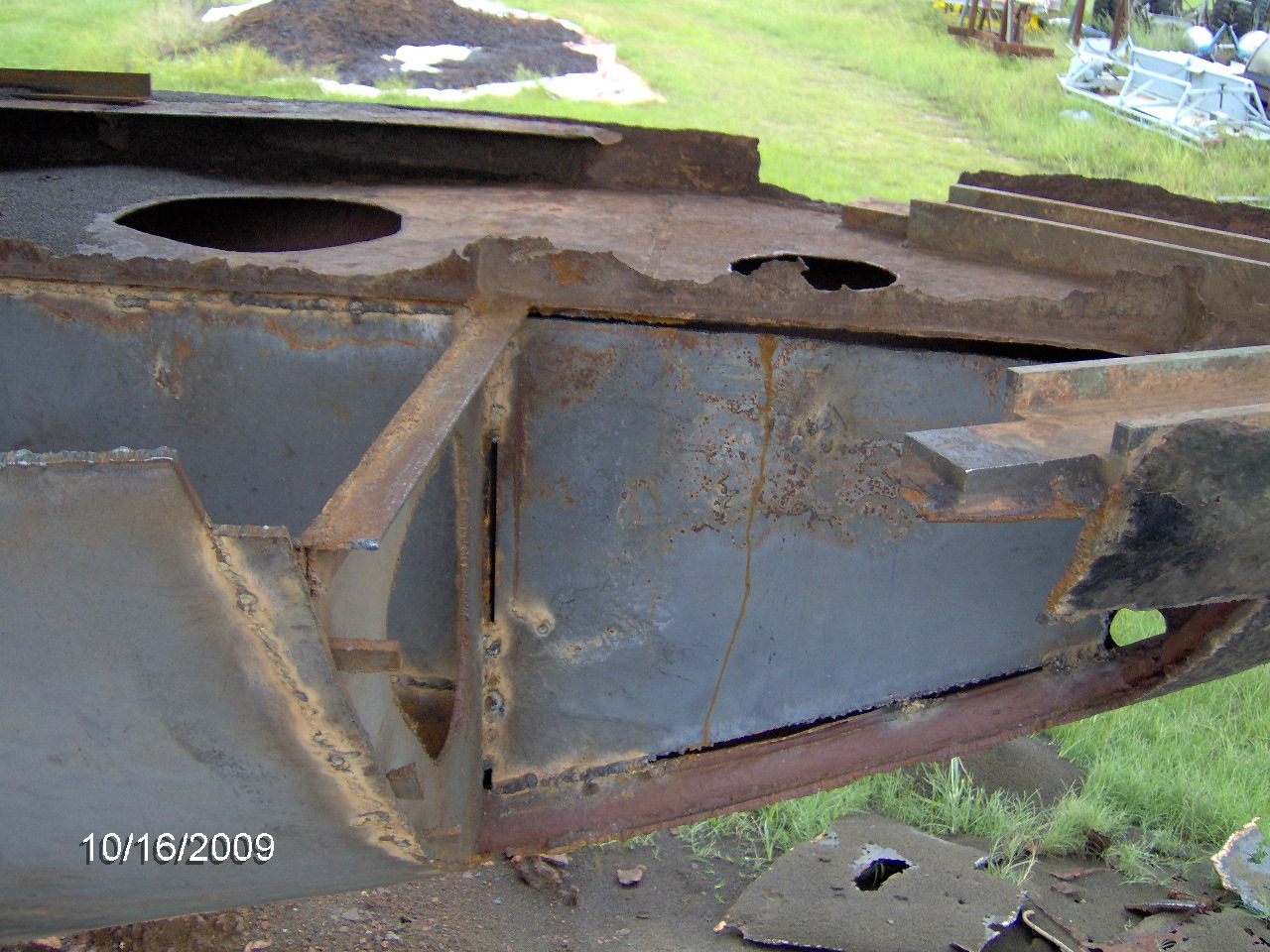

Update for 10/16, more bow restoration.

October 16th bow work October 16th bow work

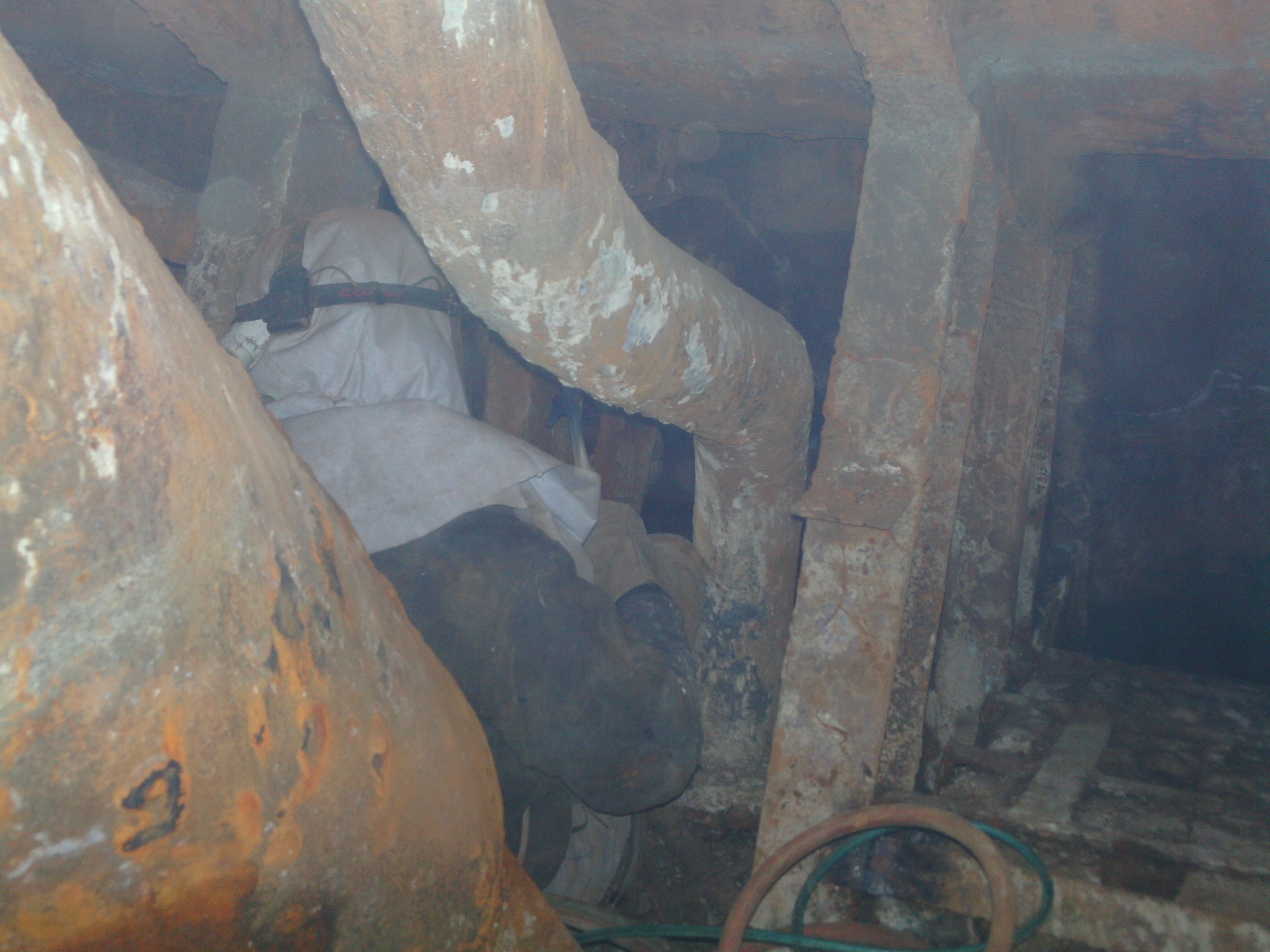

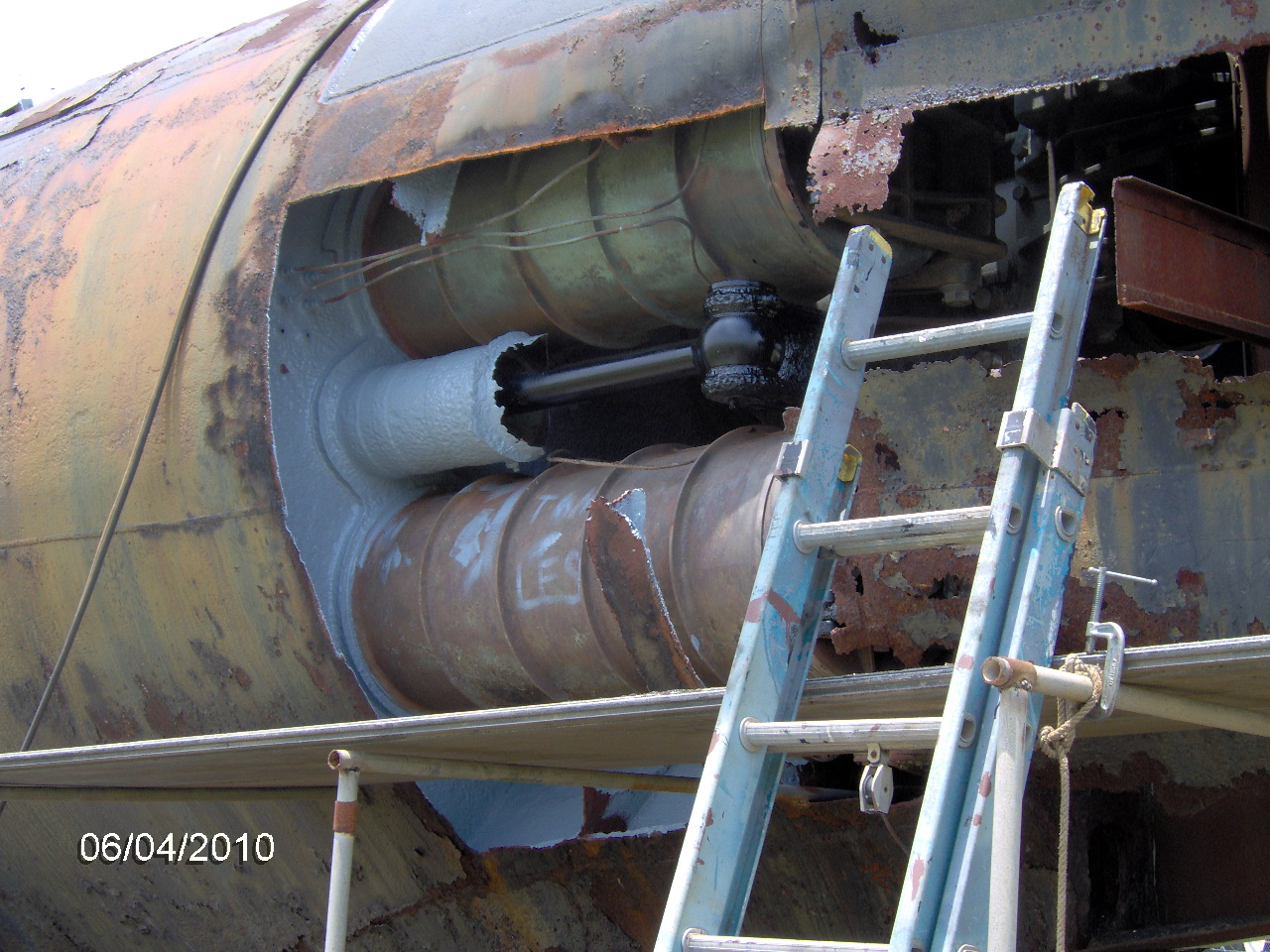

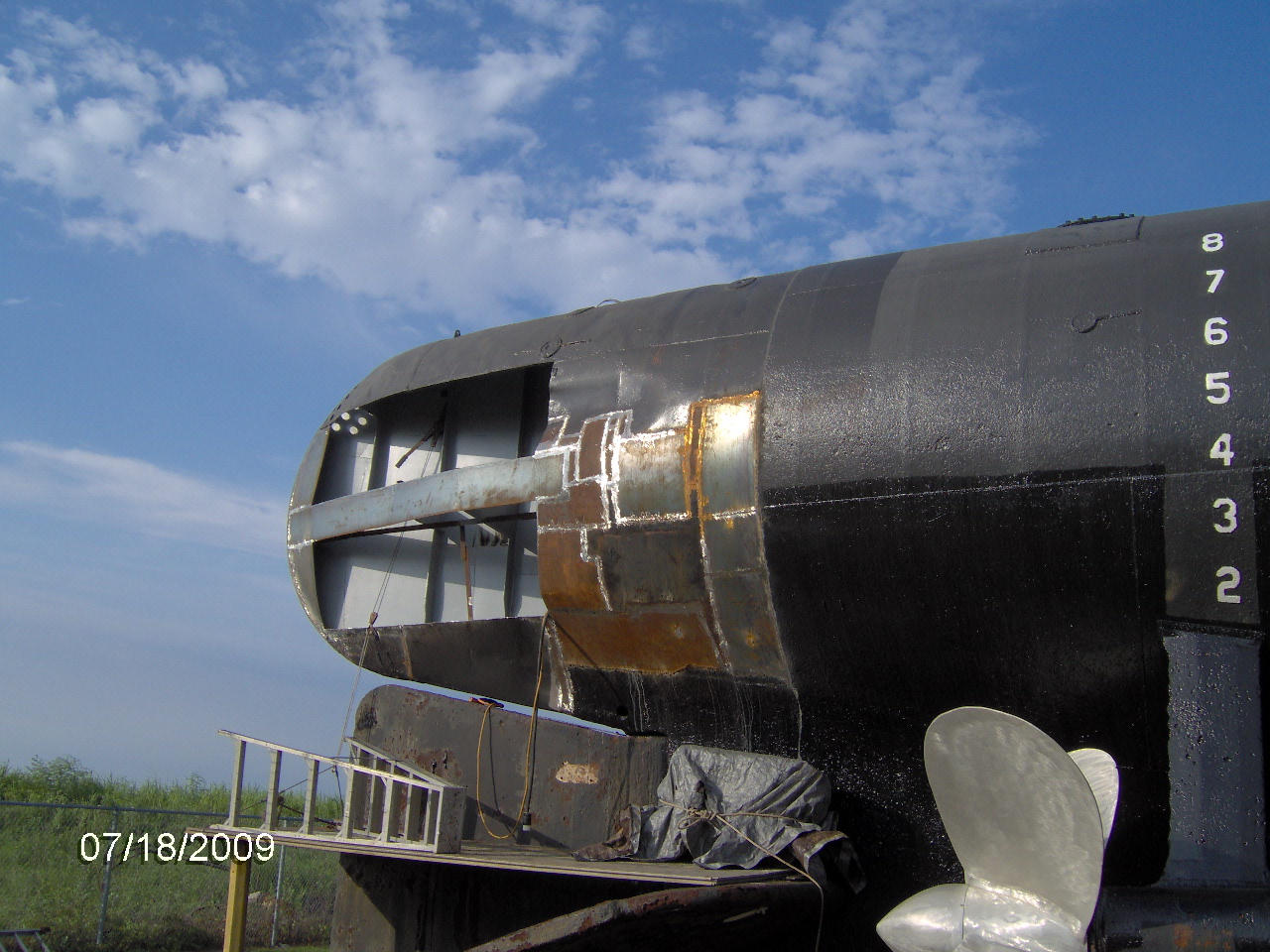

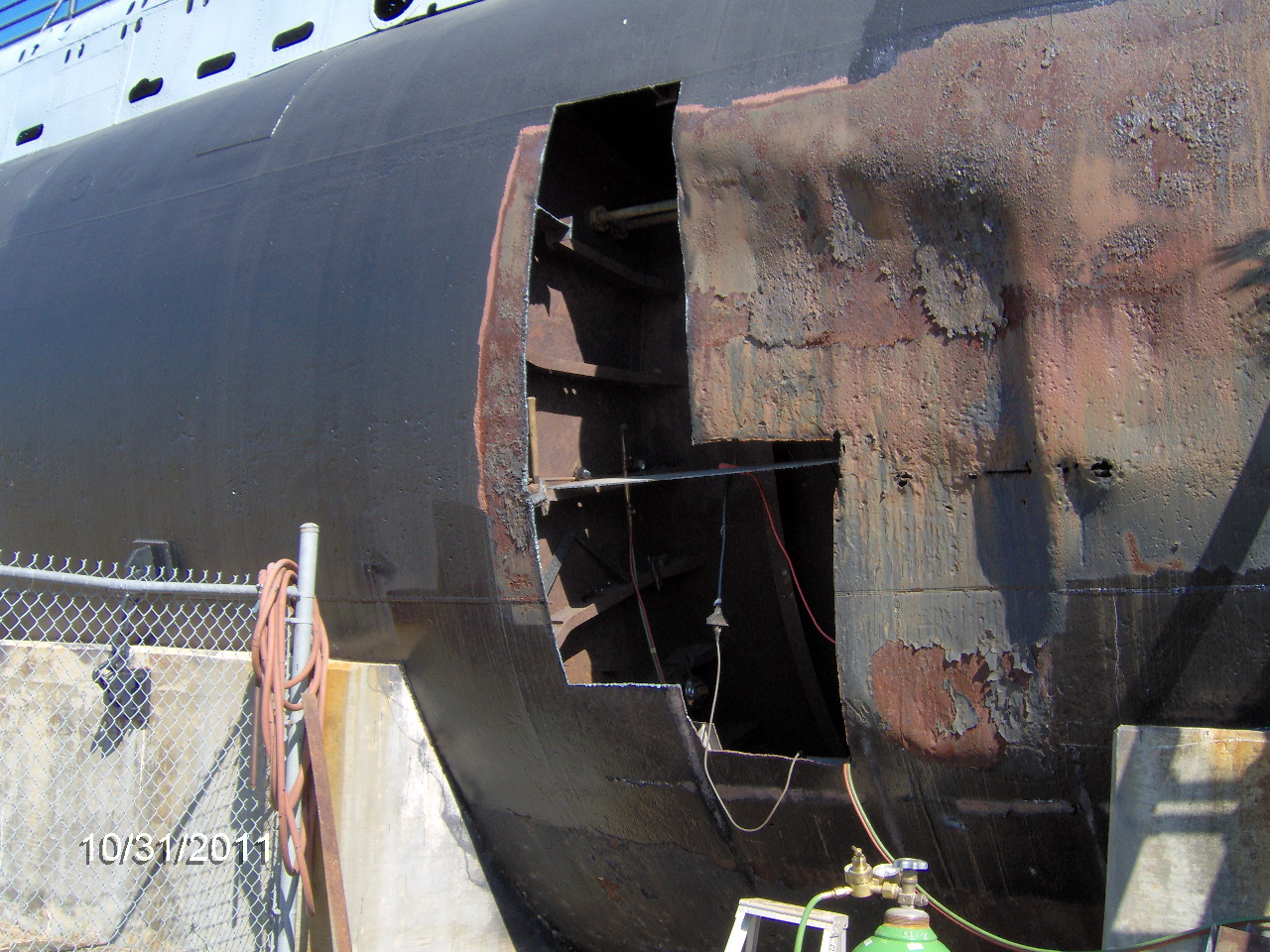

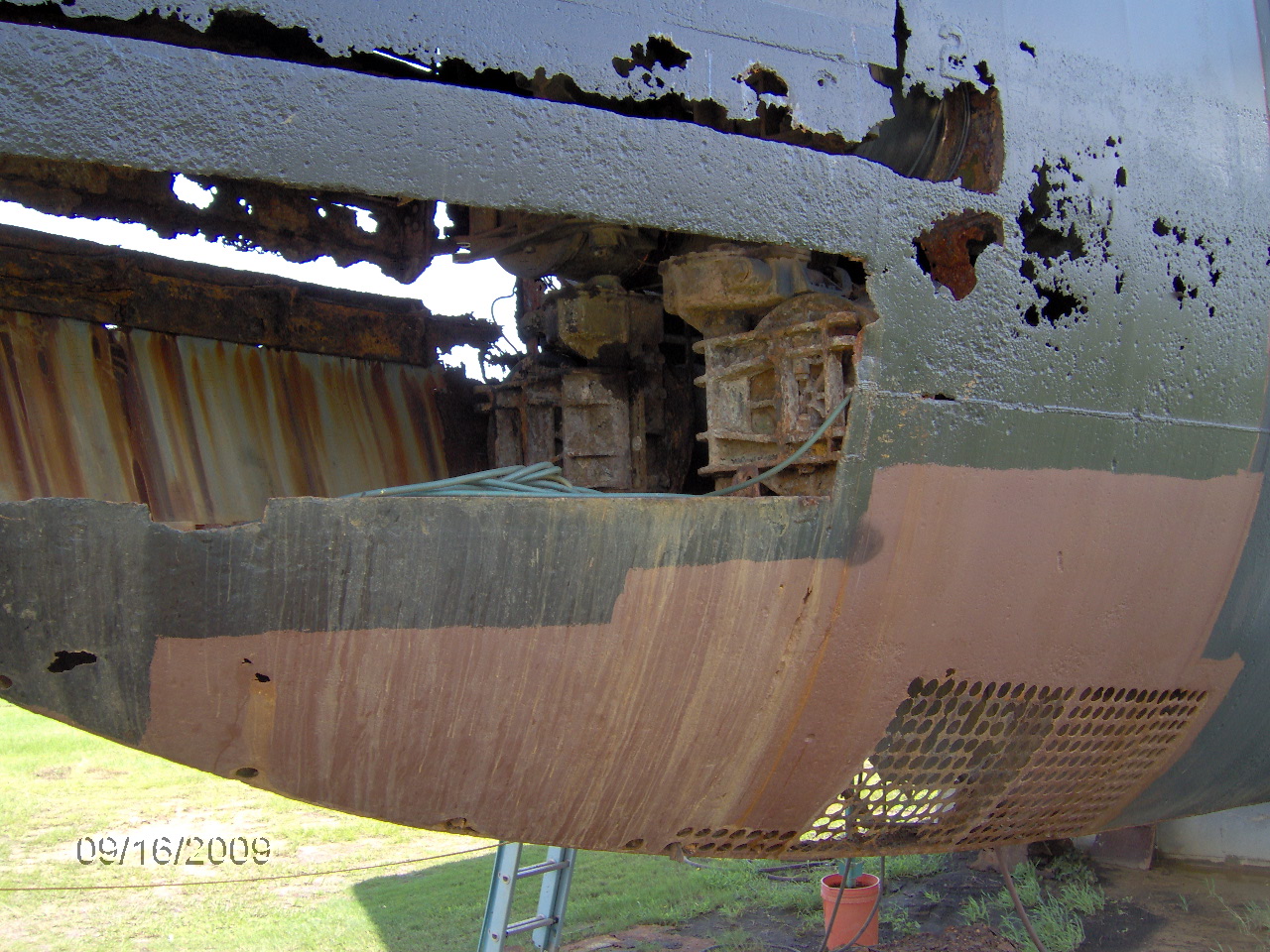

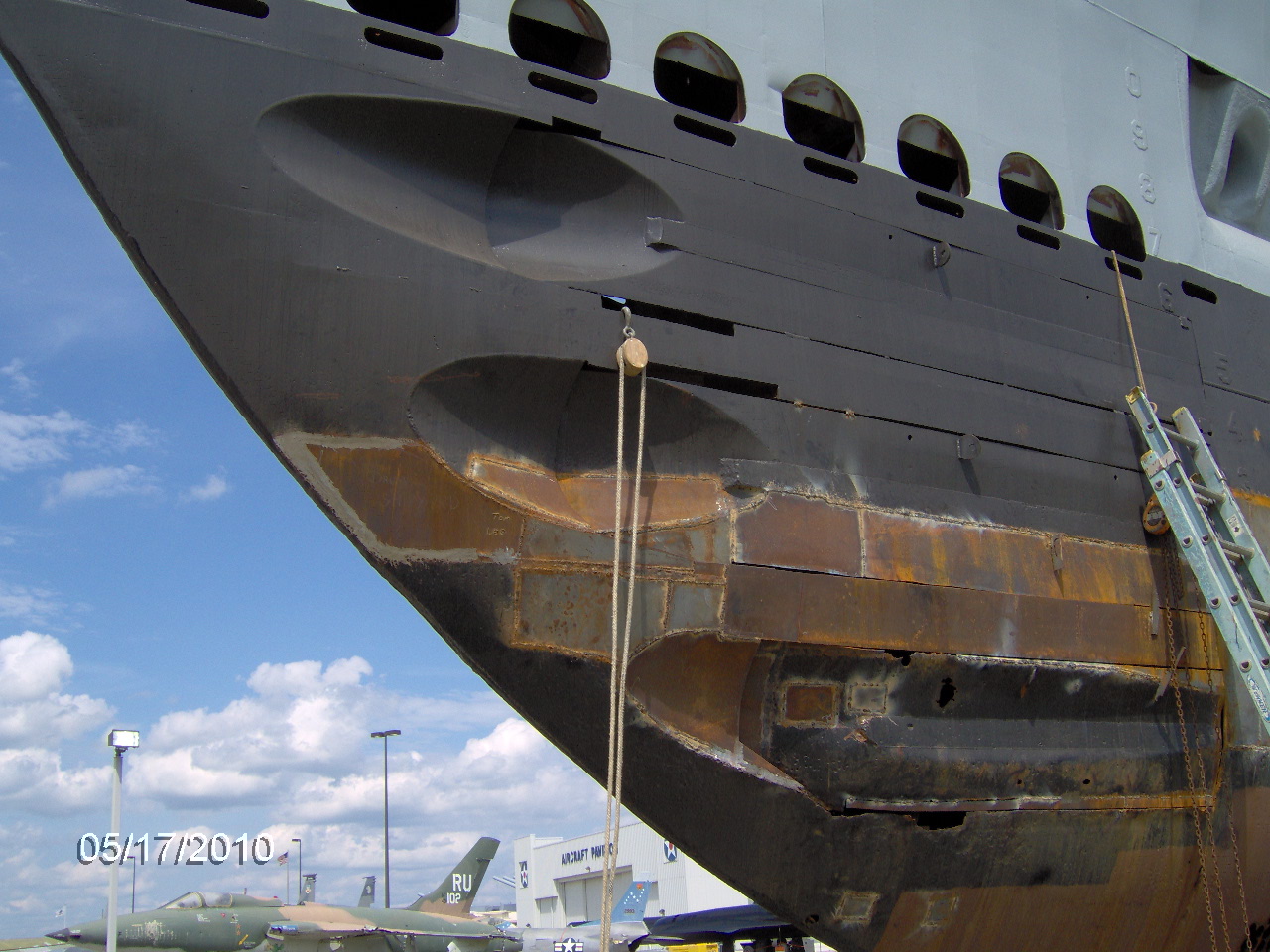

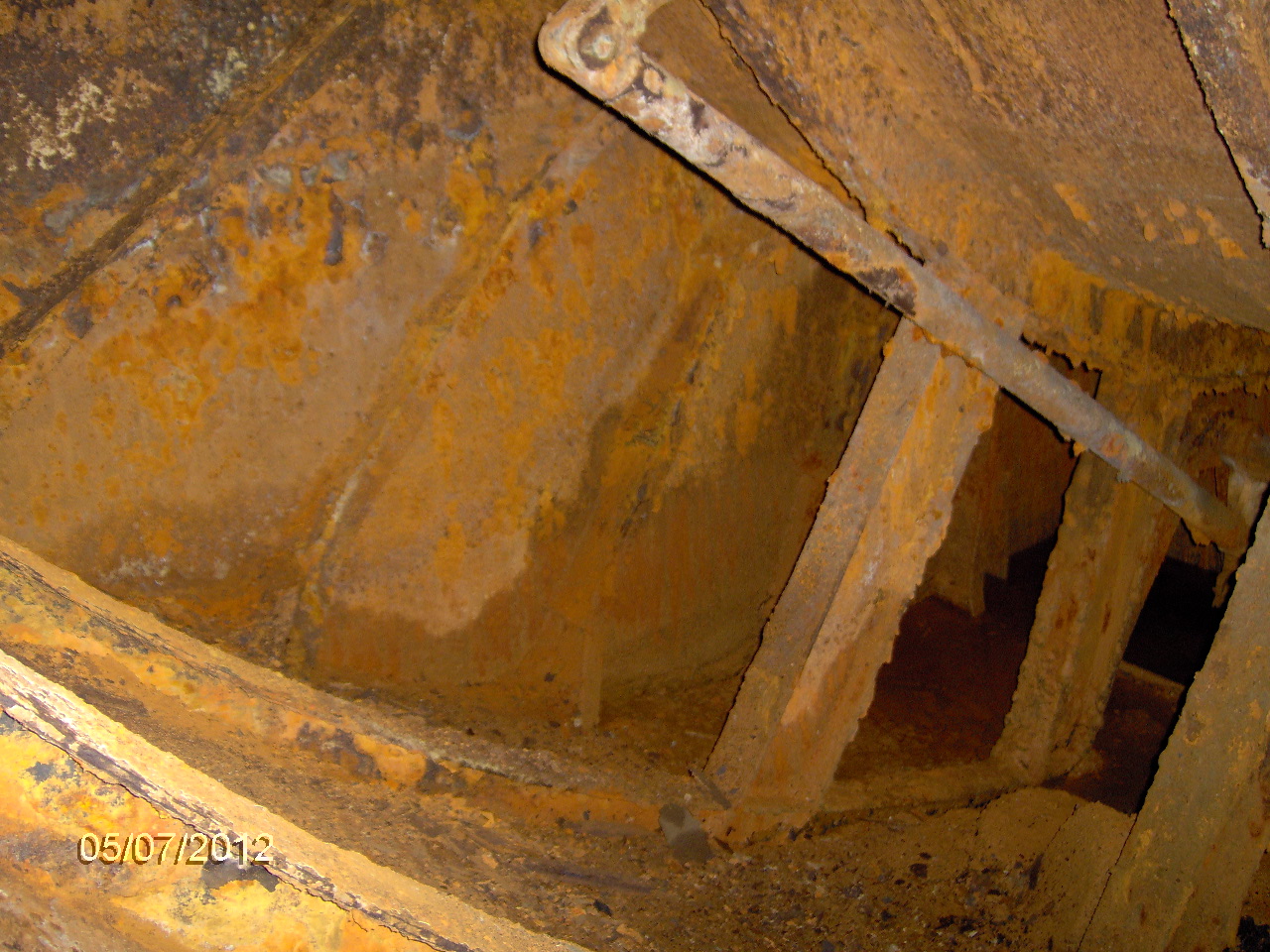

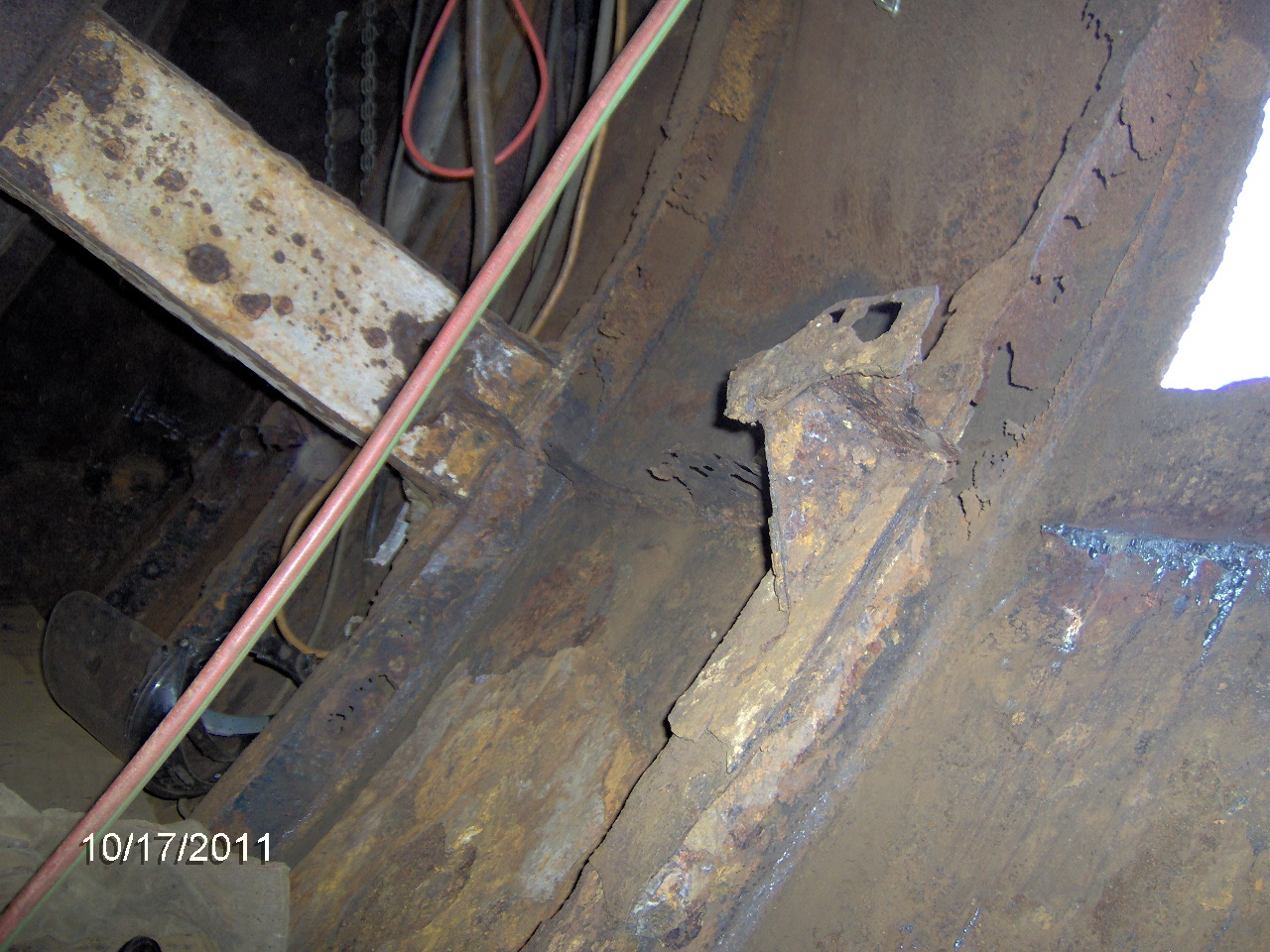

Bow restoration is ongoing. Tom said that they are having to replace almost all of the hull on the lower six feet of the starboard side and all of the structure inside for the lower ten feet as it's almost completely gone.

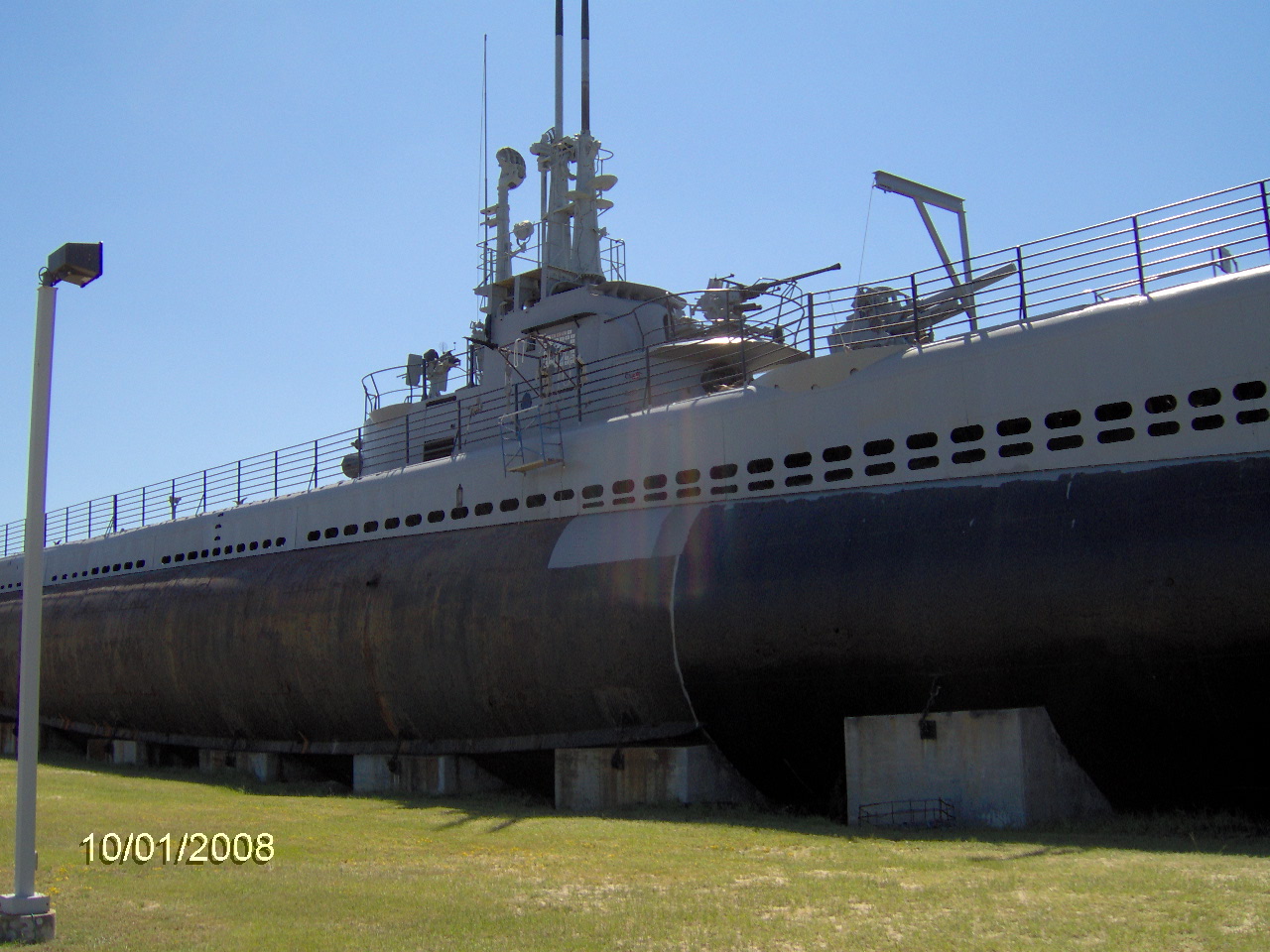

October 2nd bow work October 2nd bow work

September 2009

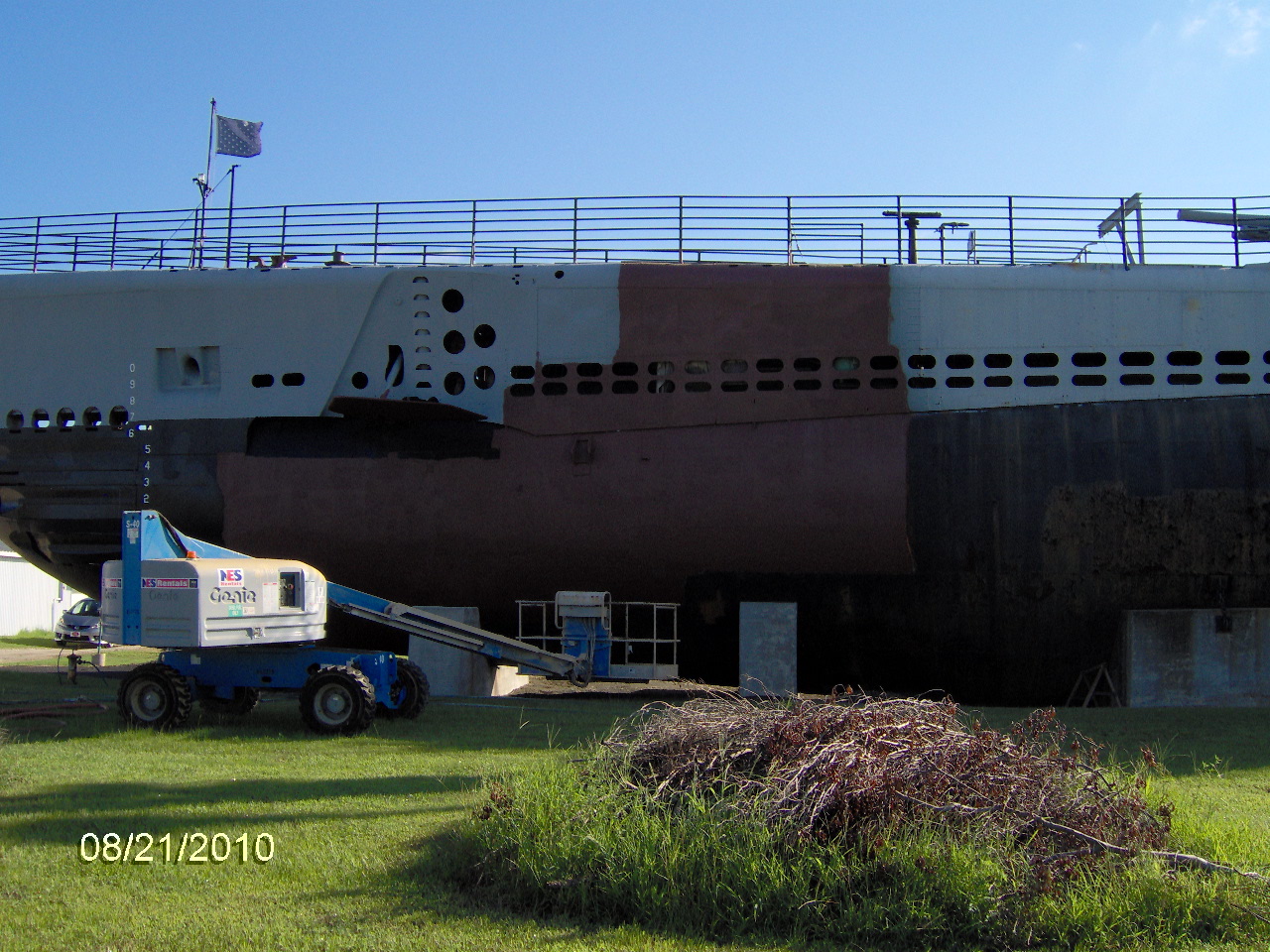

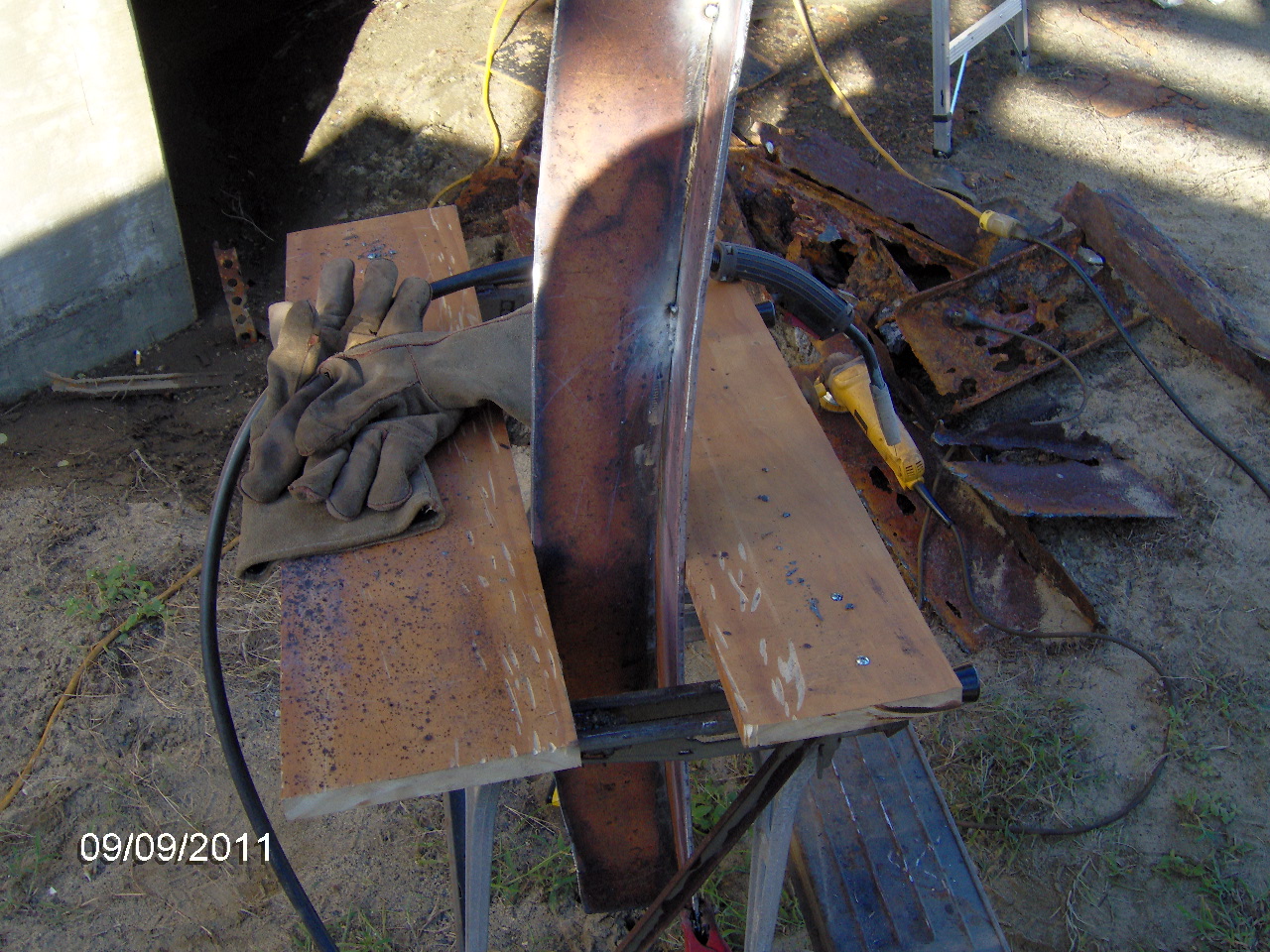

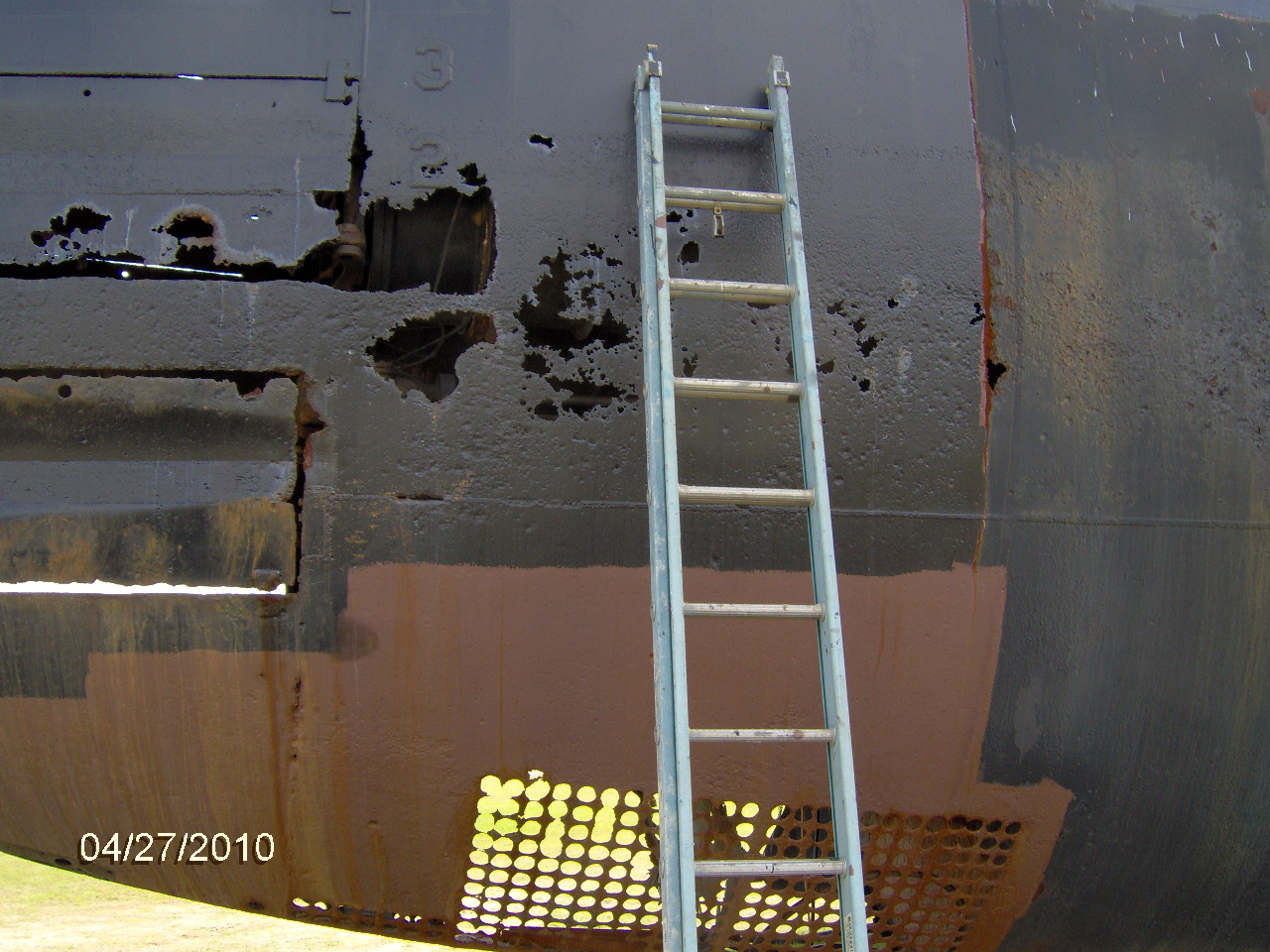

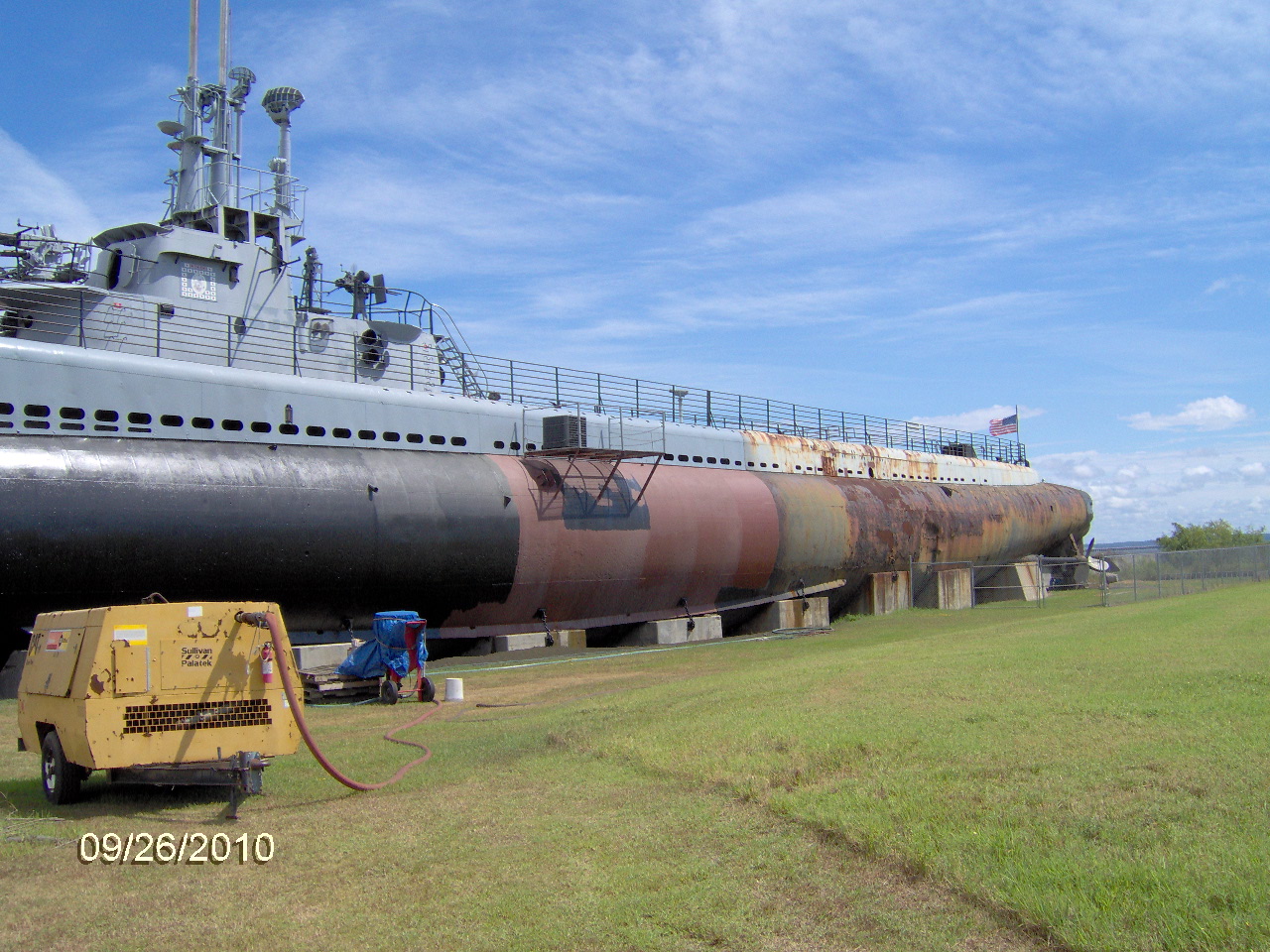

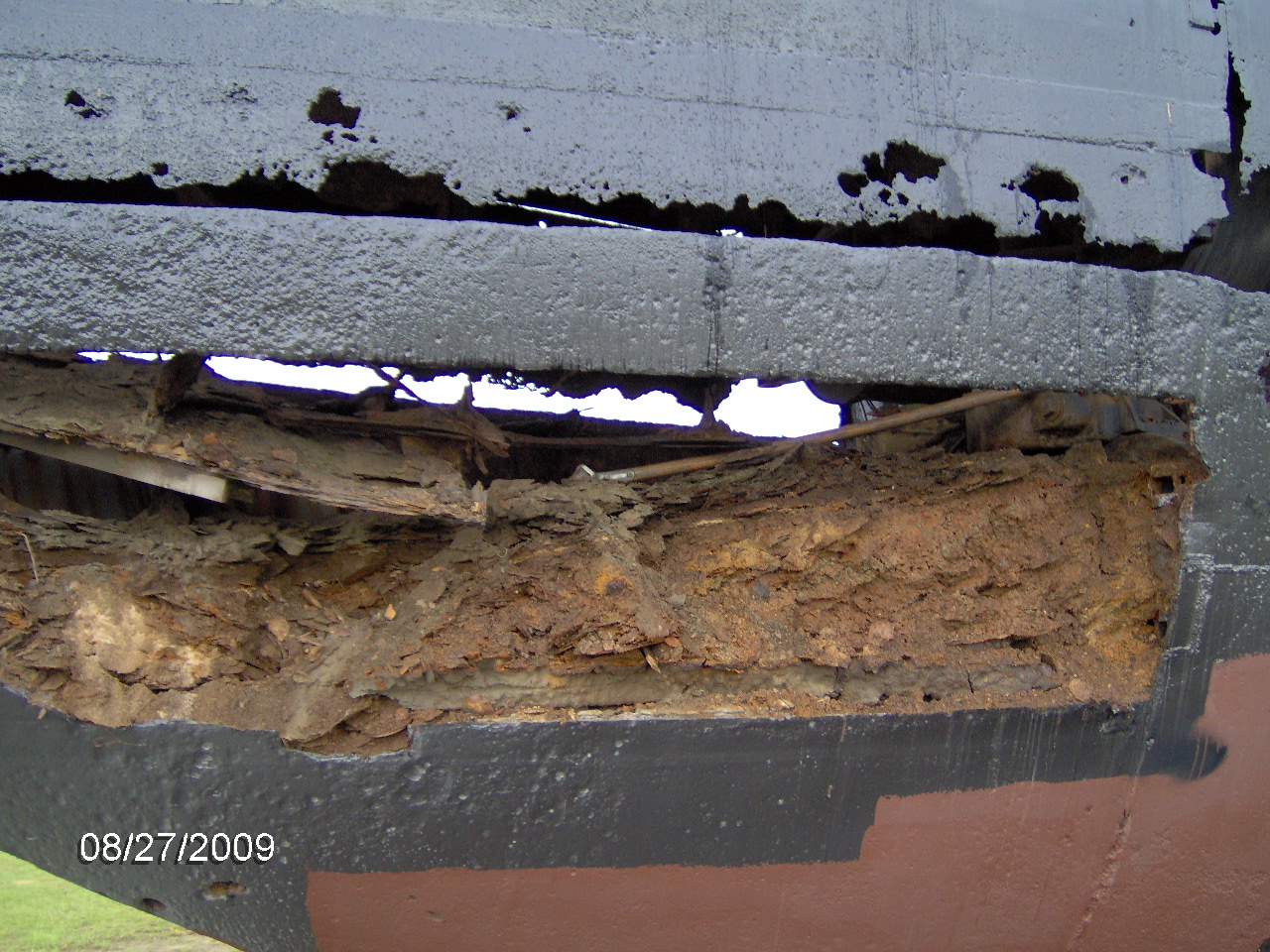

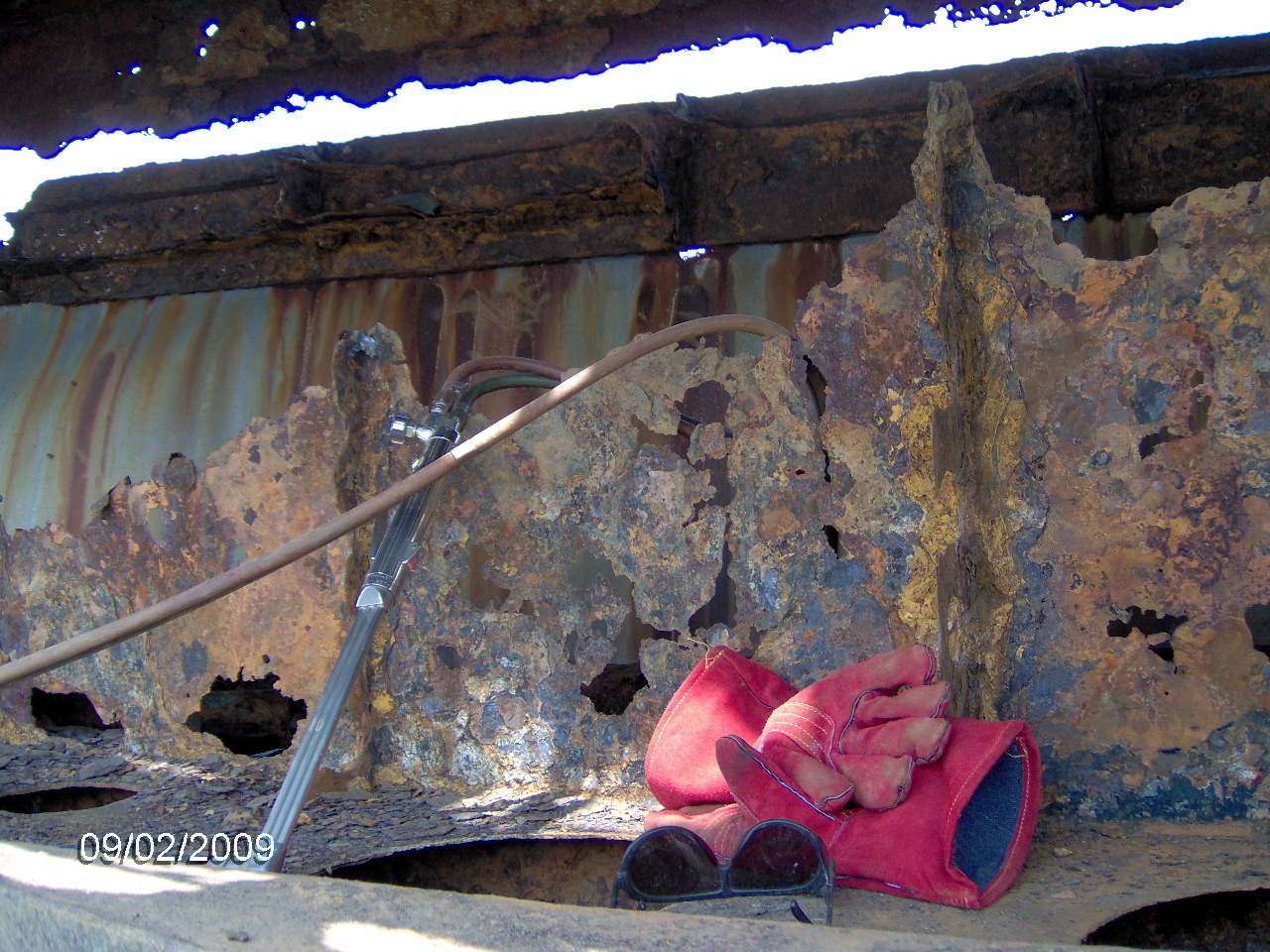

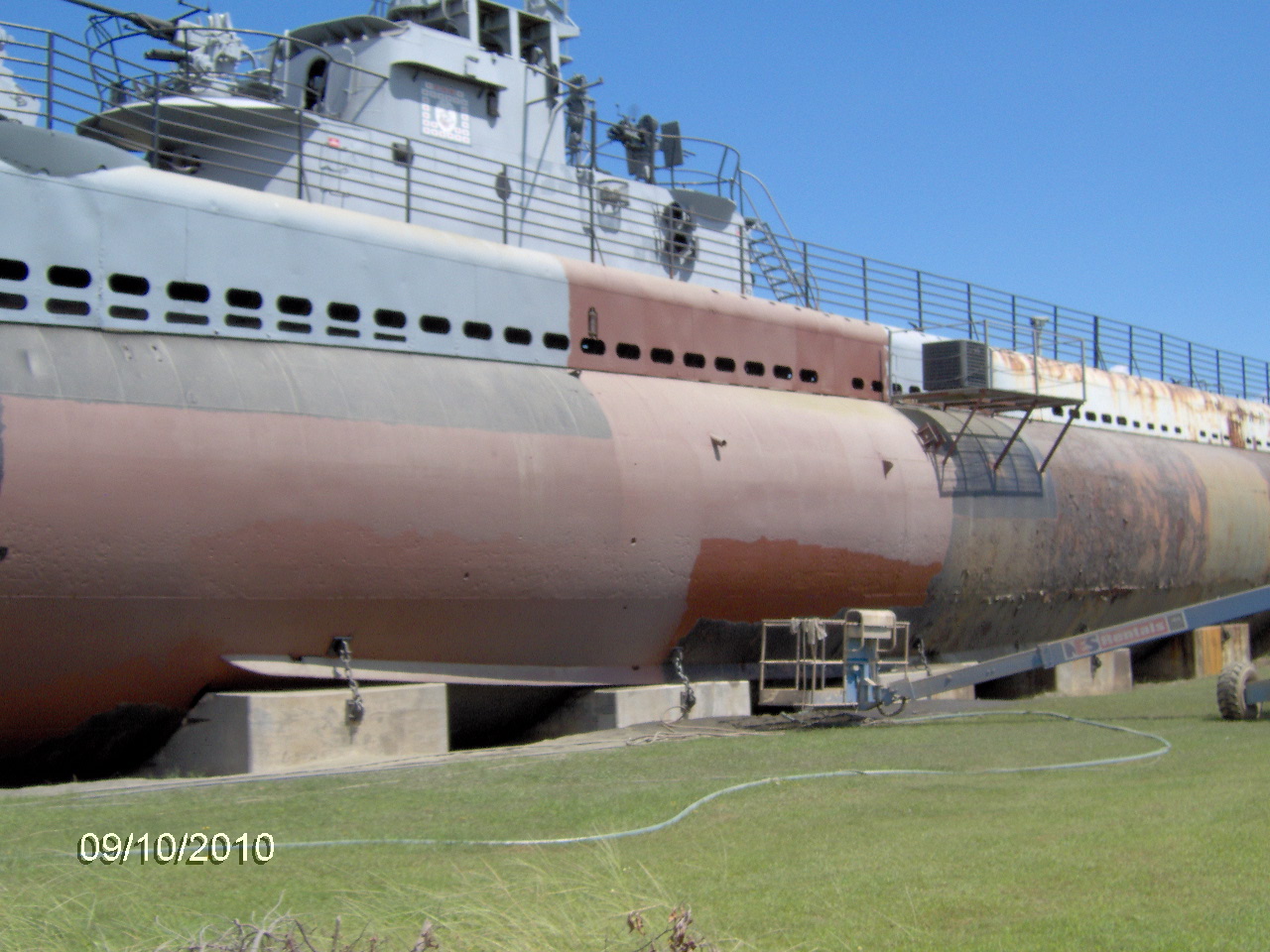

Bow restoration is now fully underway. Tom and Lesley are having a hard time due to so much deterioration which is making it difficult in finding solid enough steel to weld to. They have started replacing the outer hull with ¼ inch steel plate in small sections to maintain the curves and strength.

September 25th bow work September 16th bow work September 2nd bow work September 2nd bow work

August 2009

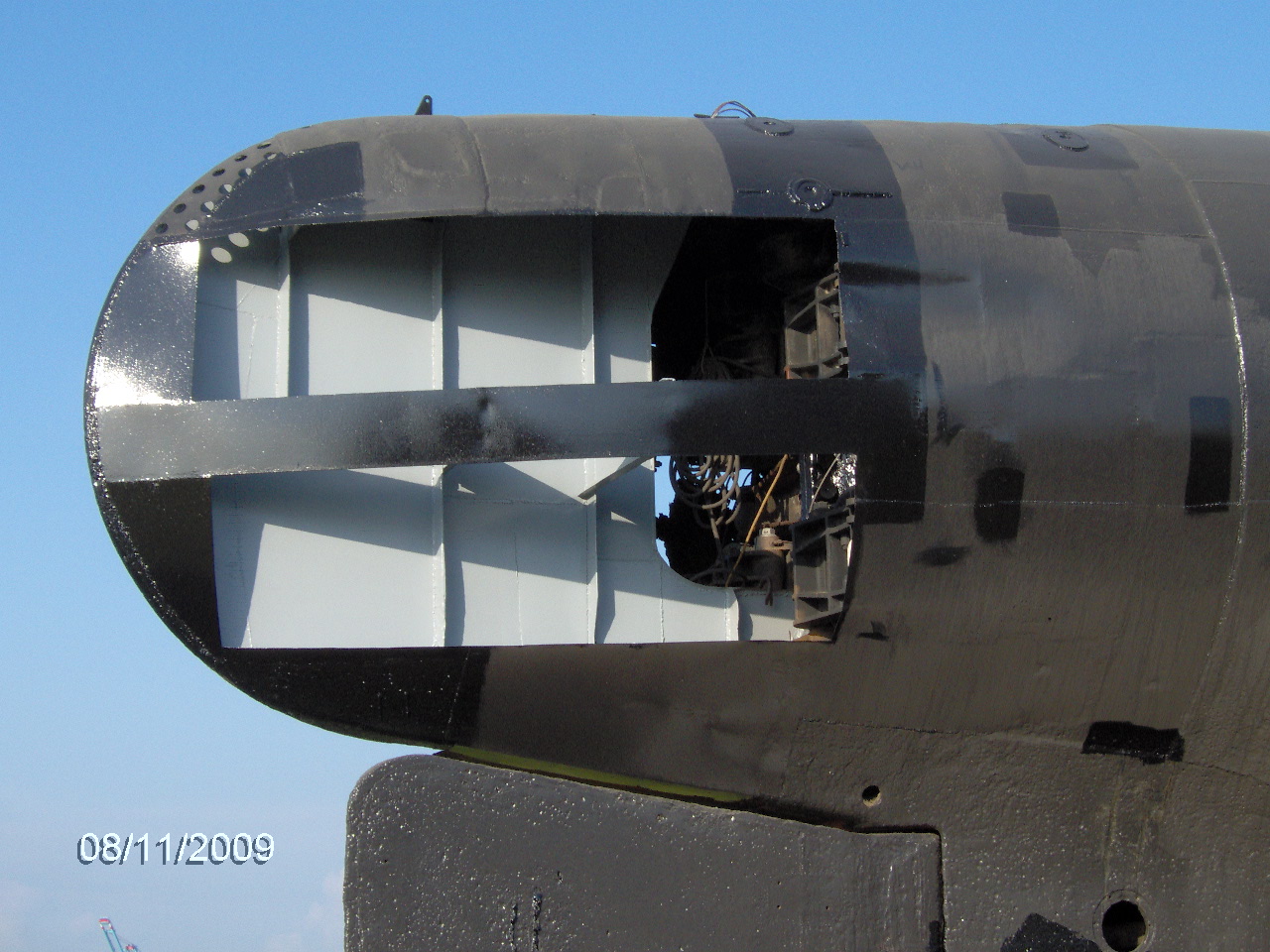

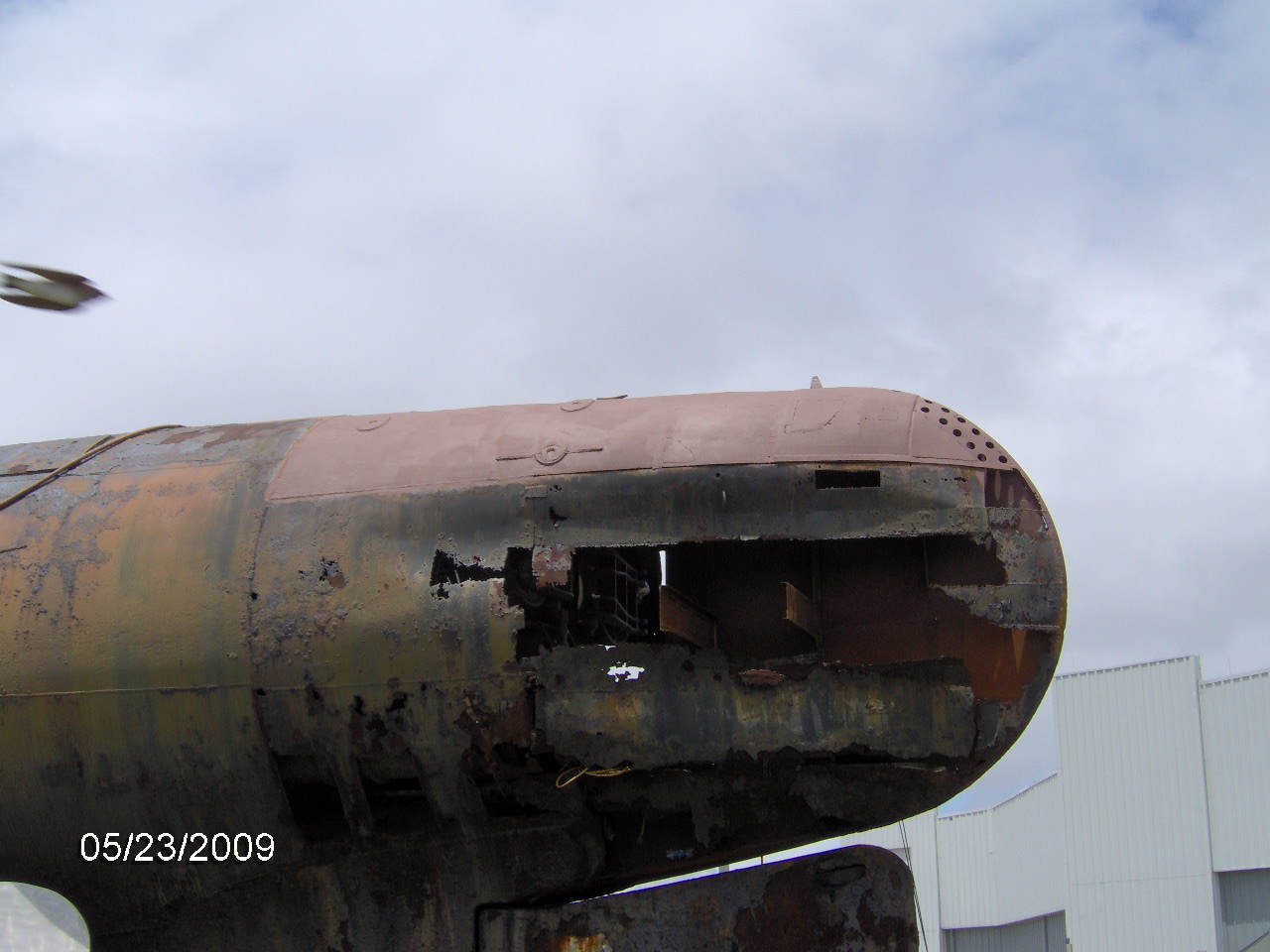

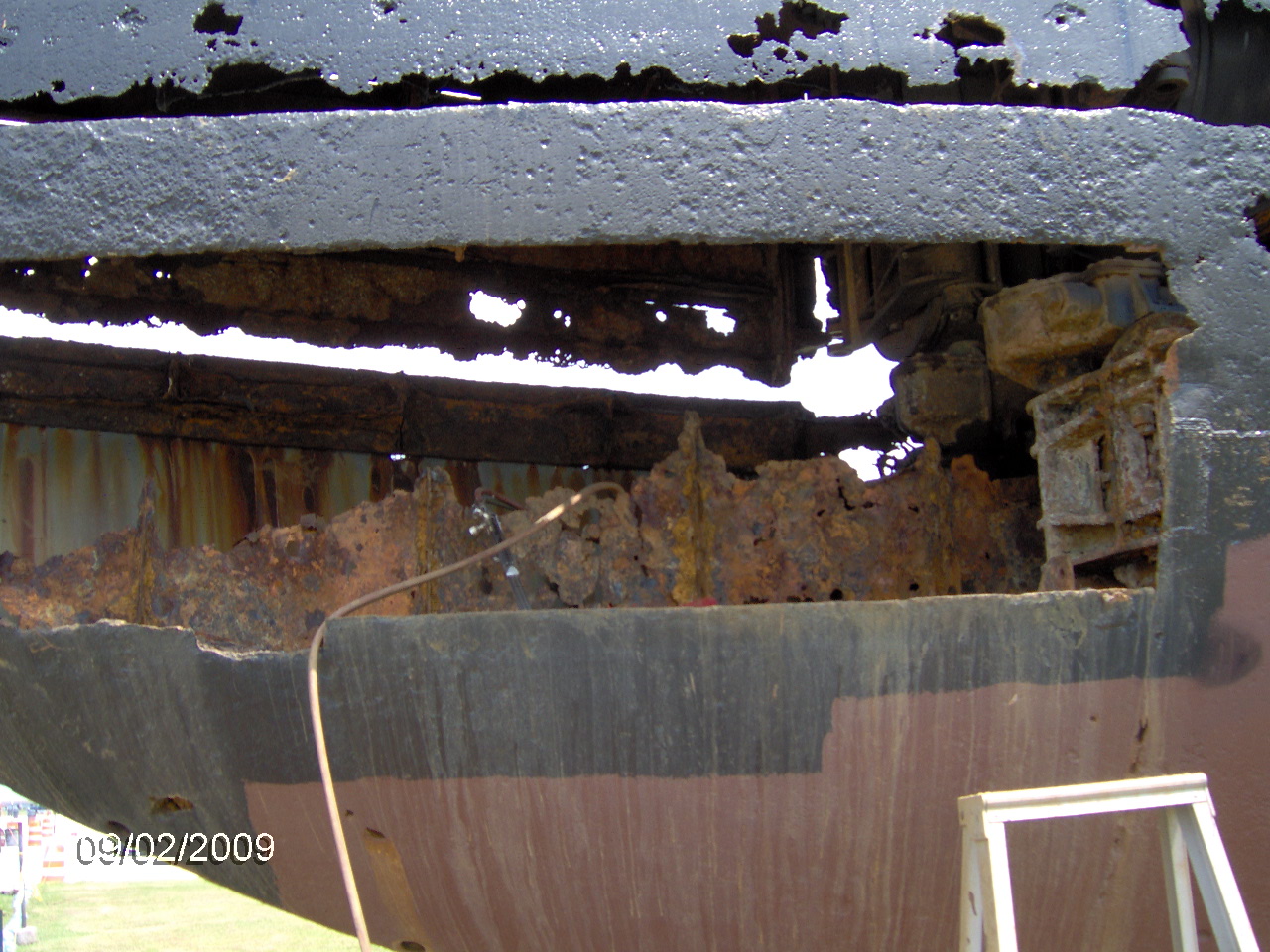

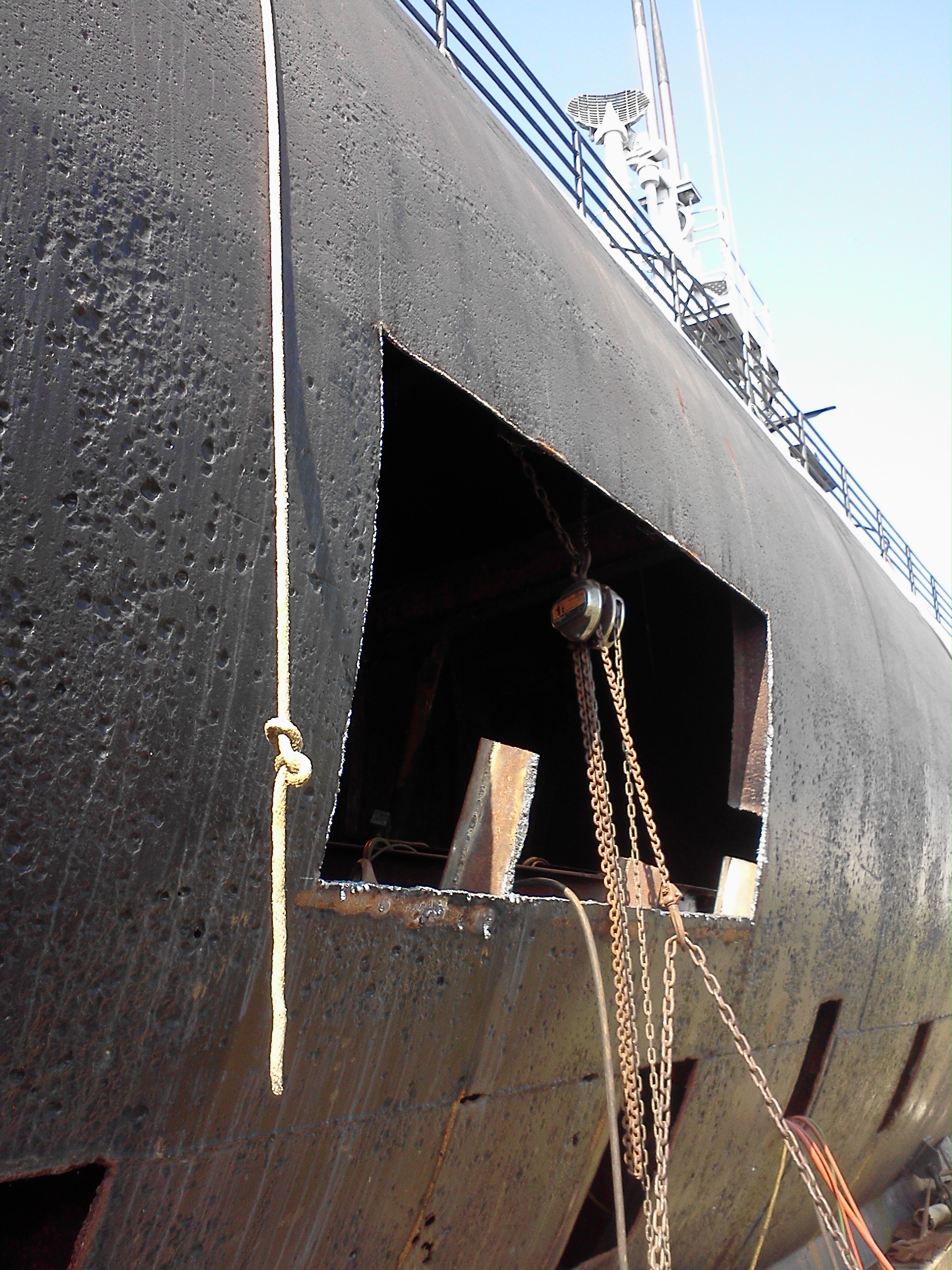

Port side restoration is now in the early stages. Bow restoration is also now in the early stages. Take a look at what was behind the #6 shutter door of the bow!

August 26th starboard painted August 26th port bow August 27th #6 bow shutter door removed

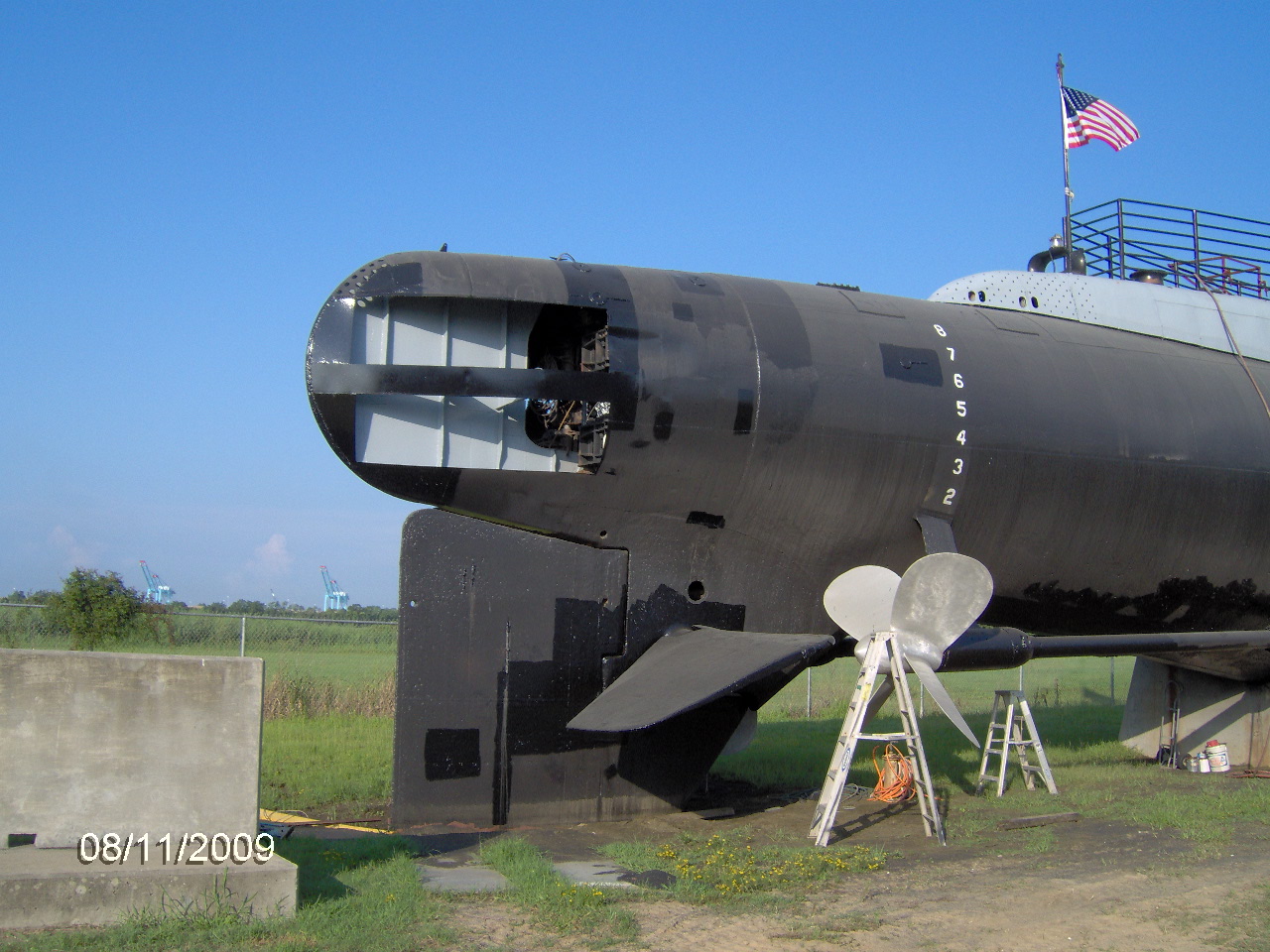

The starboard side of the stern has been painted. Cleaning, priming, and painting are underway of the starboard side now.

August 11th stern painted August 11th stern painted August 11th starboard side painted

July 2009

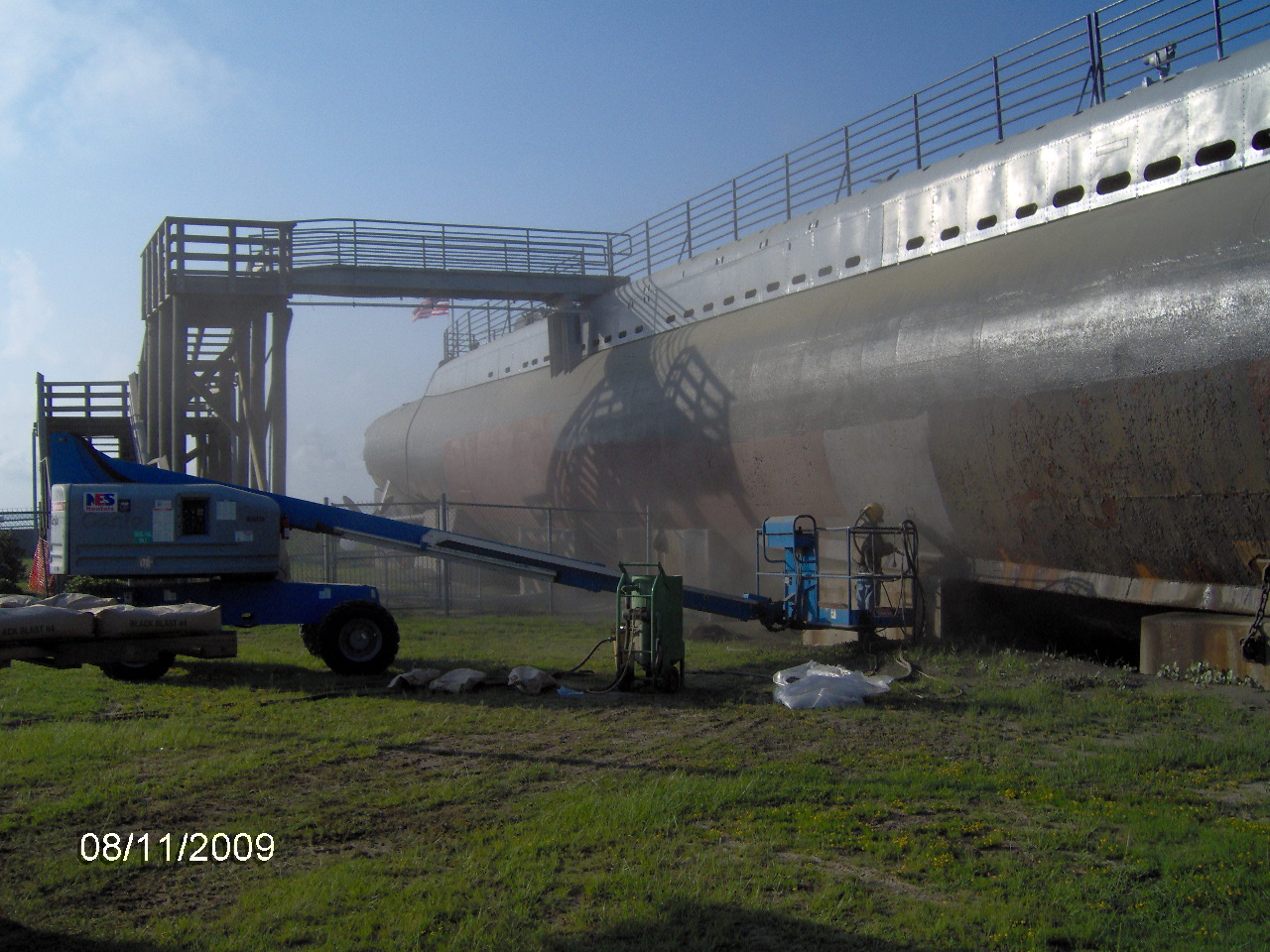

The starboard side of the stern has been primed.

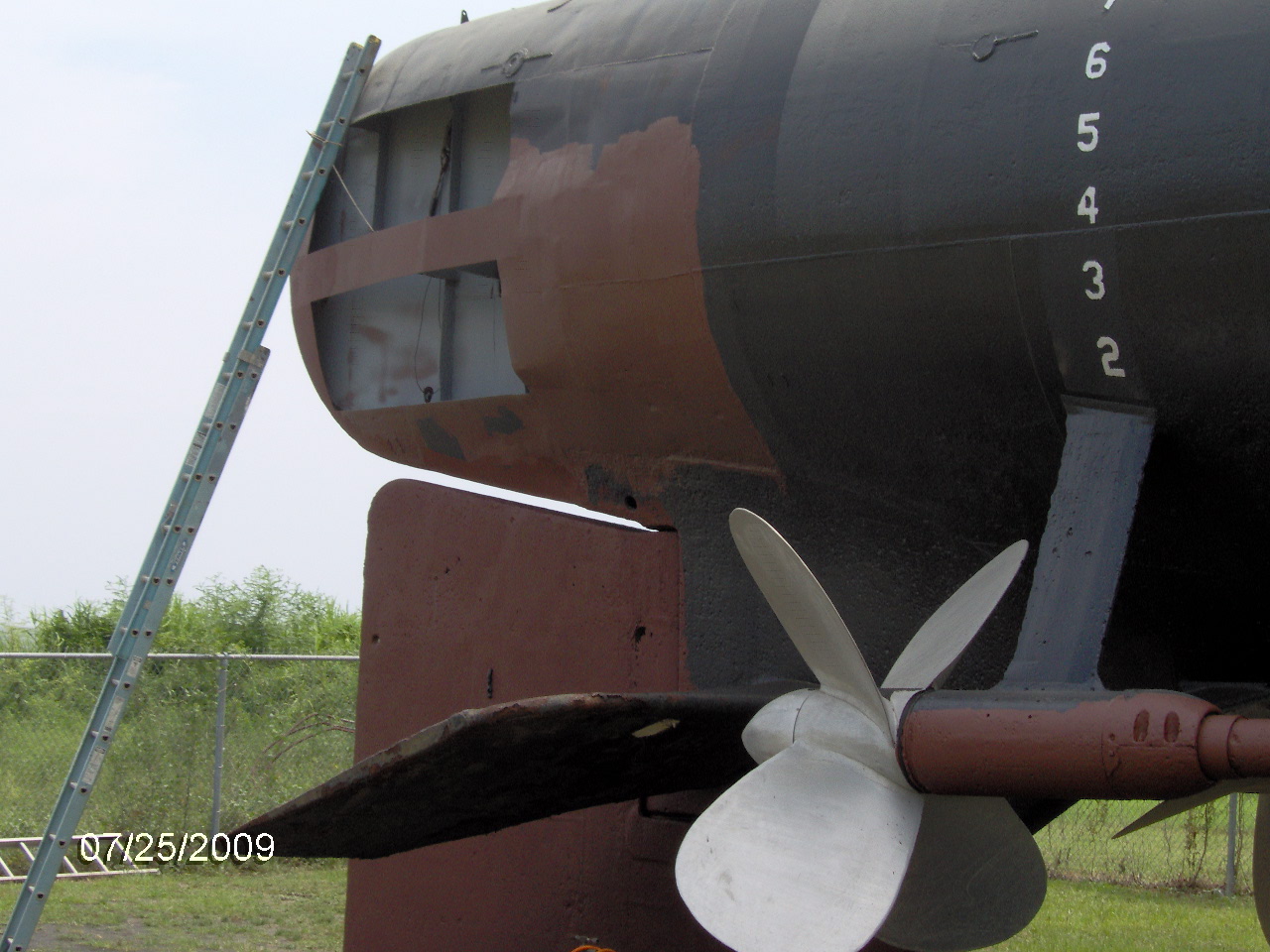

July 25th stern primed

Stern restoration.

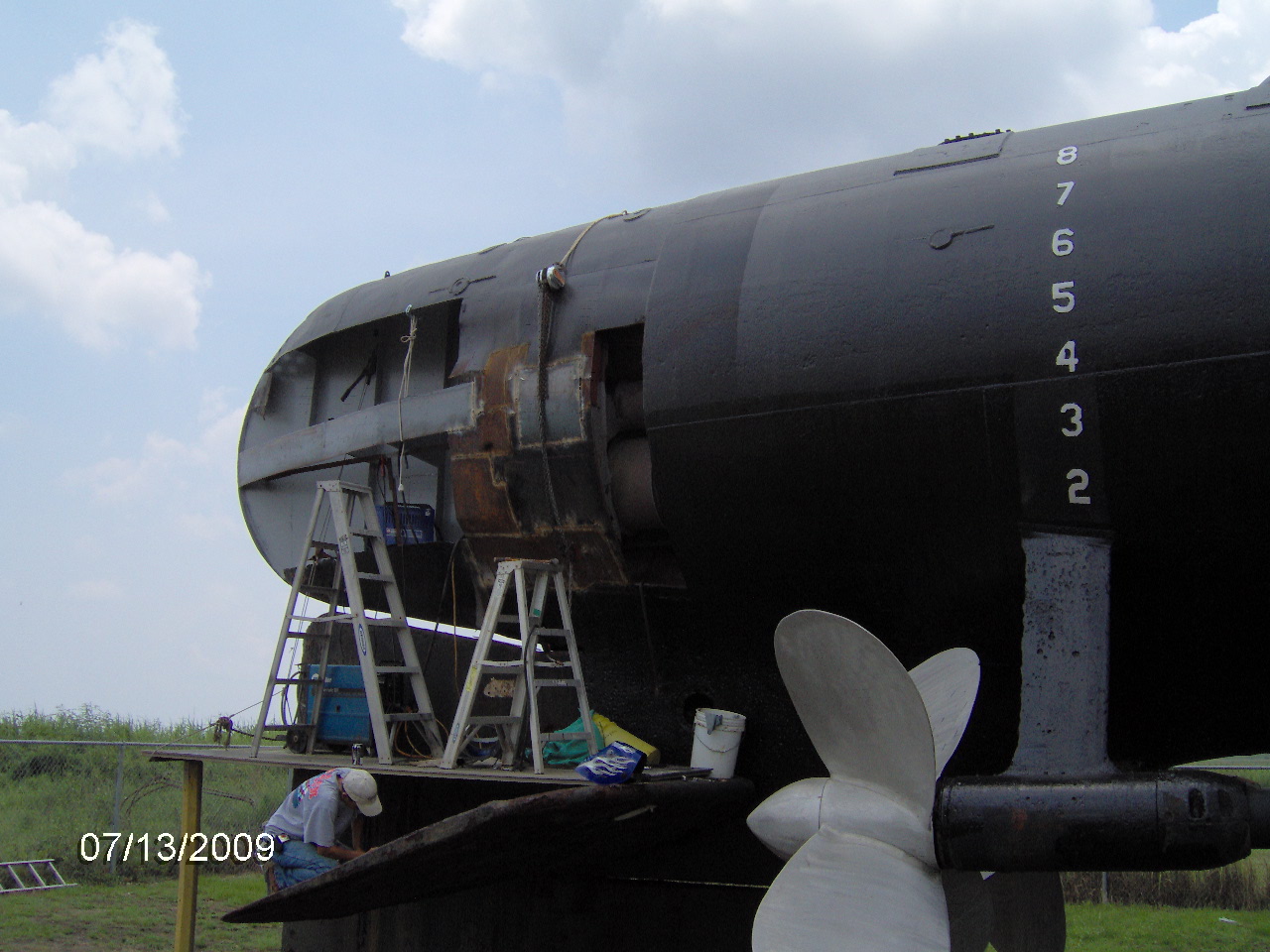

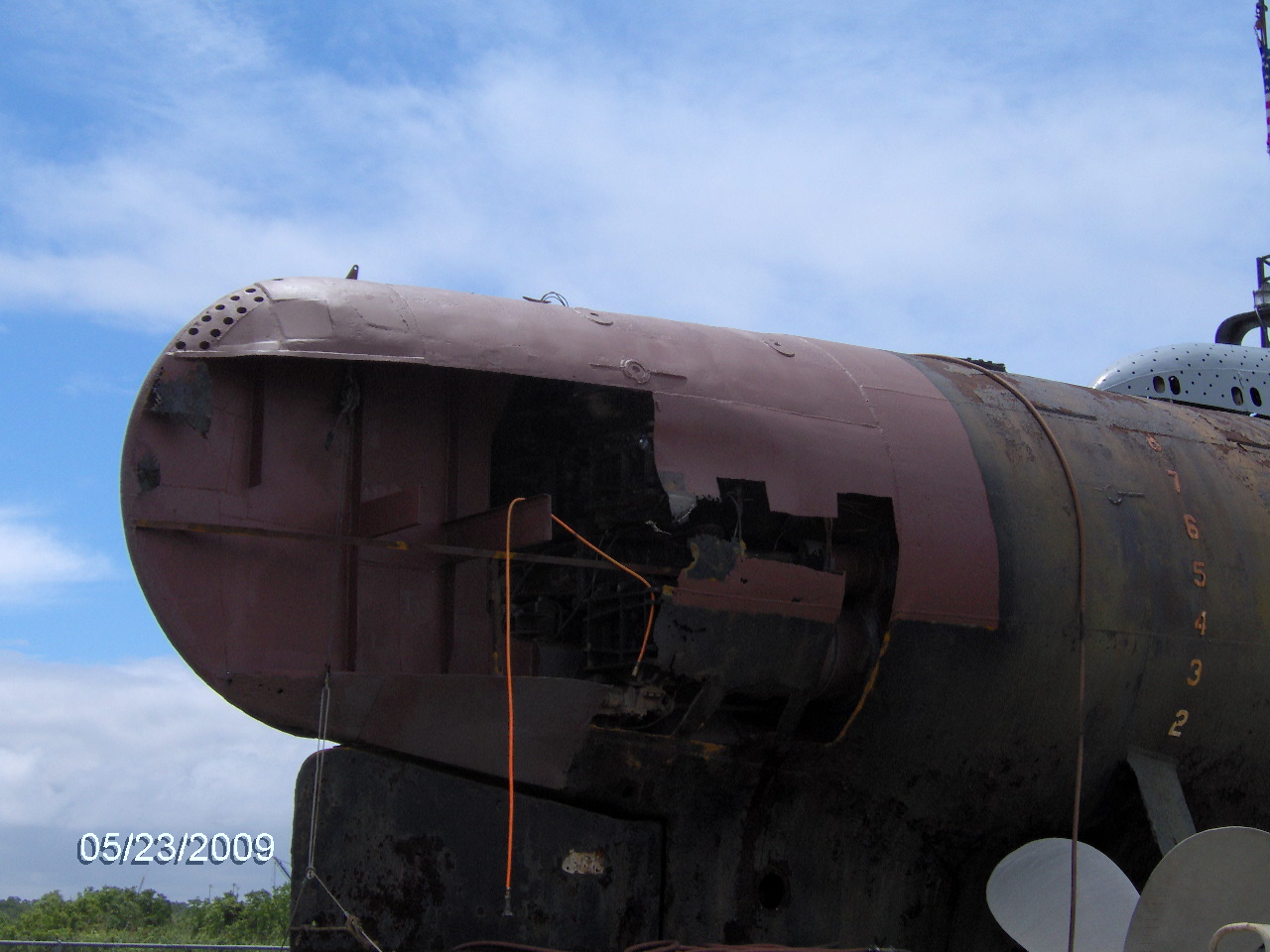

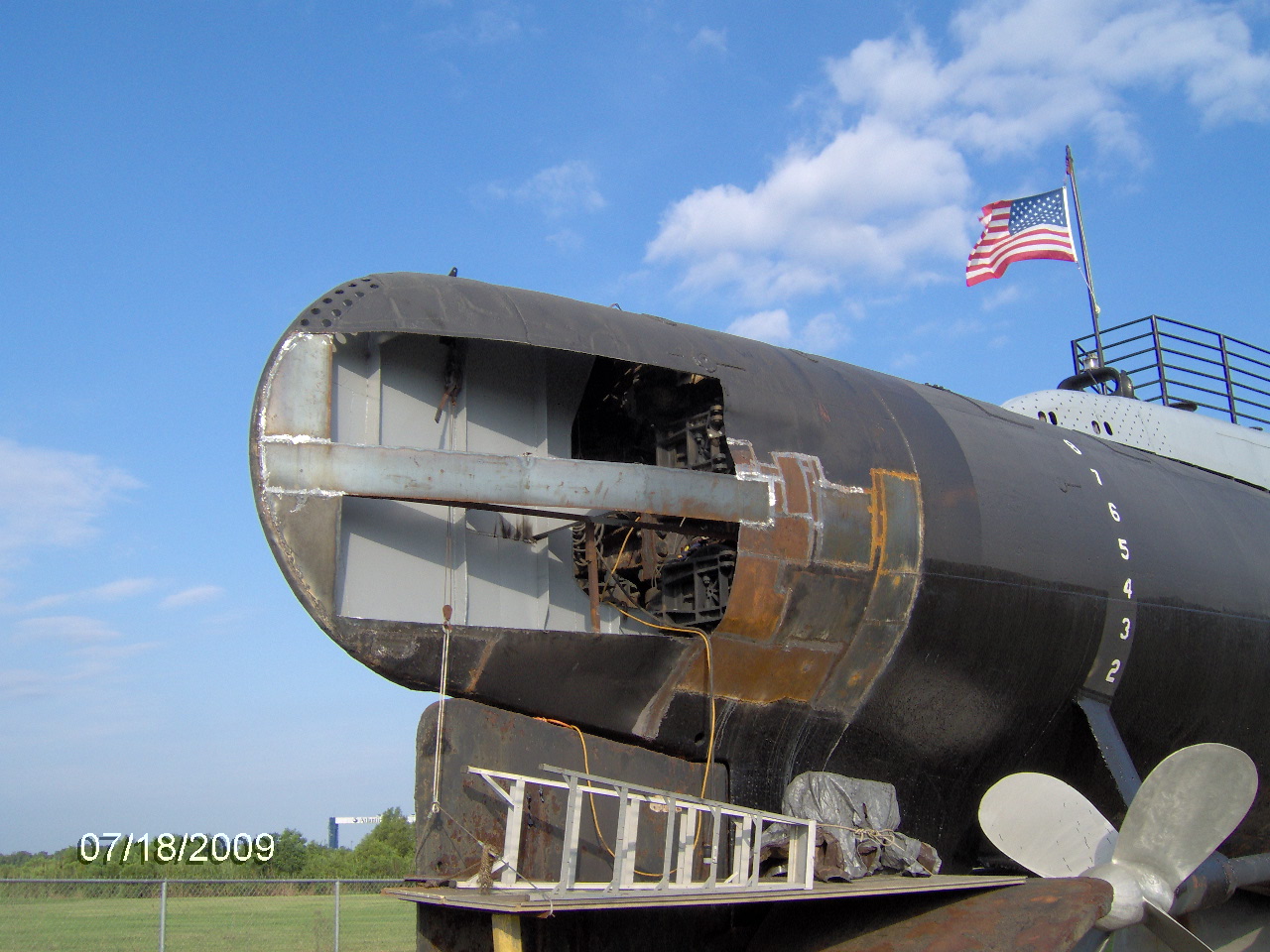

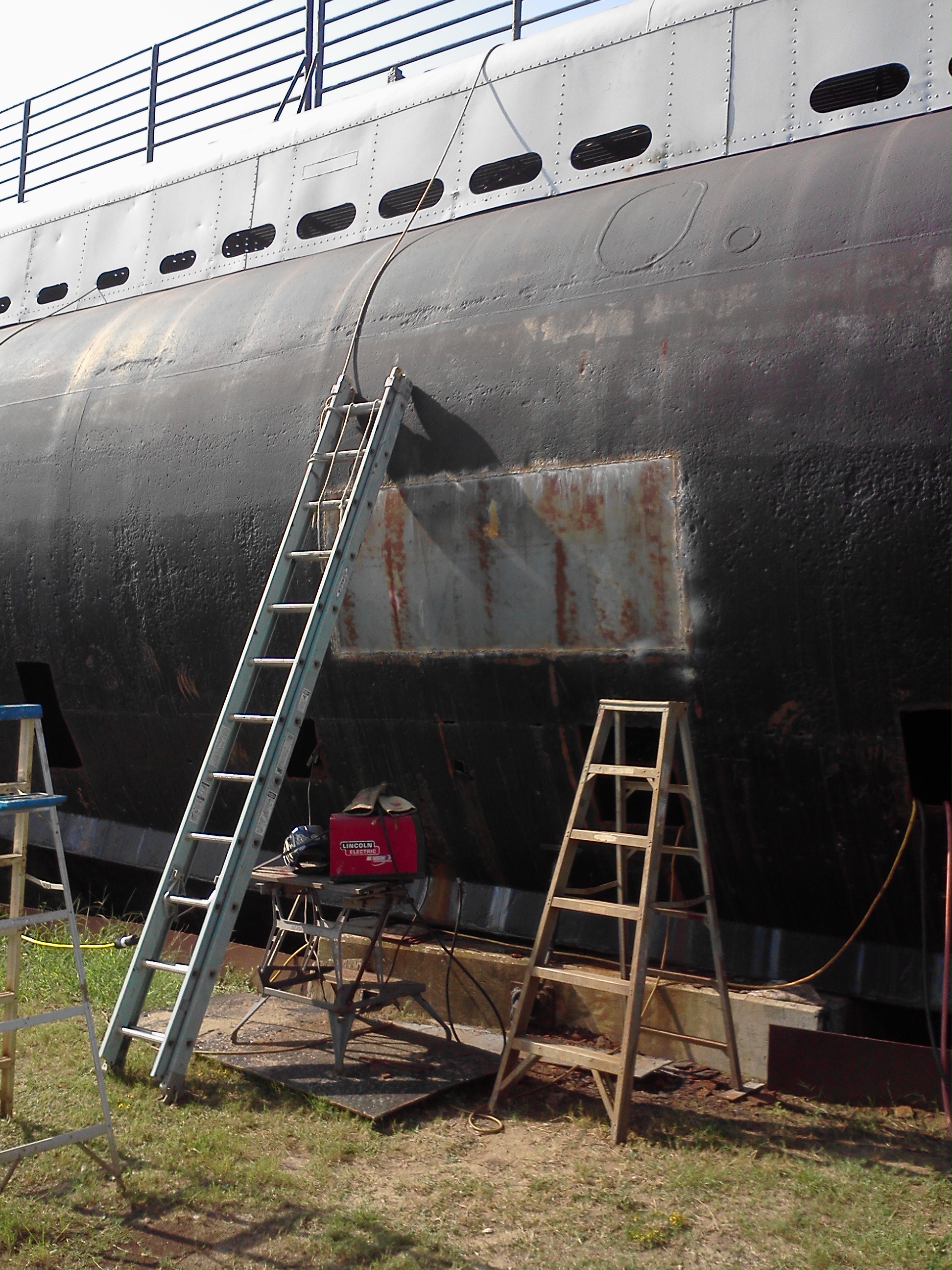

July 13th July 18th July 18th

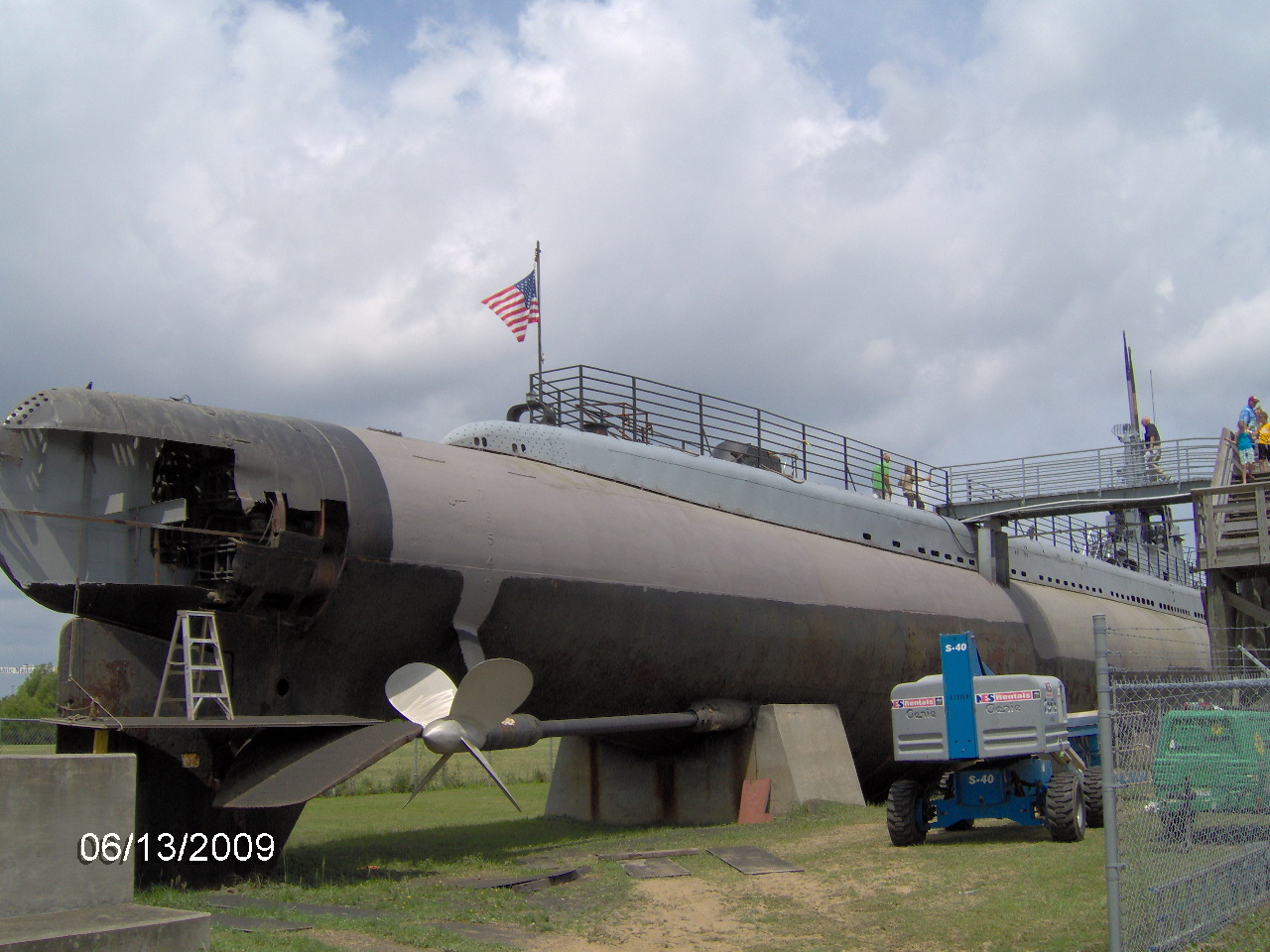

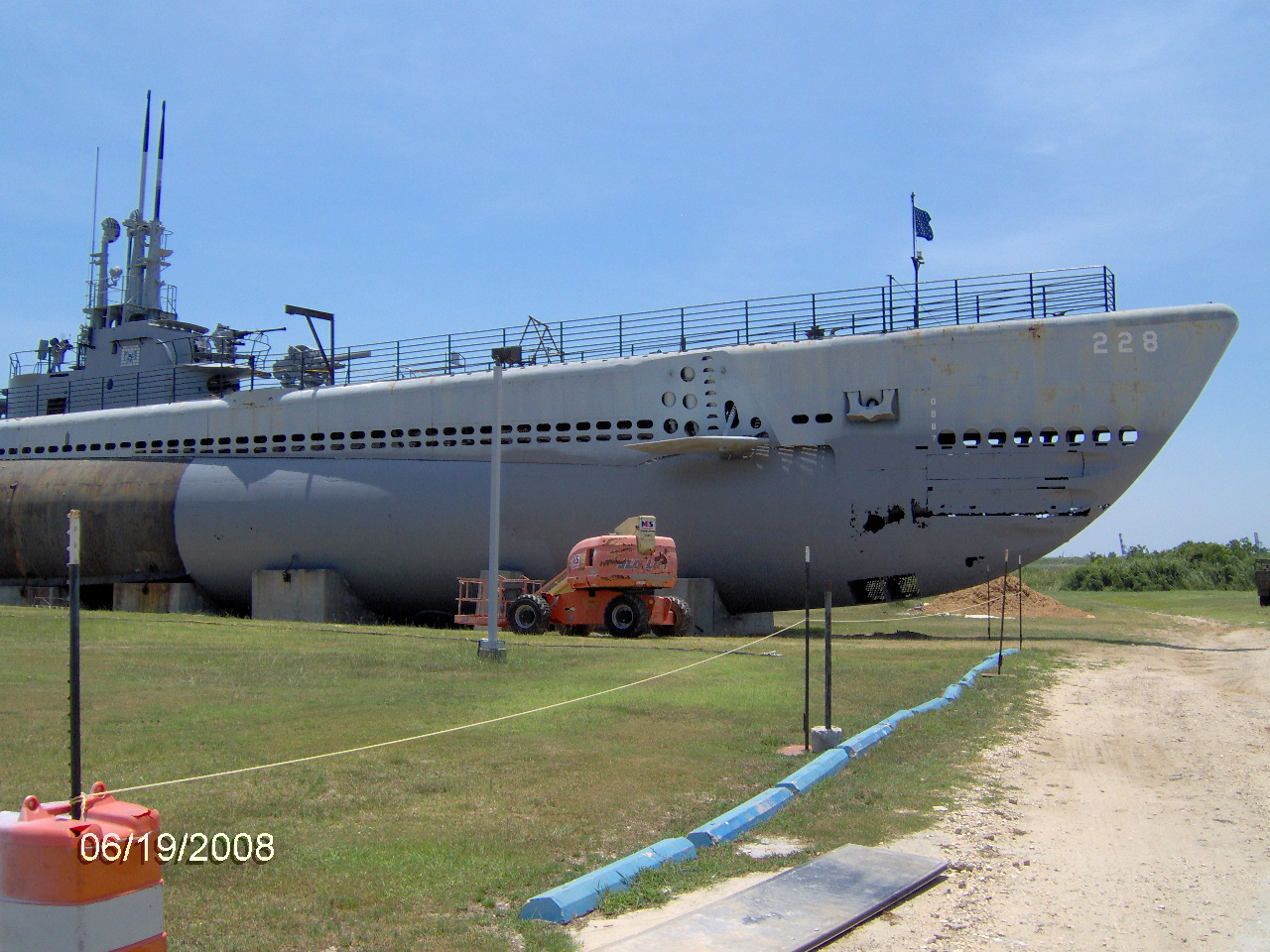

June 2009

Further progess with sandblasting/priming/painting. This is how the Drum looked for the 2009 USS Drum Reunion.

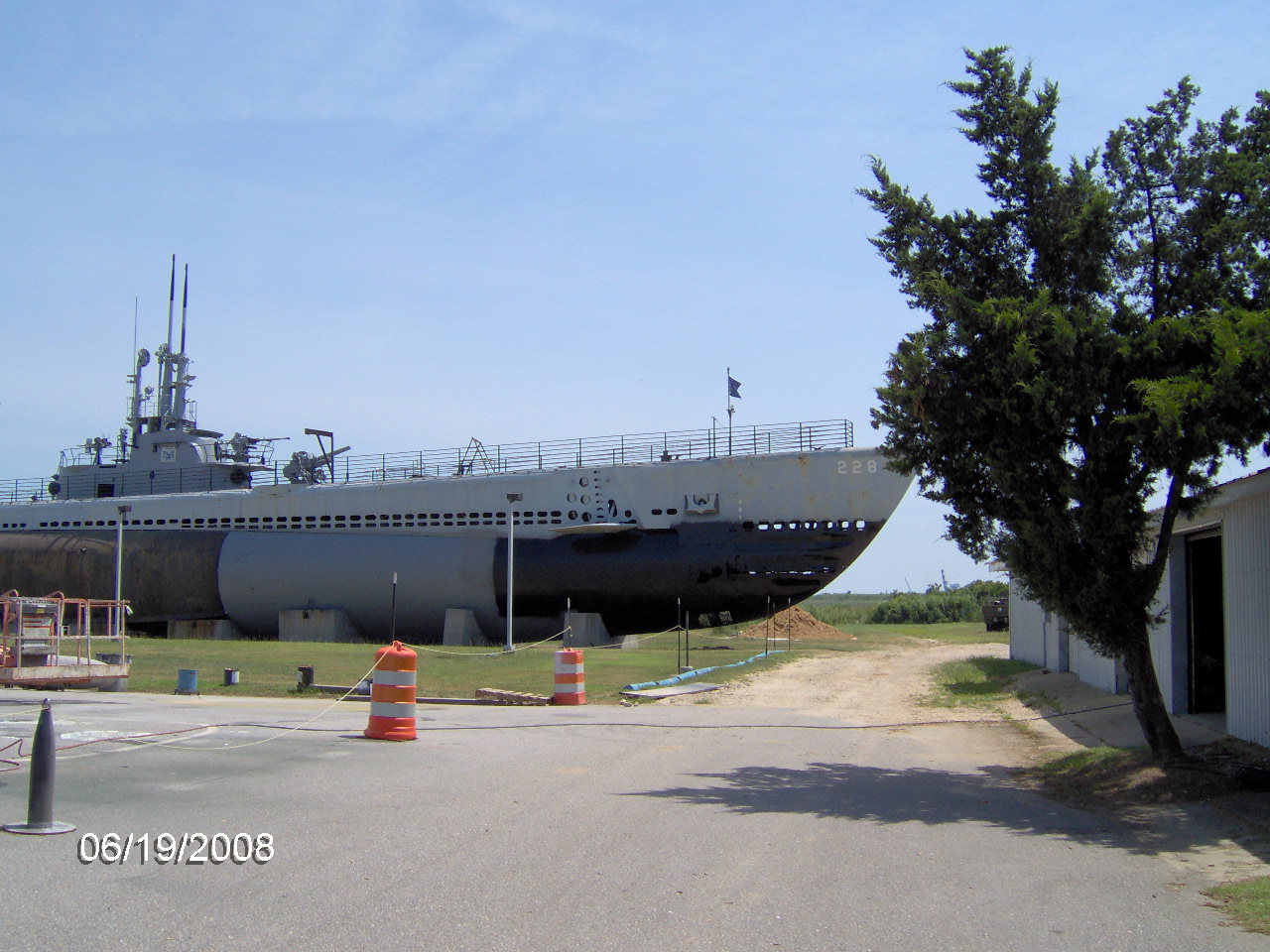

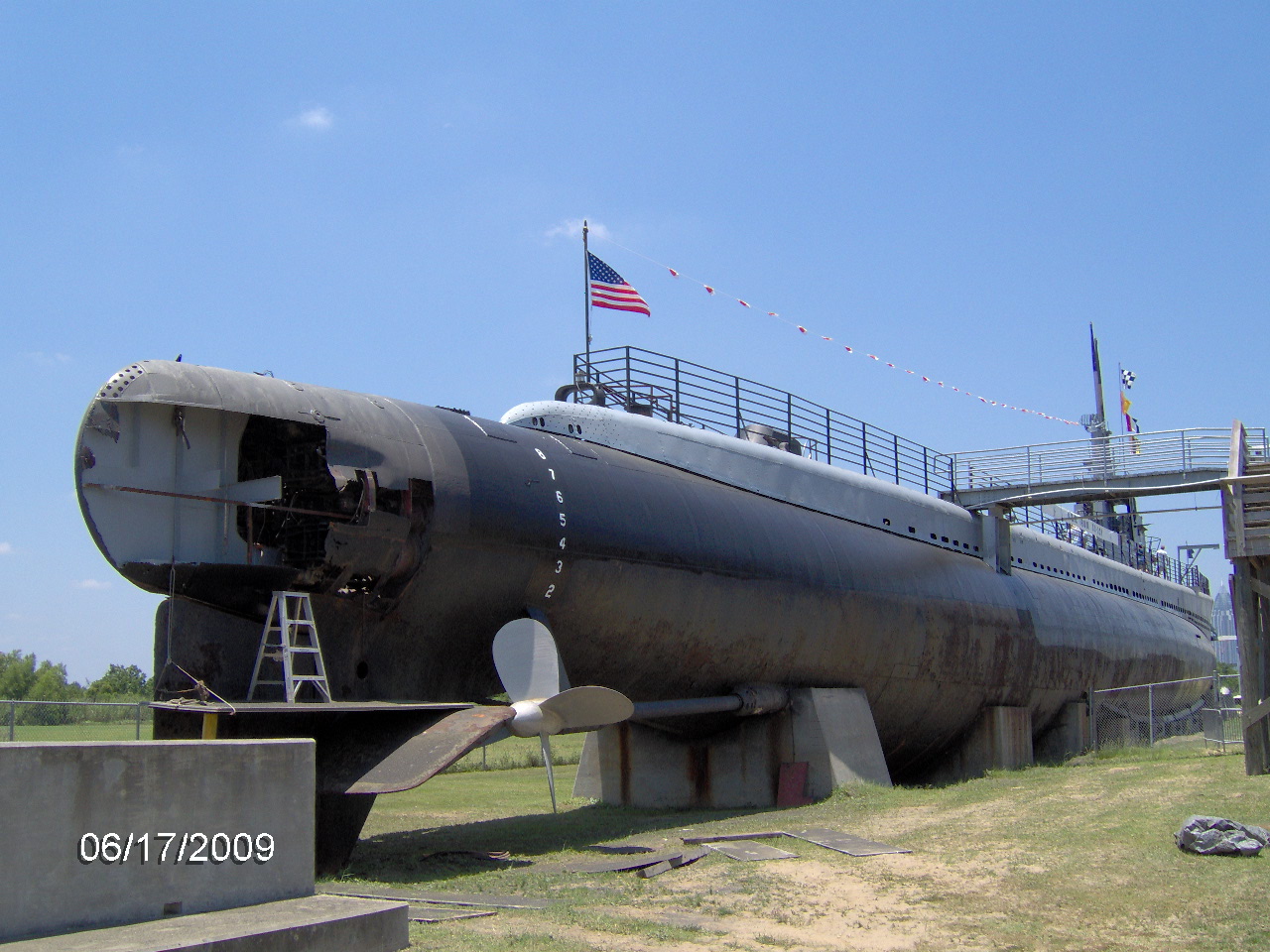

June 17th June 17th June 17th

More restoration and priming/painting of the starboard side and bow.

bow restoration stern restoration starboard side restoration

May 2009

More stern restoration and priming/painting of the starboard side.

stern restoration starboard restoration

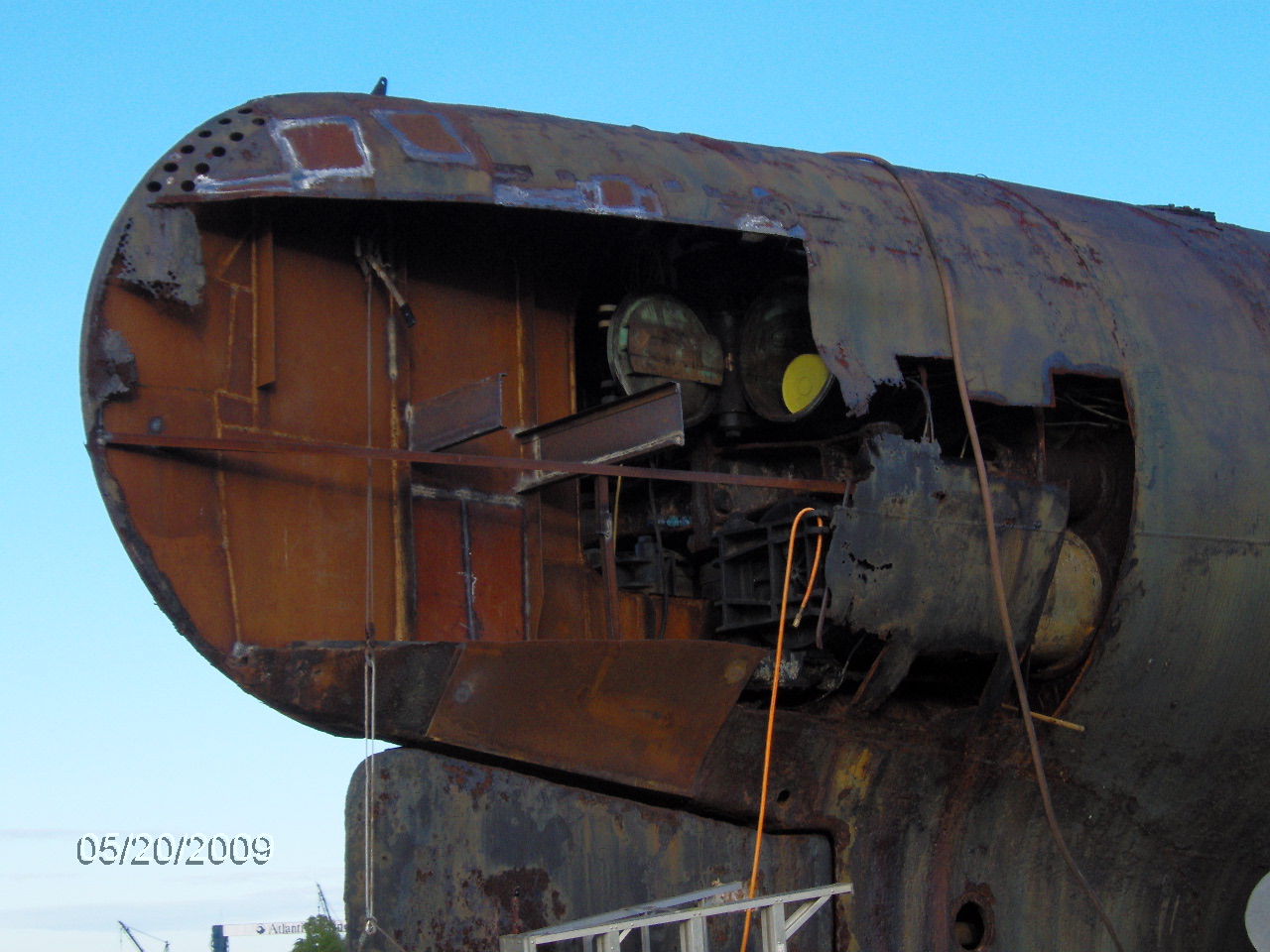

Stern restoration picks back up where it was left off in November, 2008.

stern restoration stern restoration

Cleaned, primed, and painted the periscope shears. Below you see a before photo, a during photo, and an after photo.

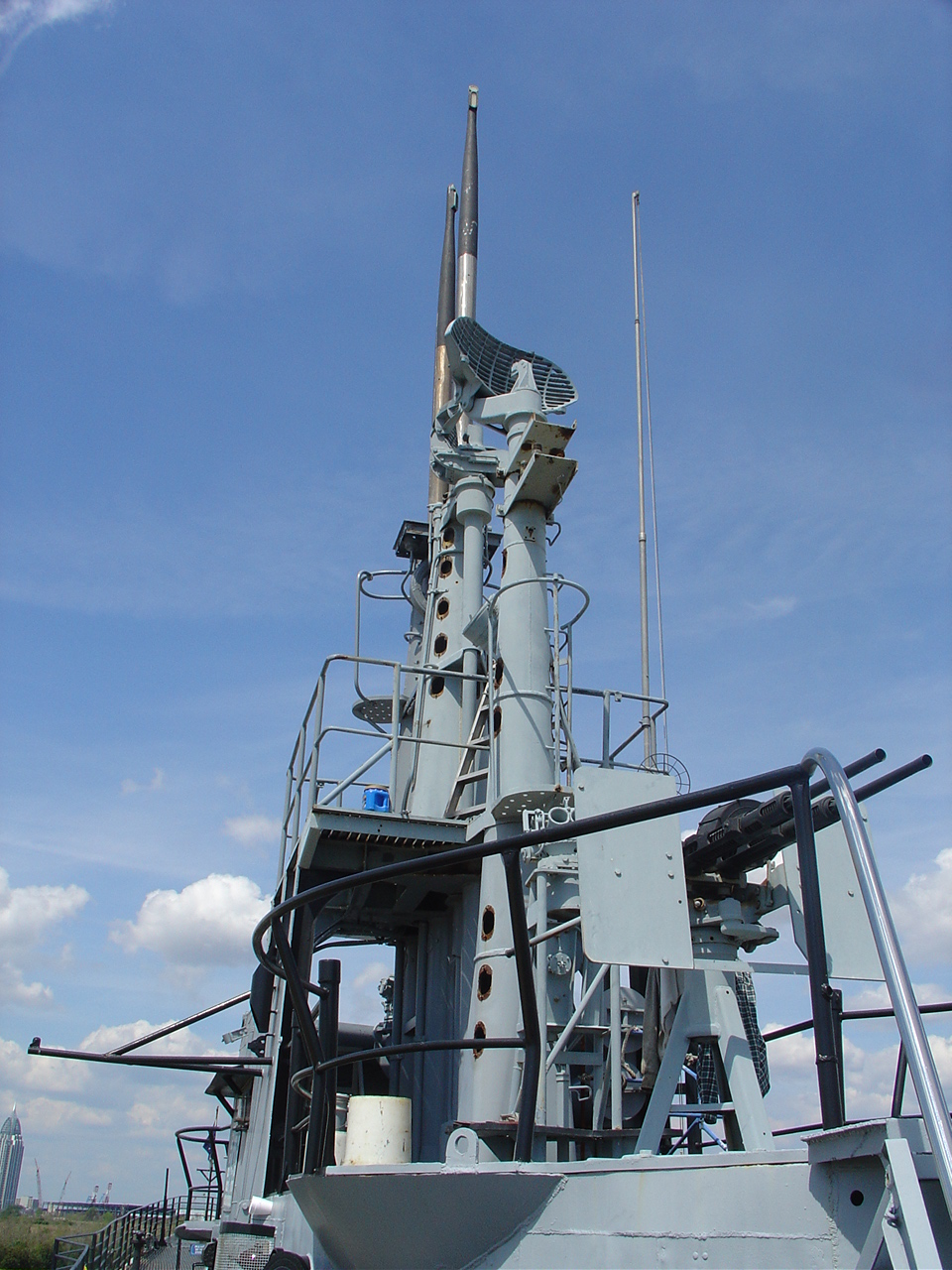

2007 view of periscope shears March 2009 view of periscope shears while being cleaned View of periscope shears after the painting

February 2009

Restored table in the crew's mess.

Table in crew's mess

January 2009

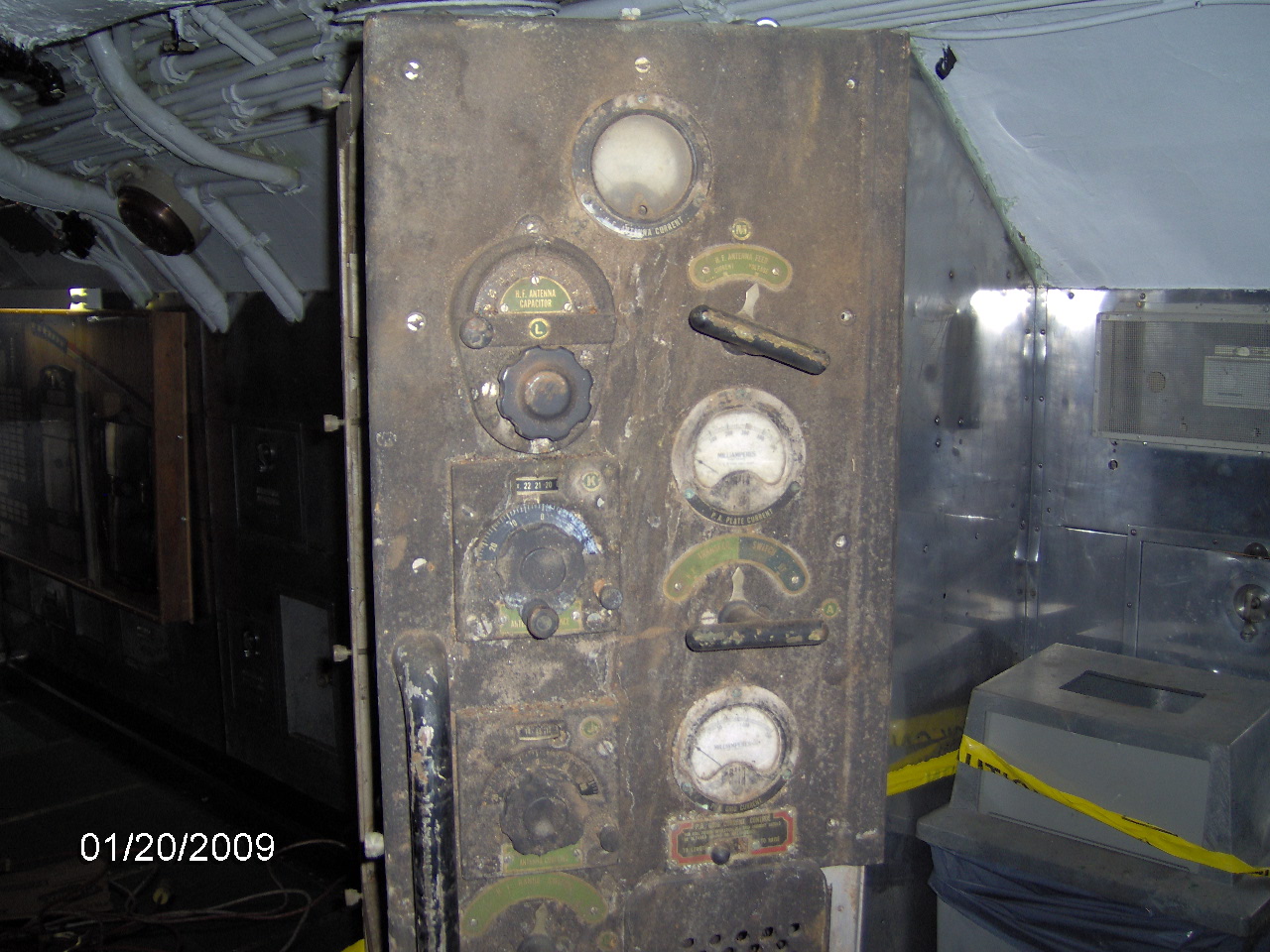

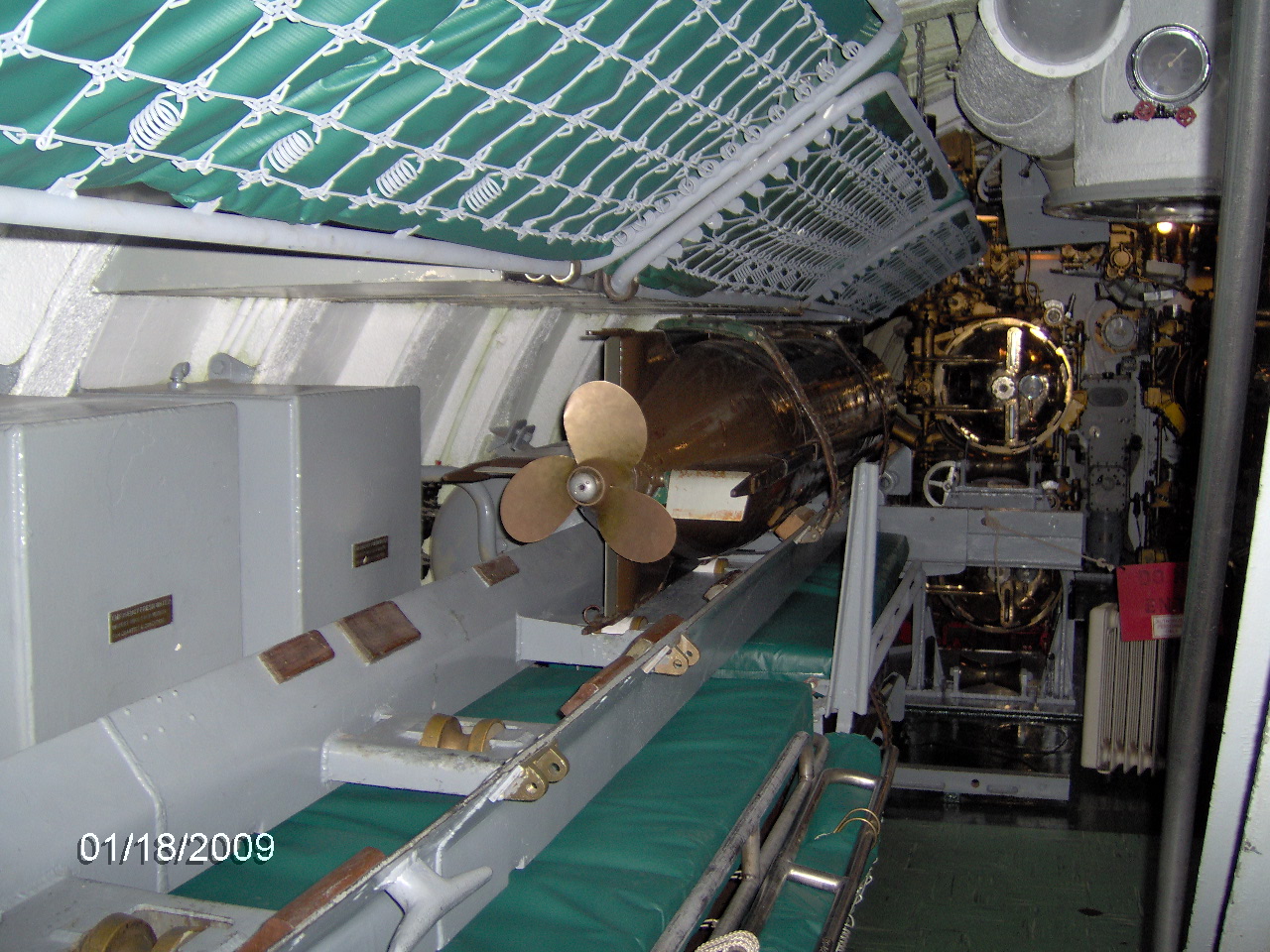

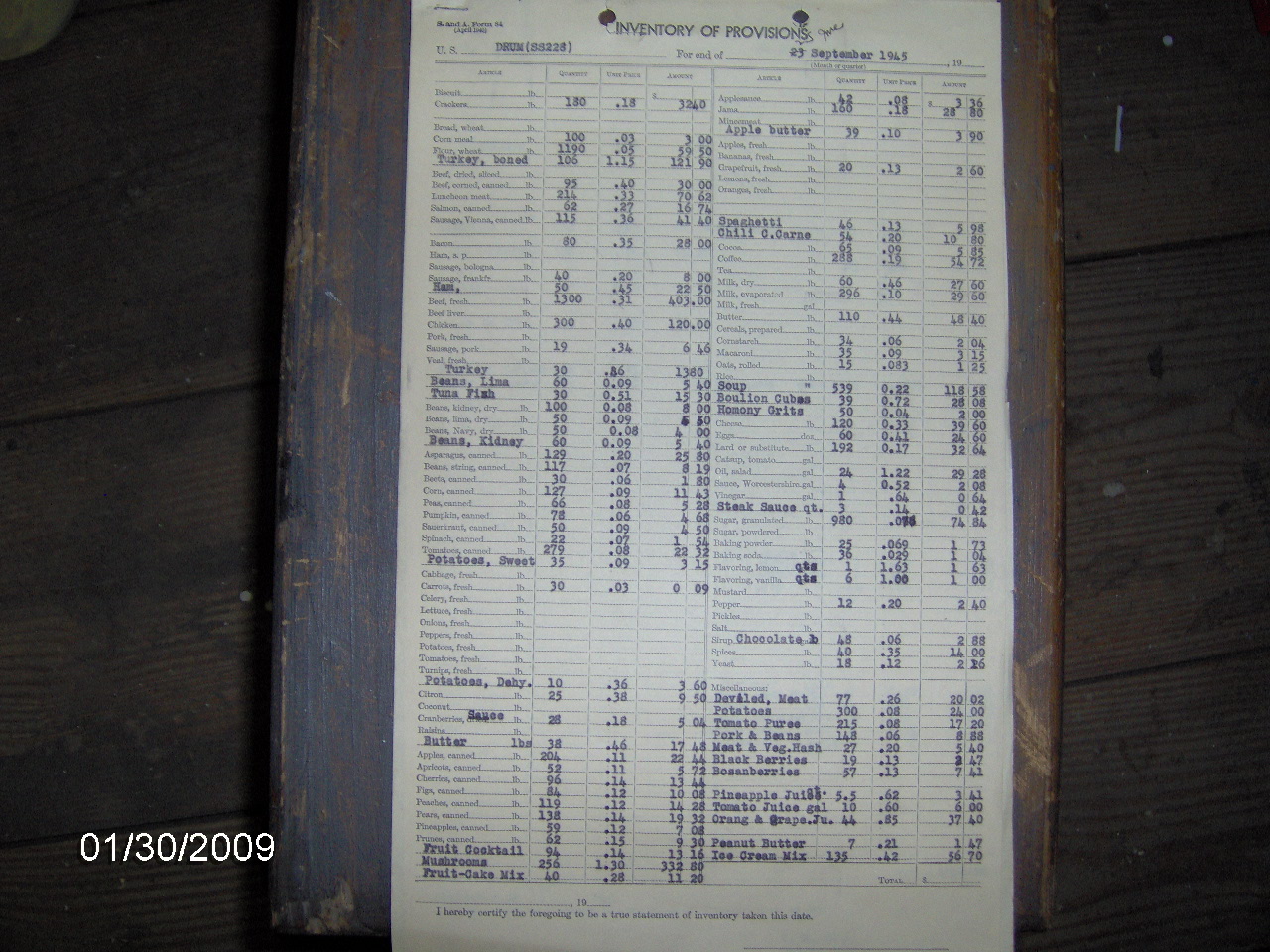

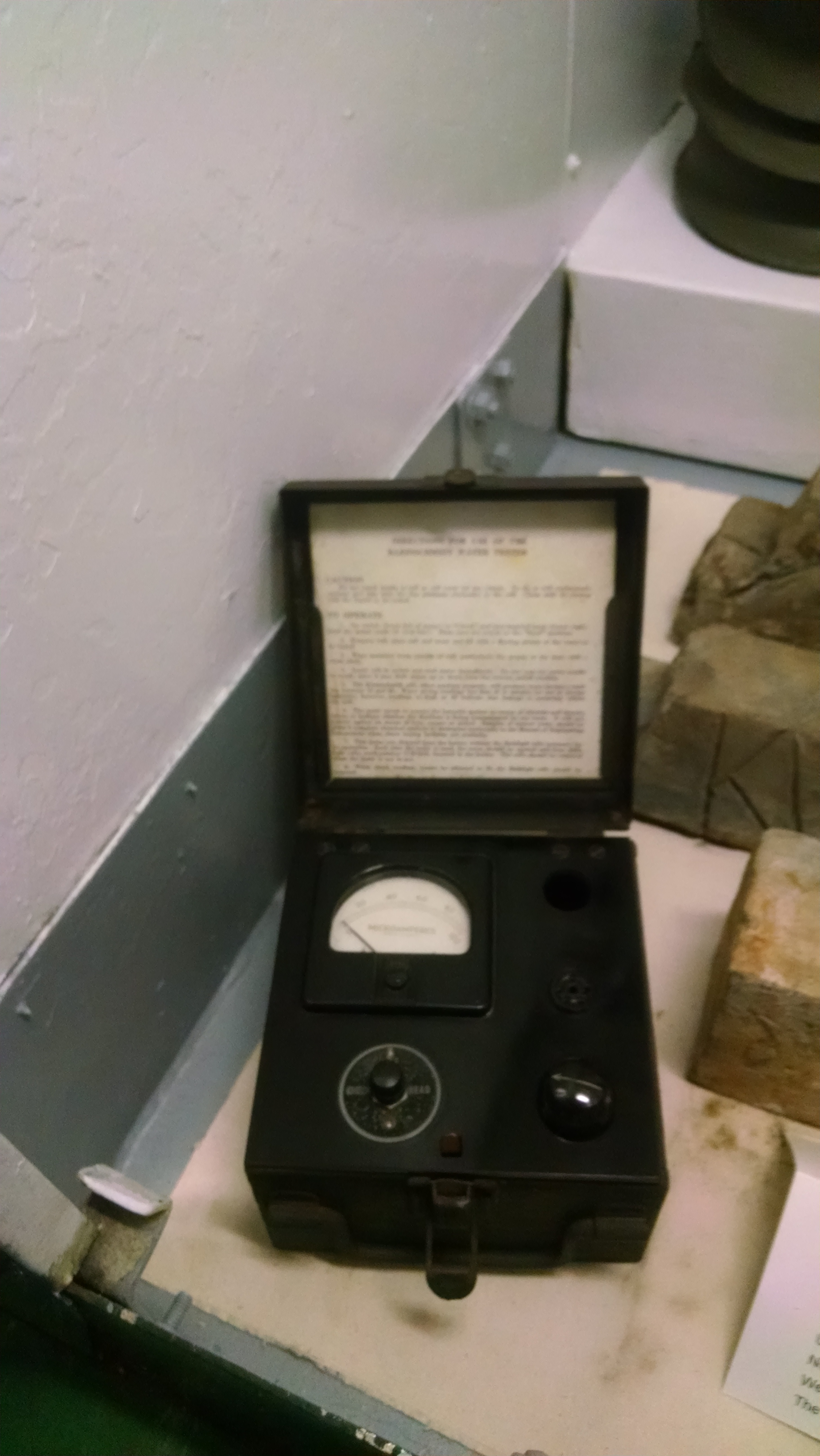

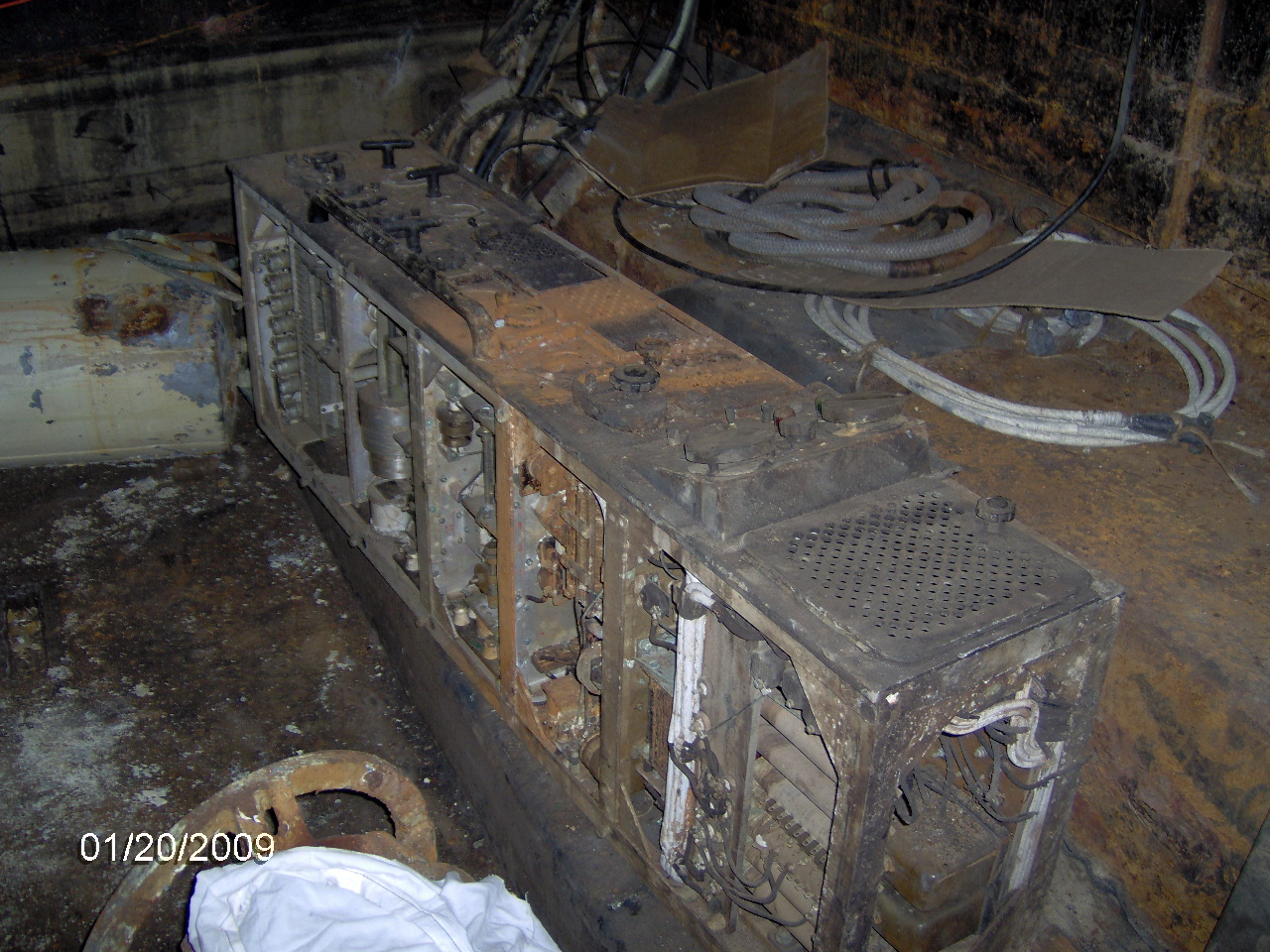

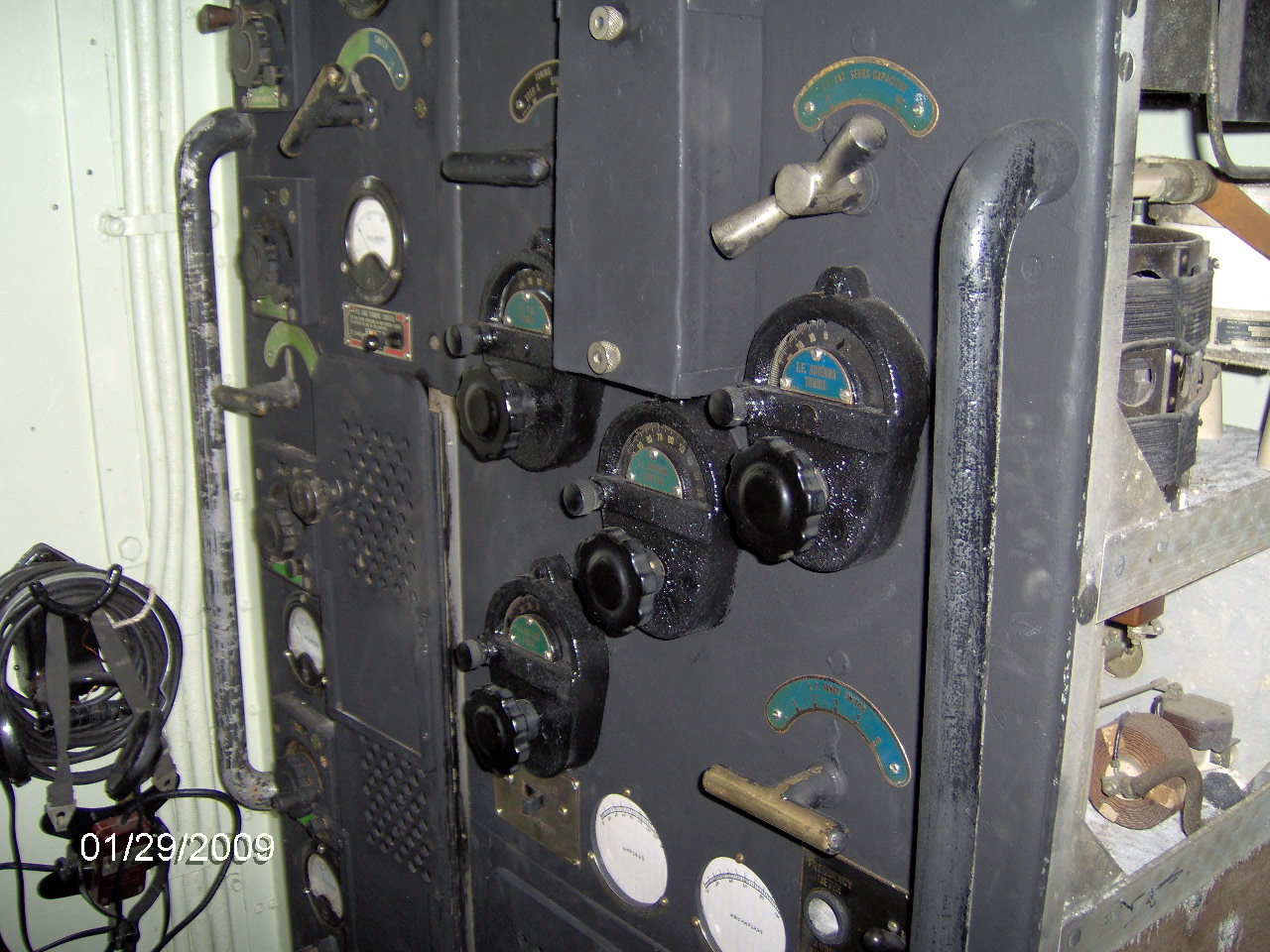

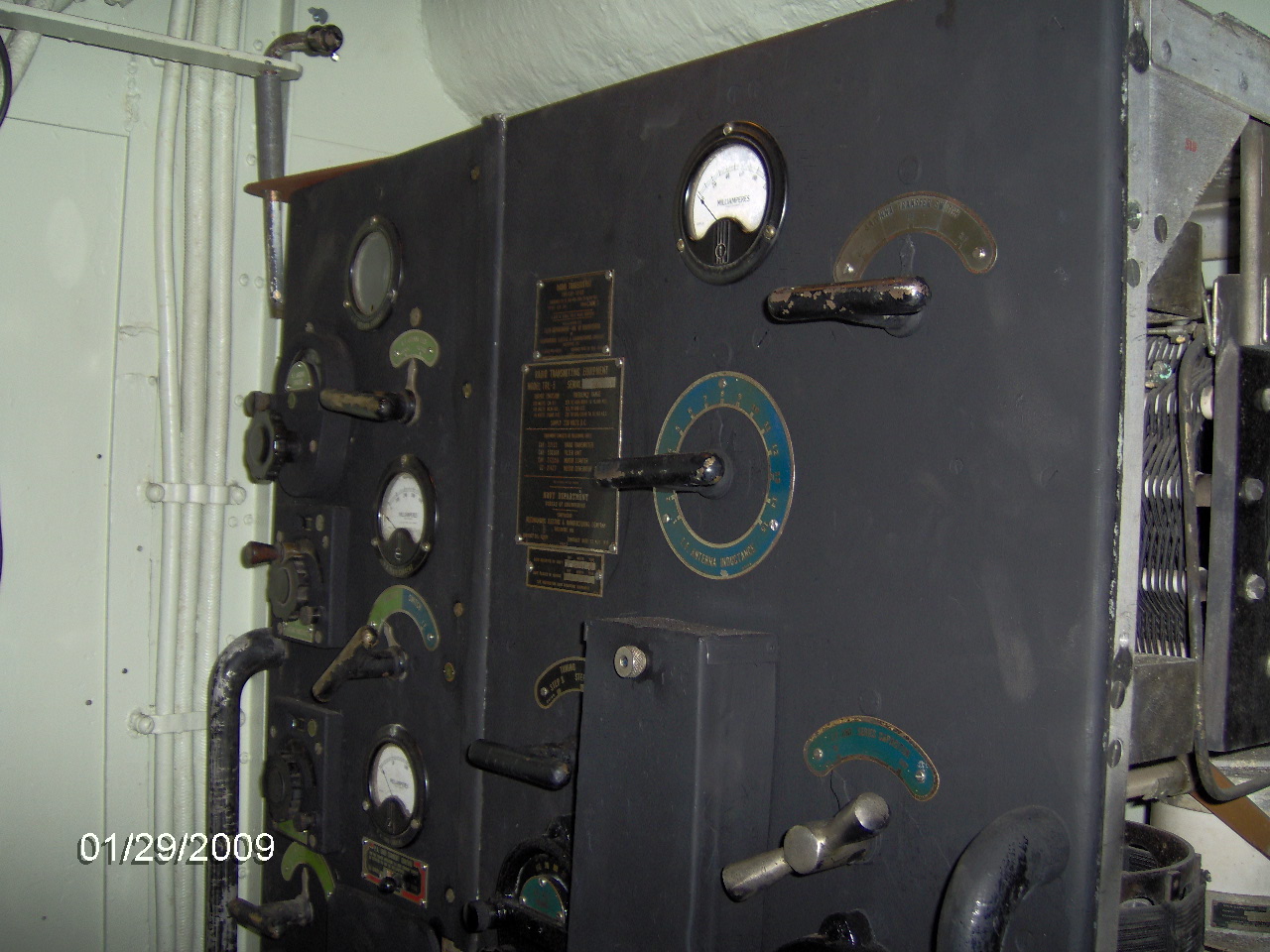

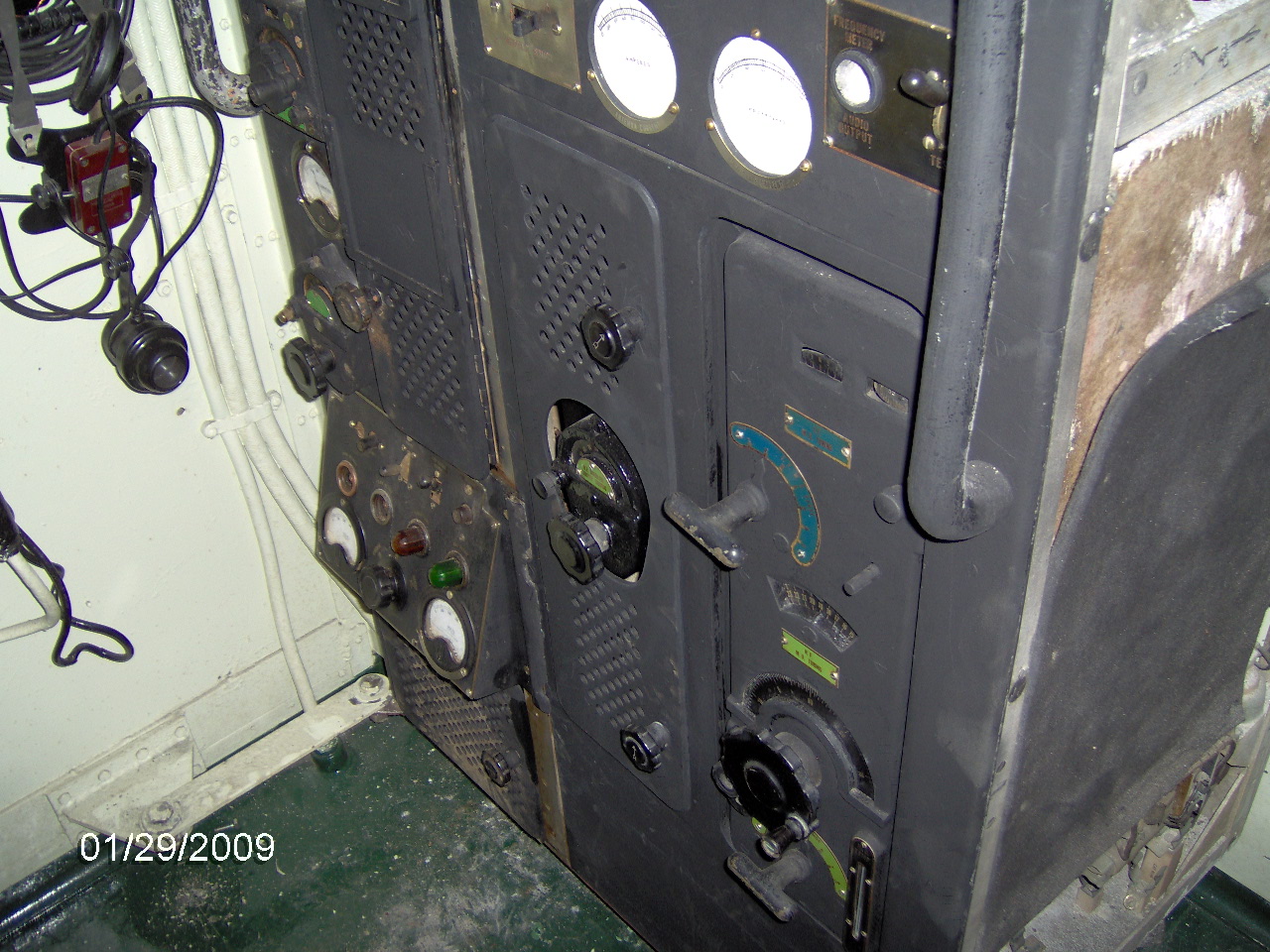

New bunks in aft torpedo room. Restoration of TBL radio transmitter. New mounting plate built for TBL radio transmitter with original rollers. Food order discovered from September of 1945, believed to be final load out before leaving Pearl Harbor for home after the war ended.

Bunks in aft torpedo room TBL radio transmitter TBL radio transmitter TBL radio transmitter New mounting plate for TBL

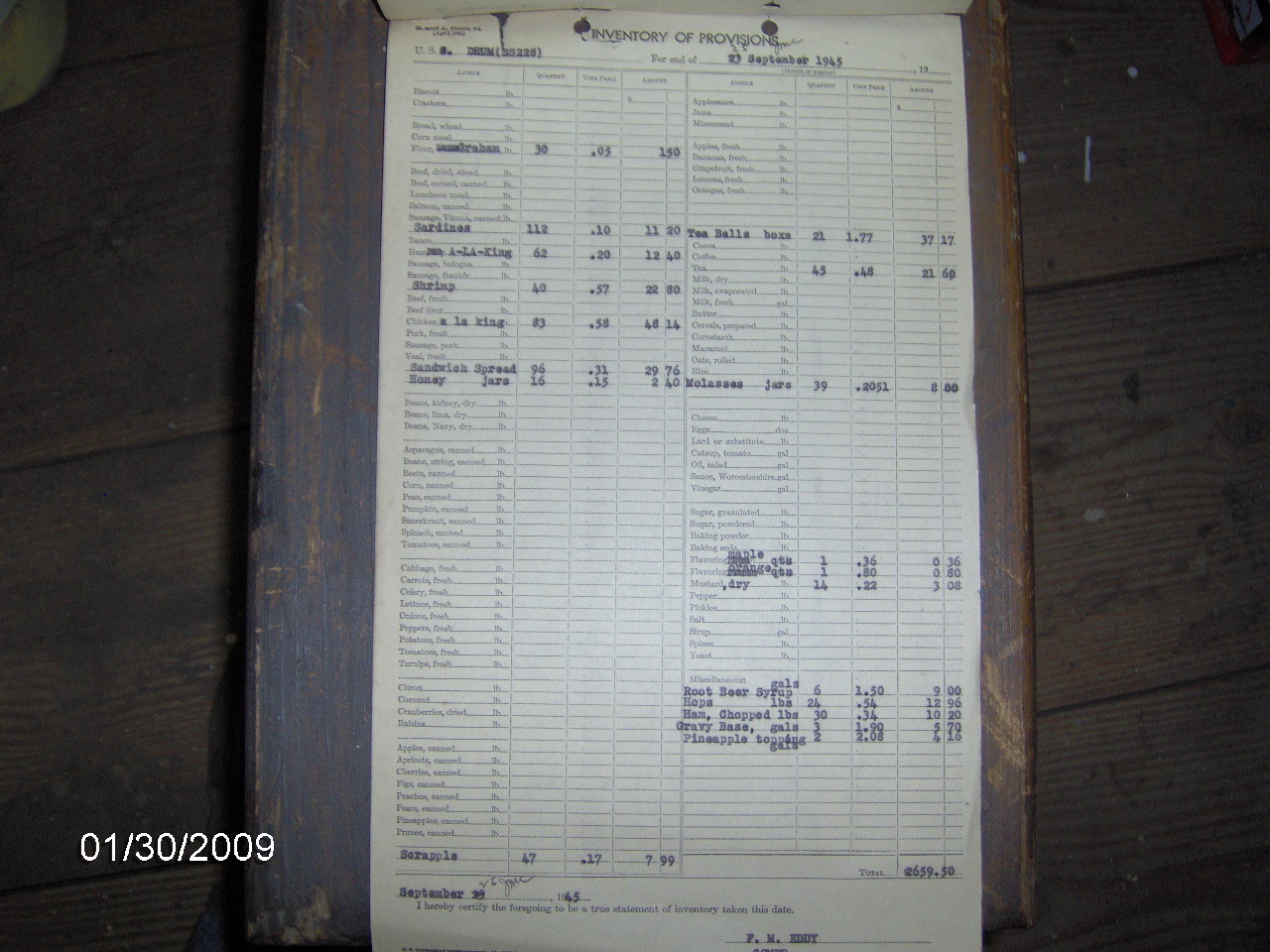

Restored TBL radio transmitter Restored TBL radio transmitter Restored TBL radio transmitter Food order from September 1945 Food order from September 1945

November 2008

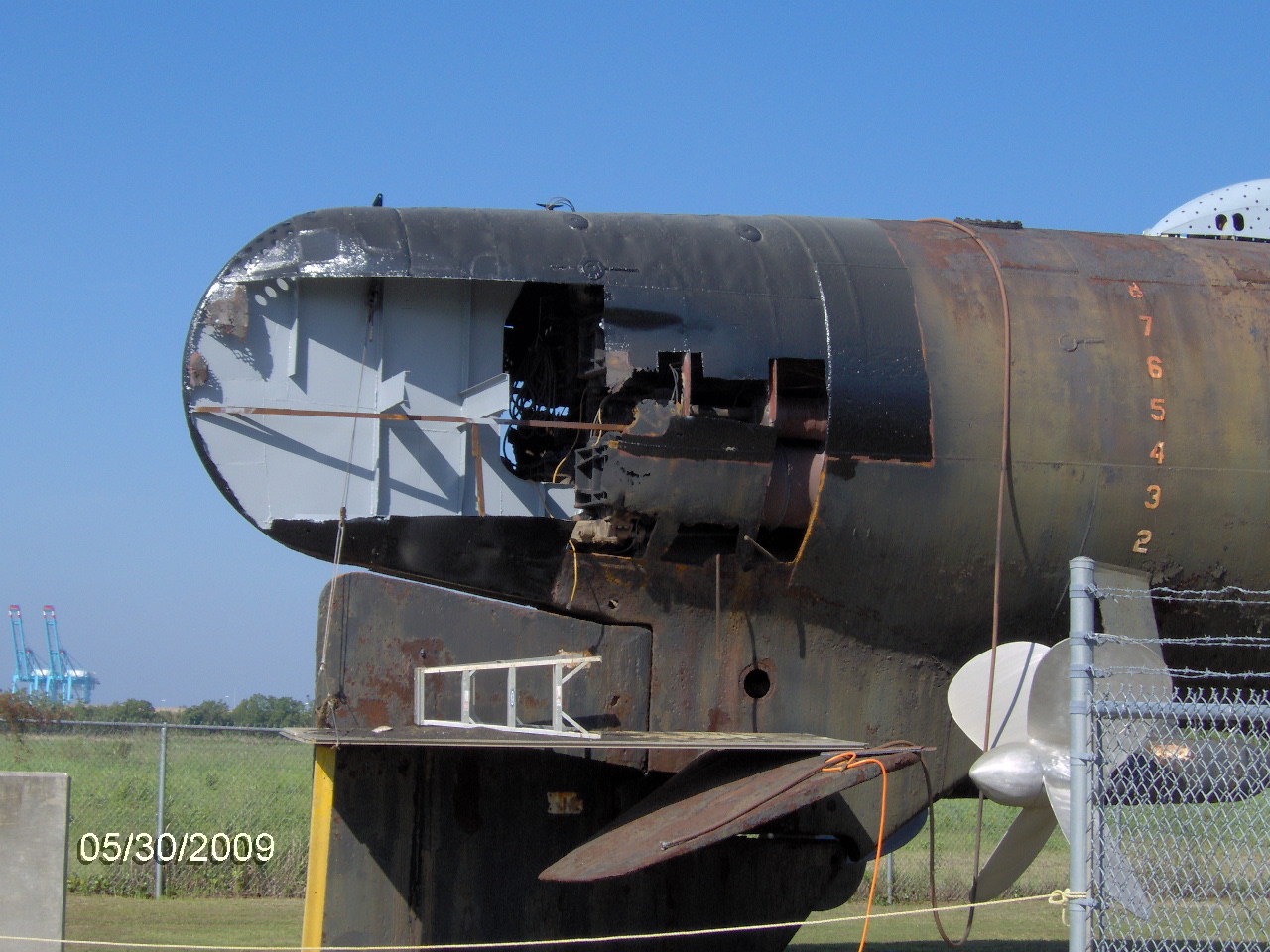

Rebuilding of the stern

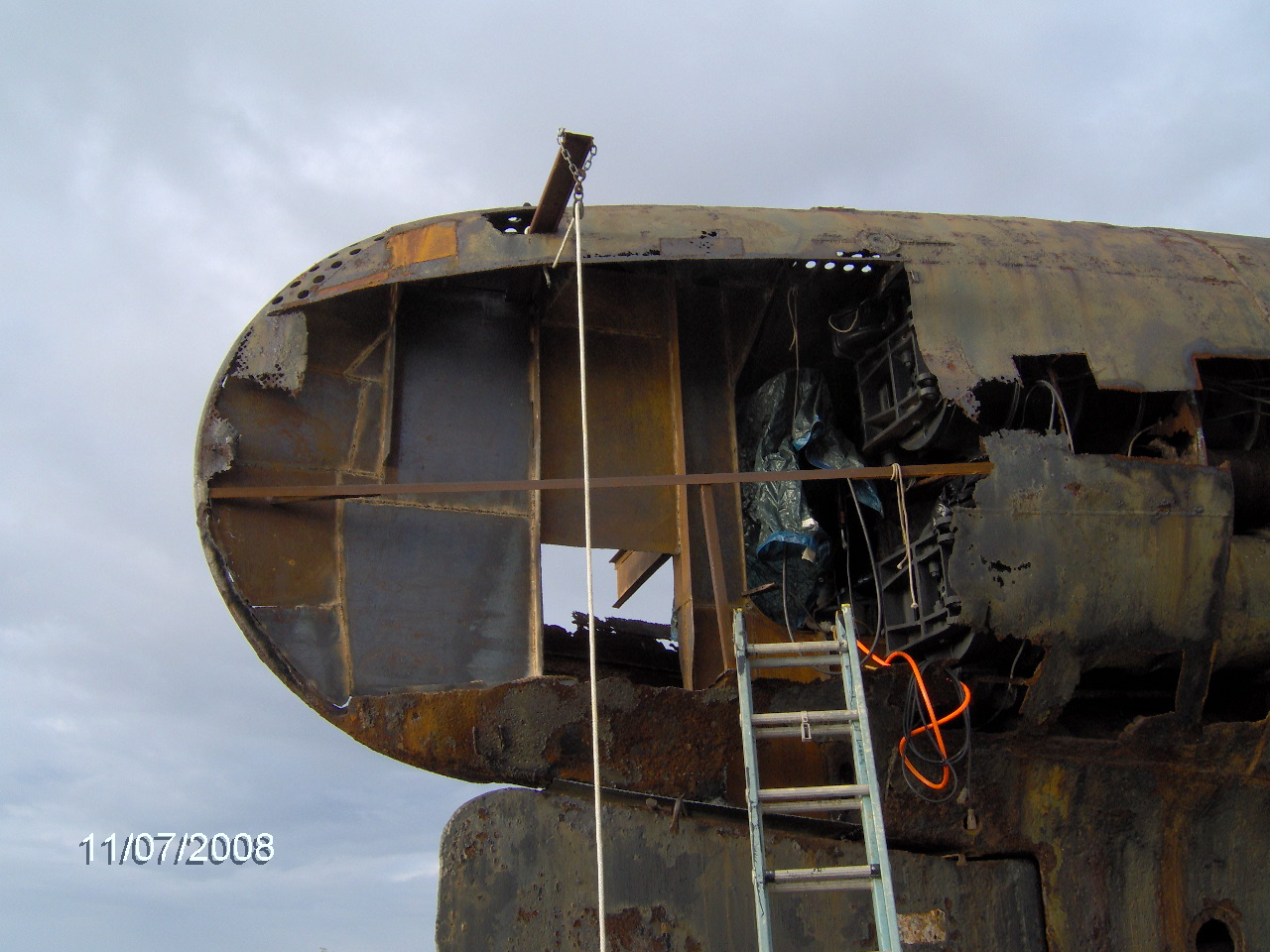

Stern before Stern after

October 2008

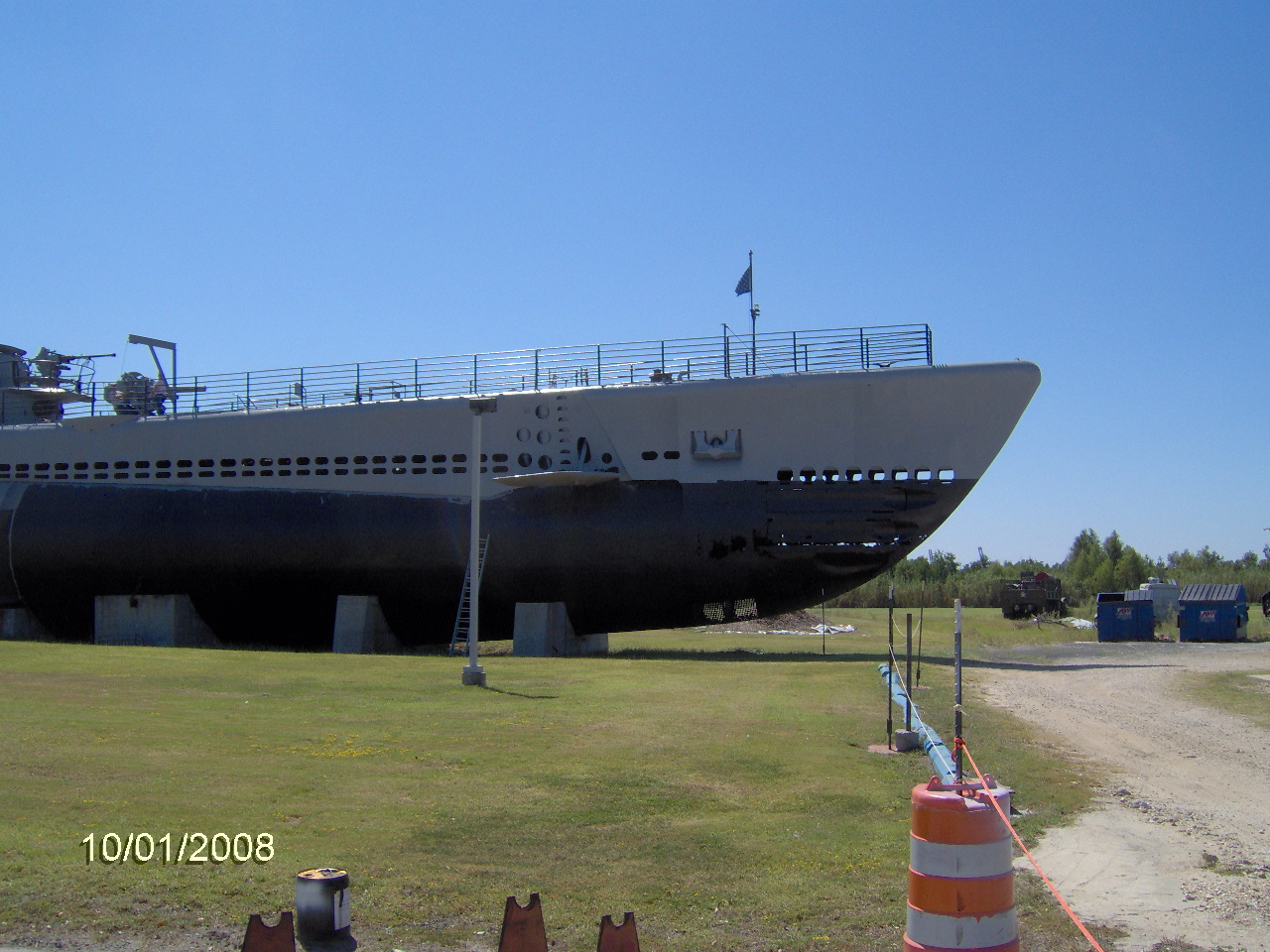

Sandblasting, priming, and painting of the exterior

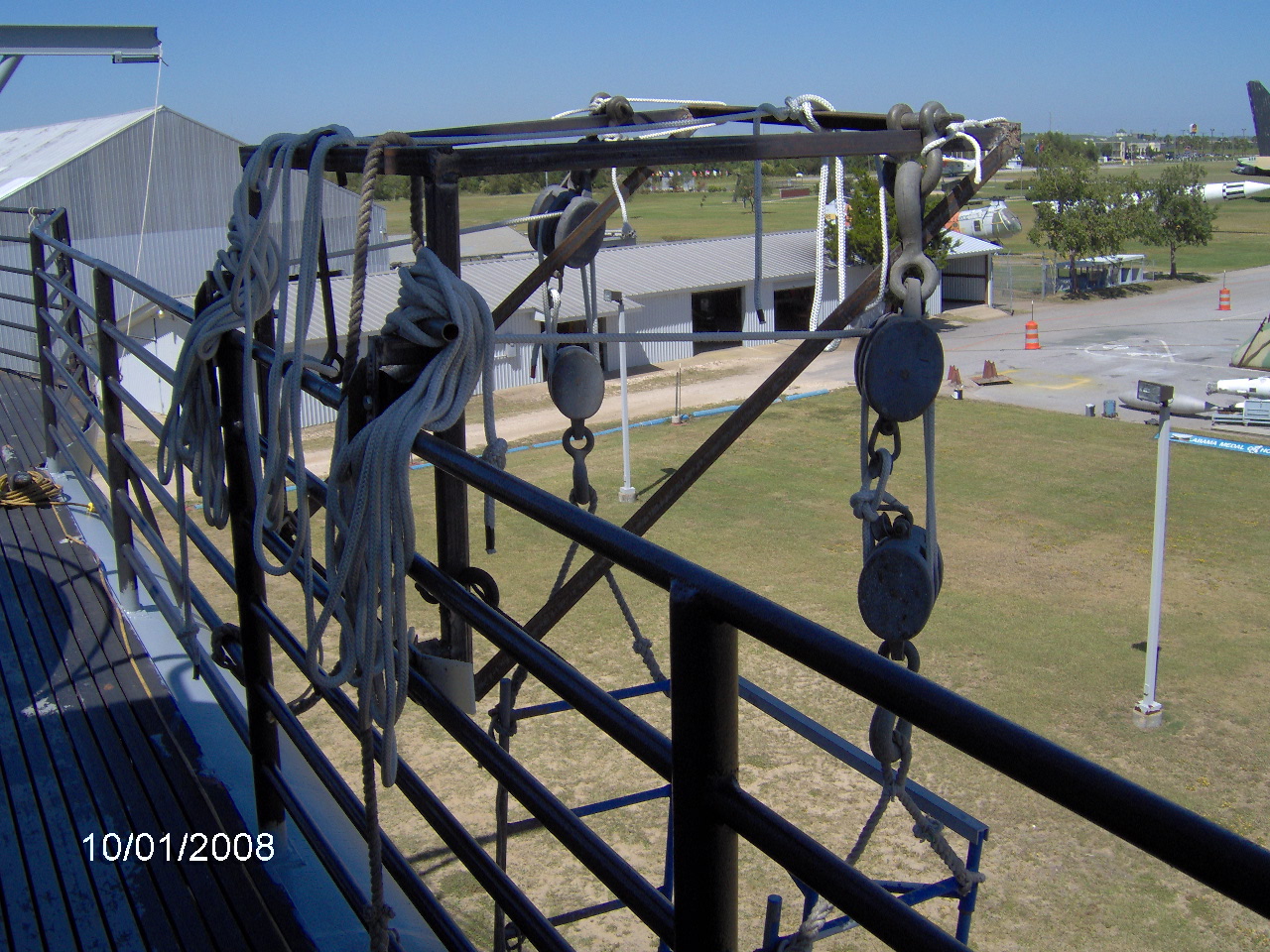

Sandblasting, priming, and painting Sandblasting, priming, and painting Hoist for moving the scaffolding

August 2008

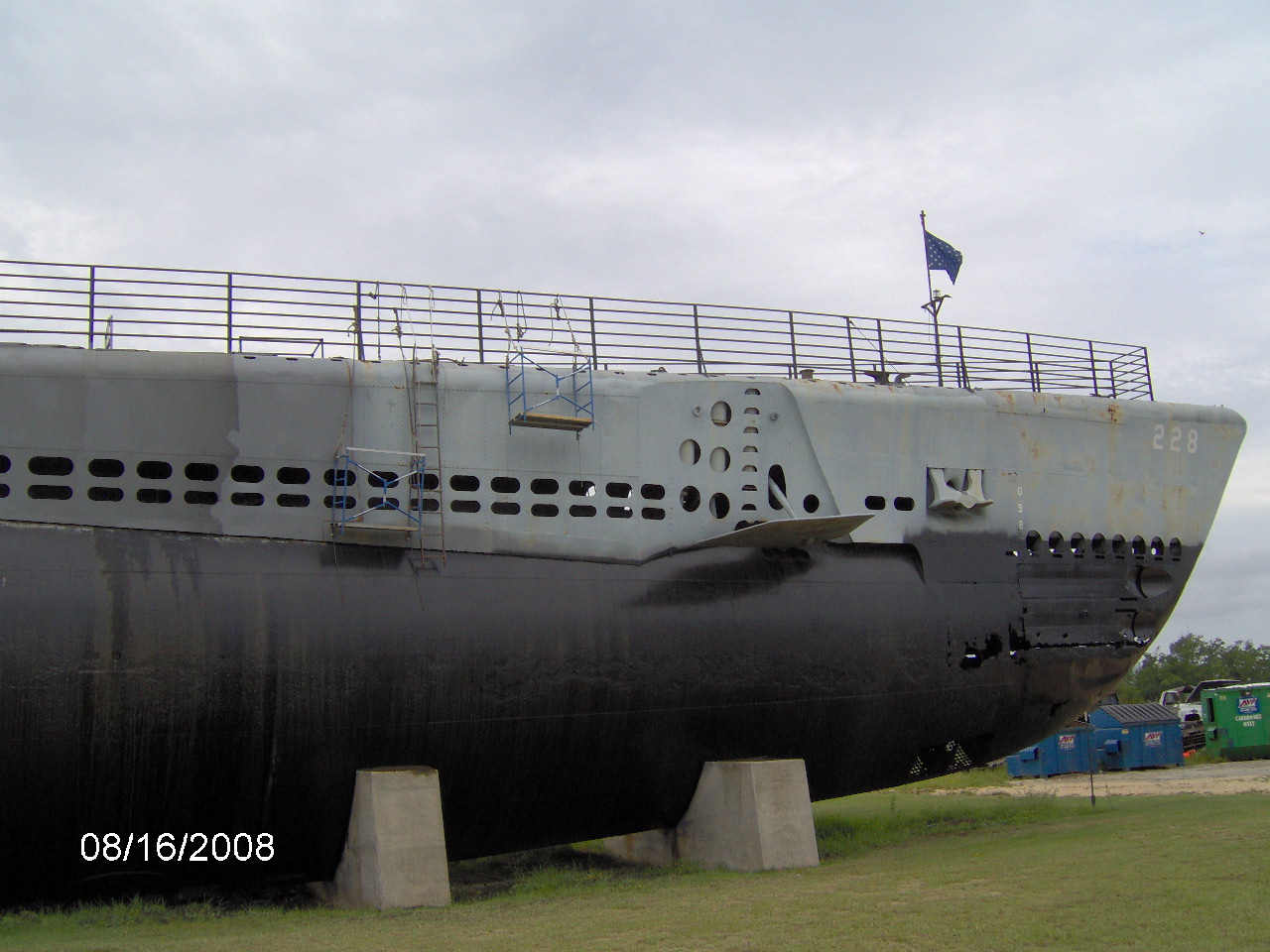

Sandblasting, priming, and painting of the exterior

Sandblasting, priming, and painting Sandblasting, priming, and painting

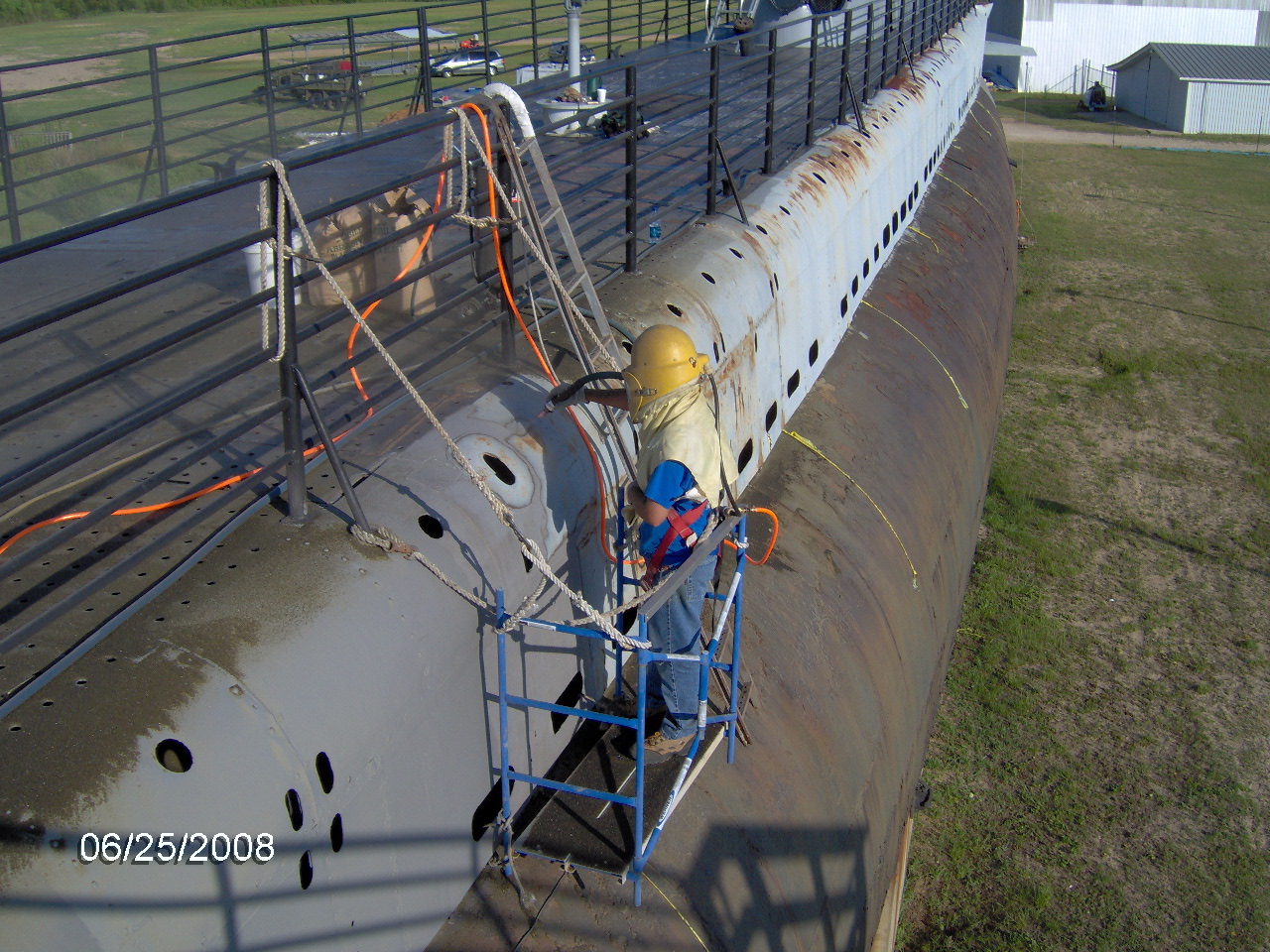

June 2008

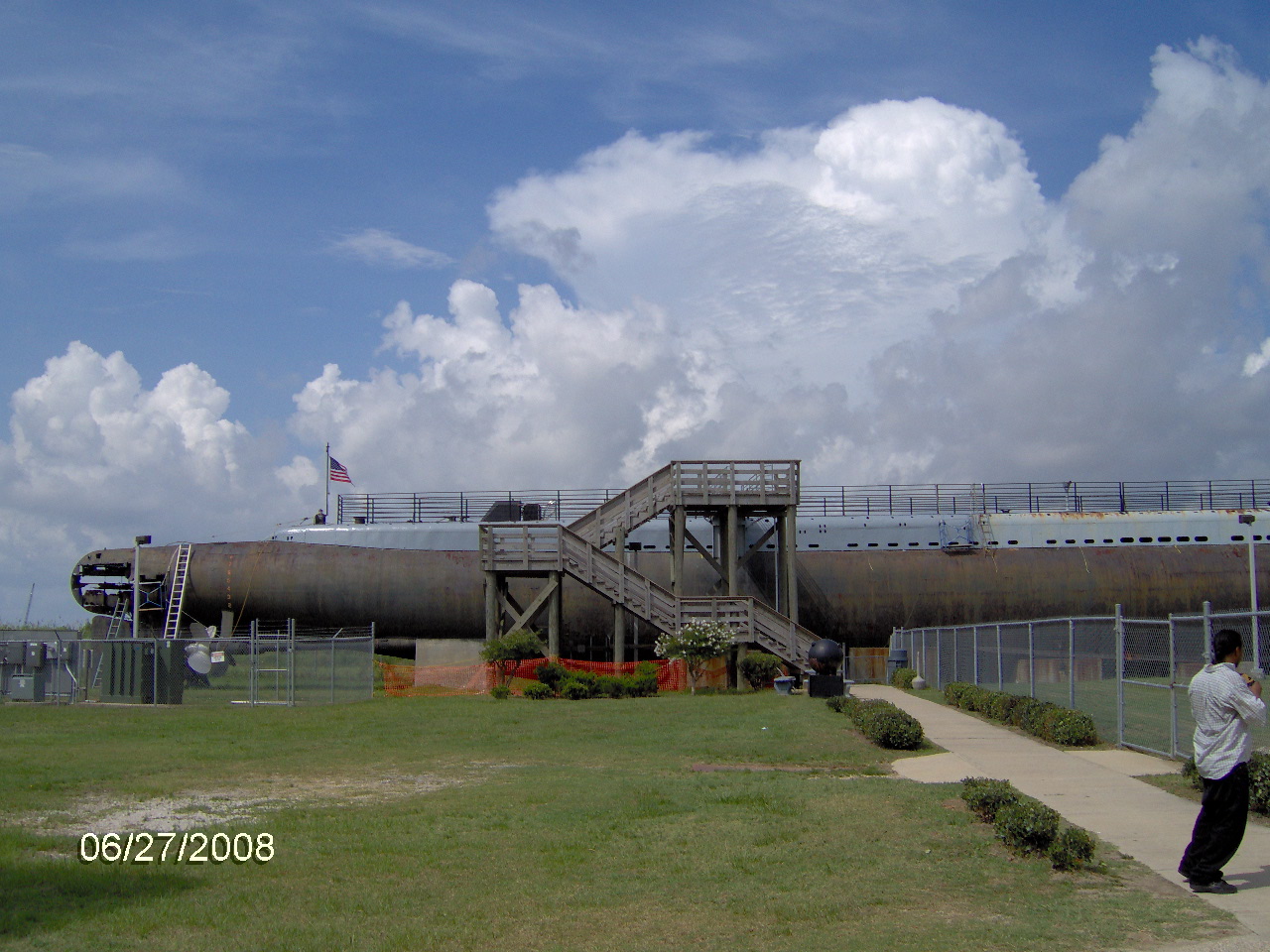

Sandblasting, priming, and painting of the exterior

Sandblasting, priming, and painting Sandblasting, priming, and painting Lesley Waters sandblasting Sandblasting, priming, and painting

April 2008

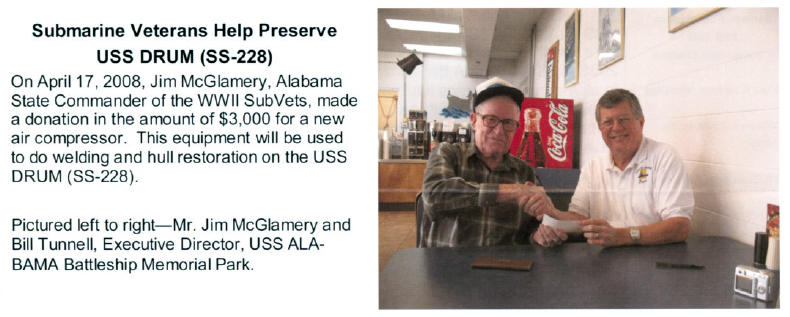

Alabama United States Submarine Veterans of WWII (USSVWWII) donate $3,000 for an air compressor!

Alabama USSVWWII donate $3,000

March 2008

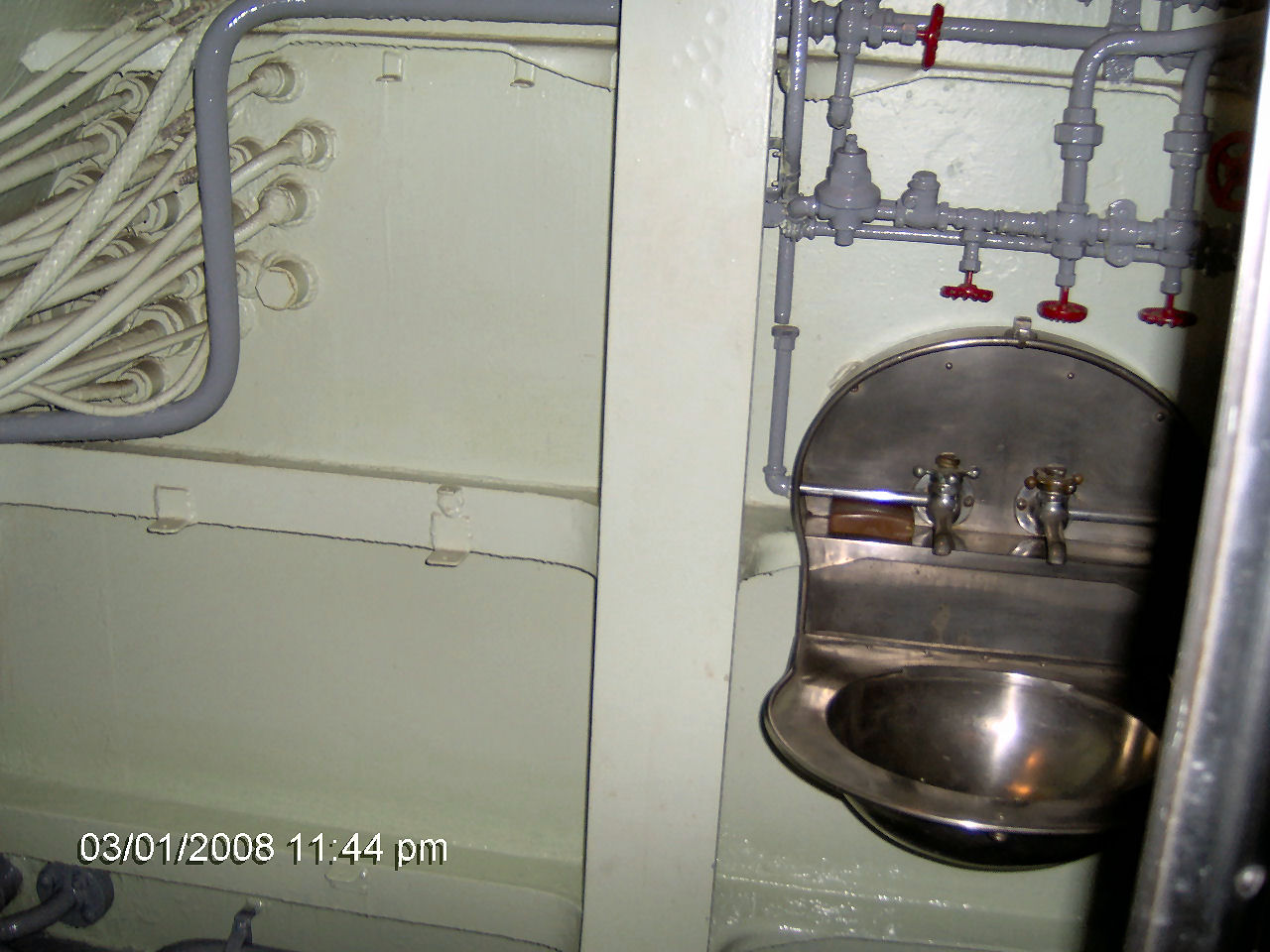

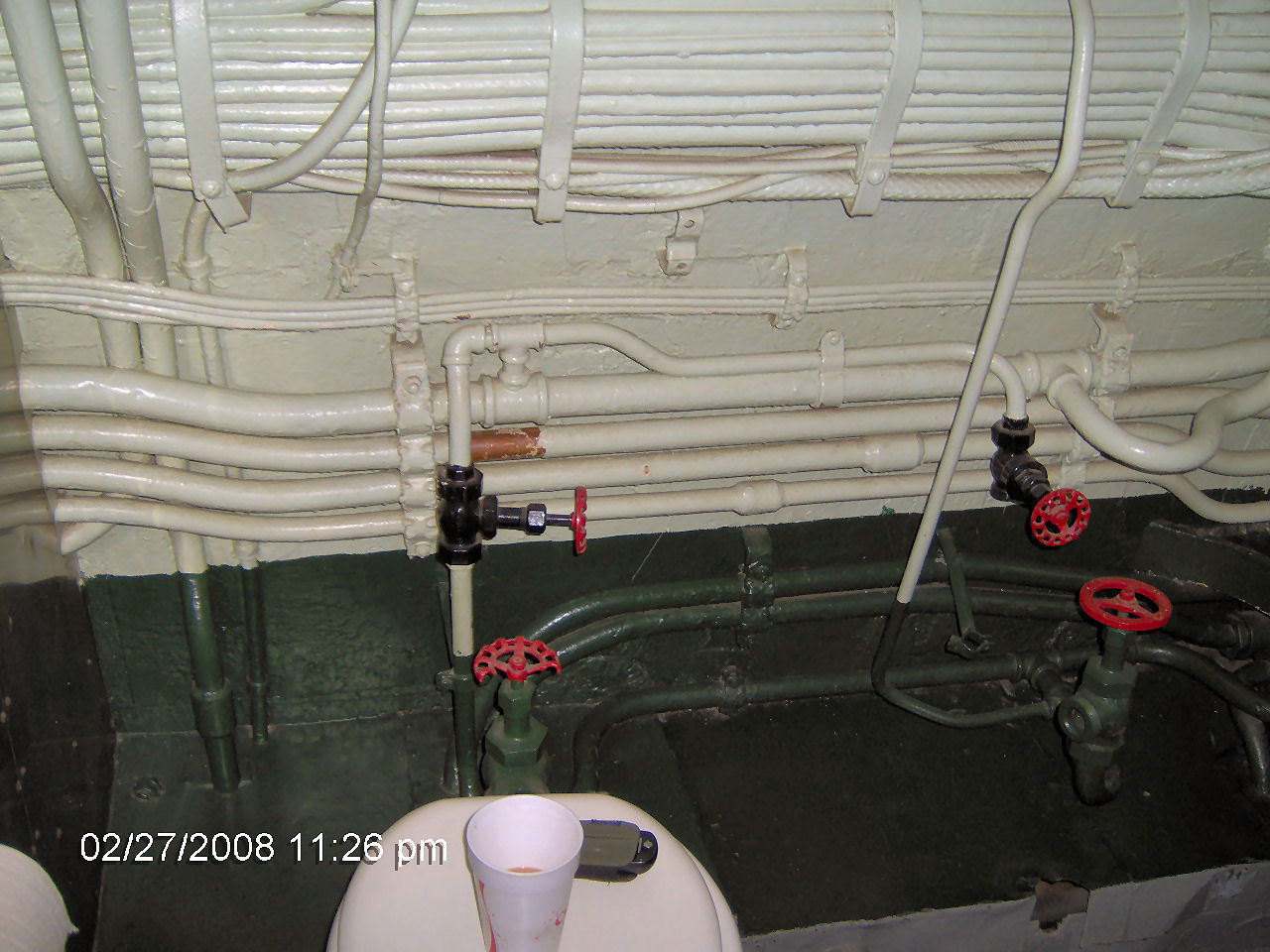

Head

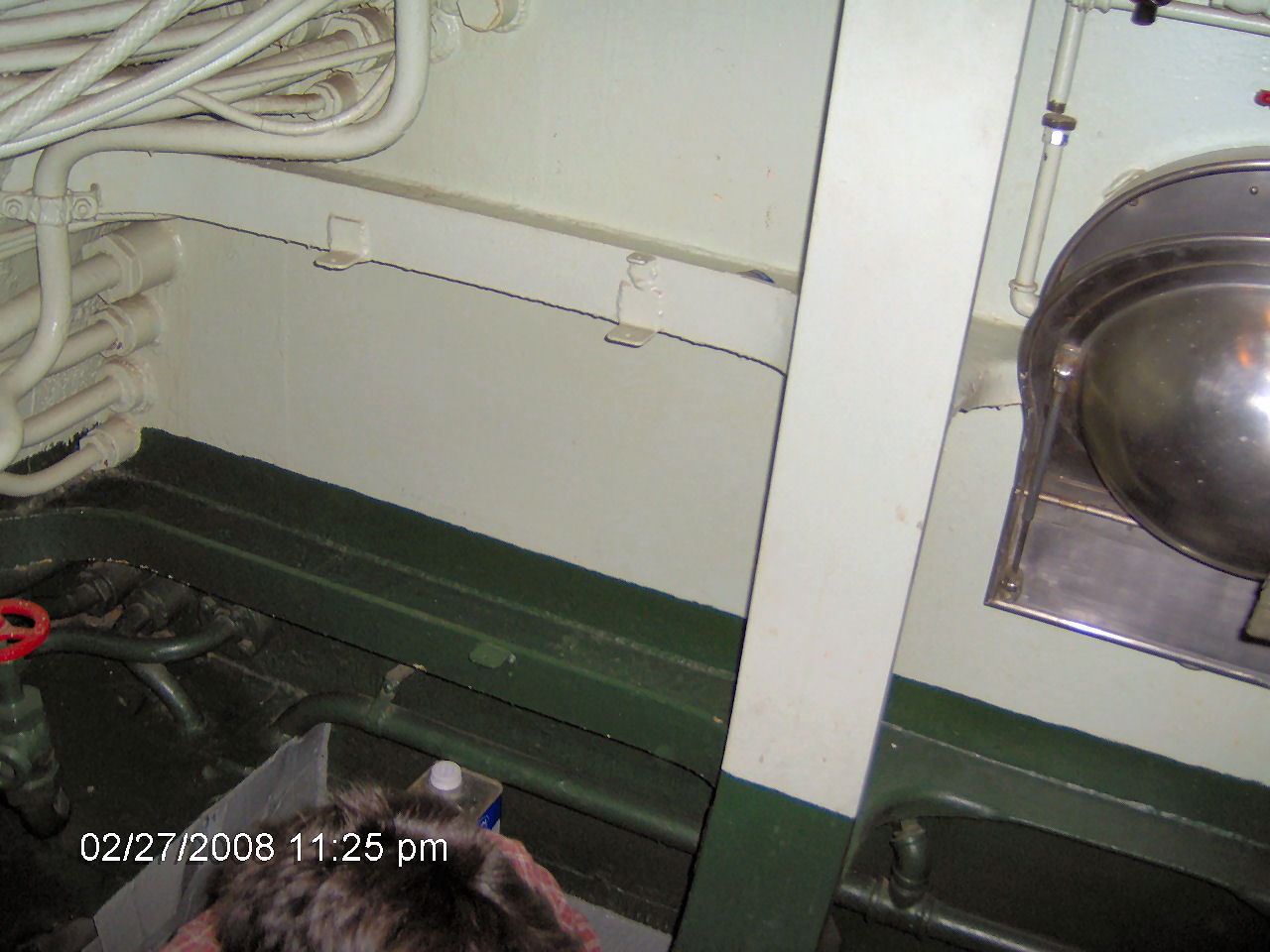

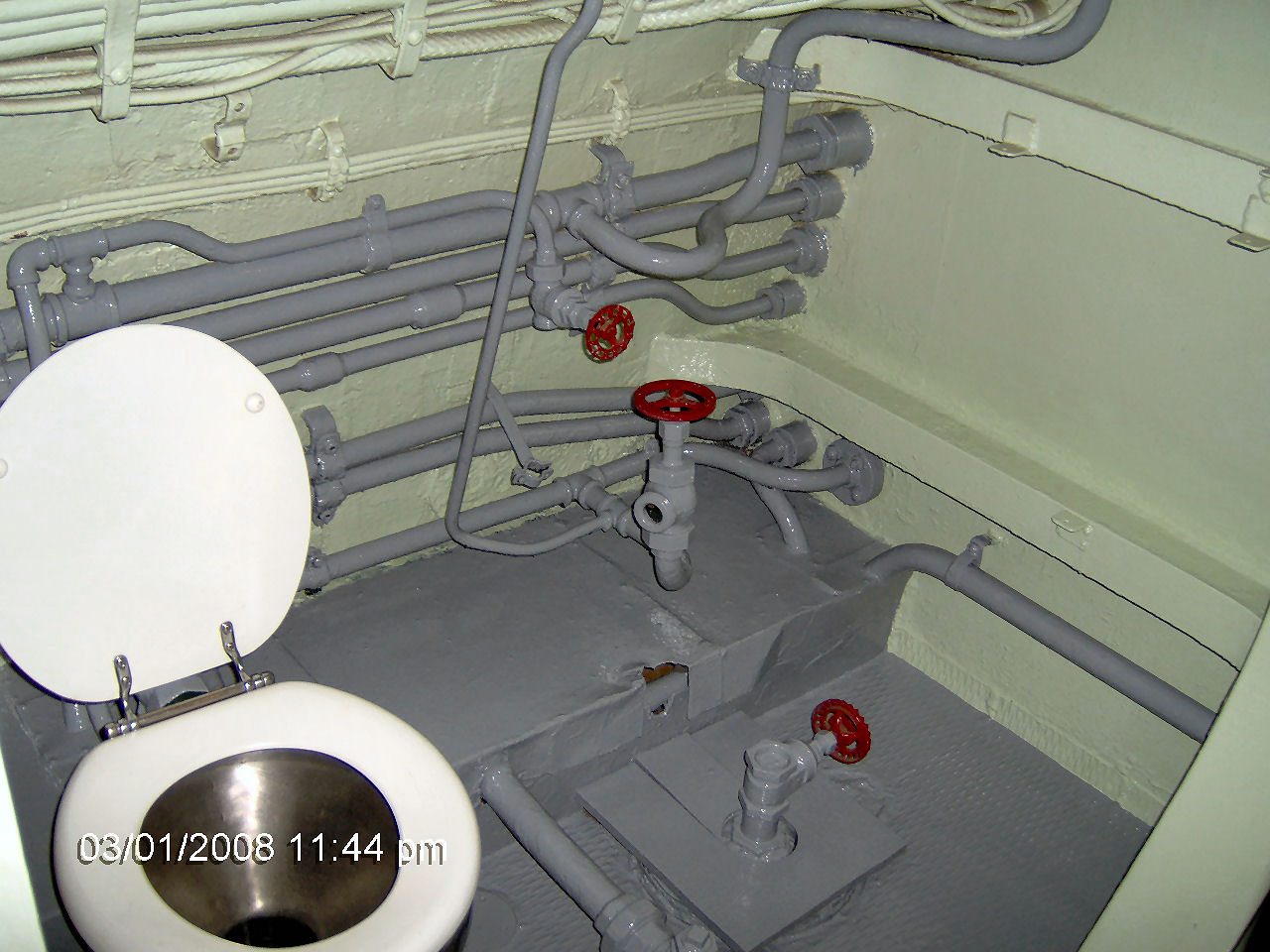

Head before Head before Head after Head after

February 2008

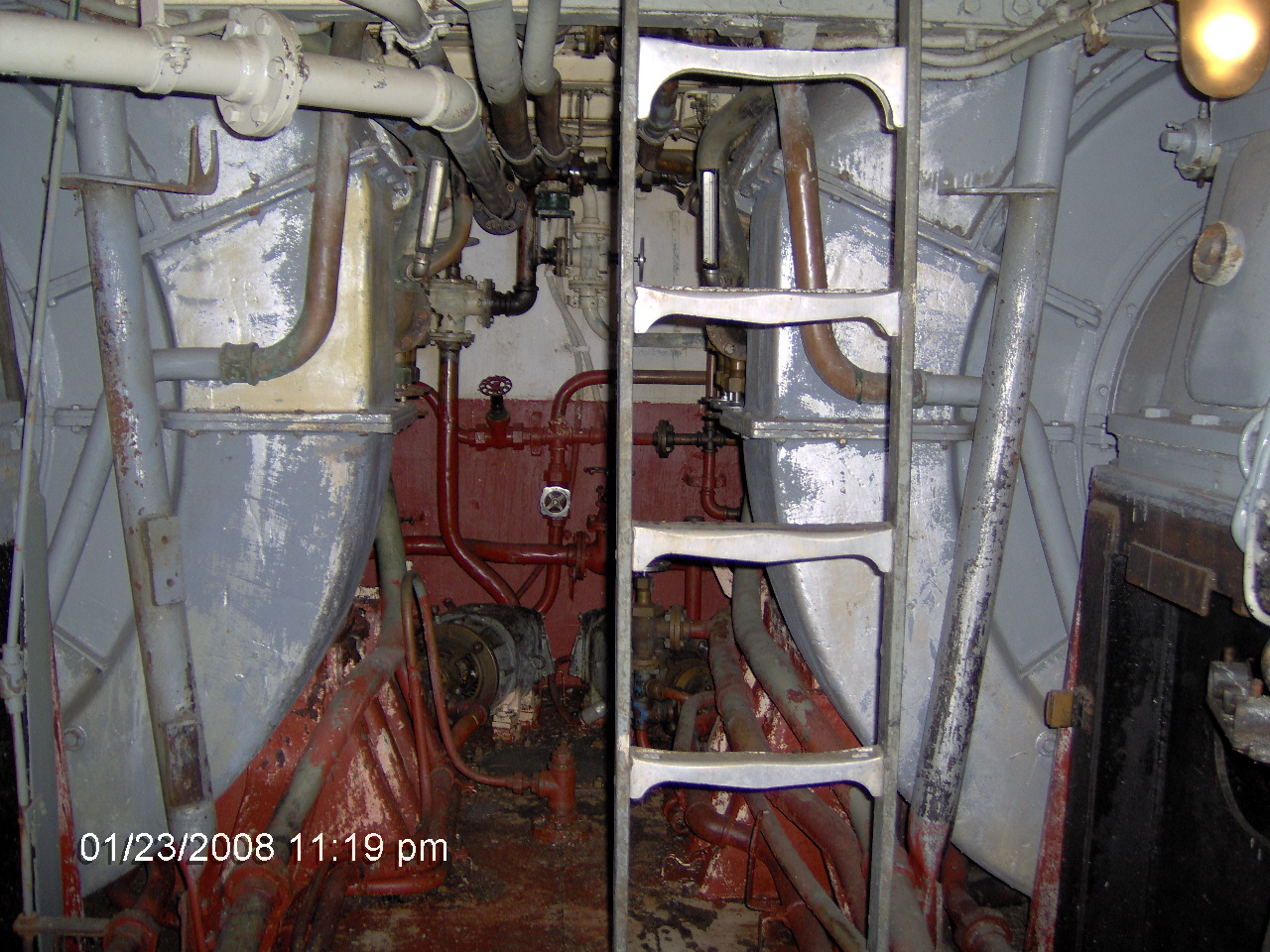

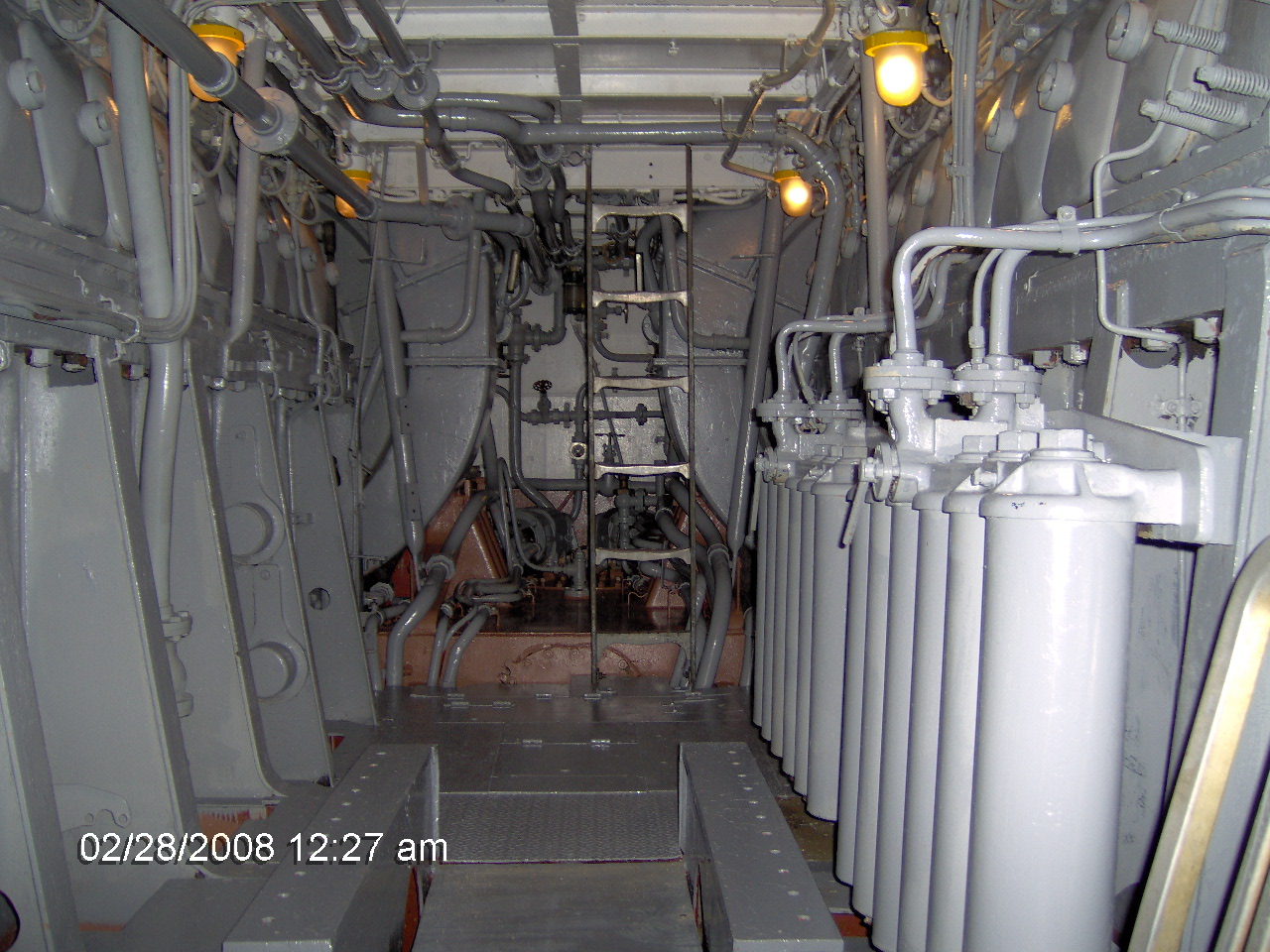

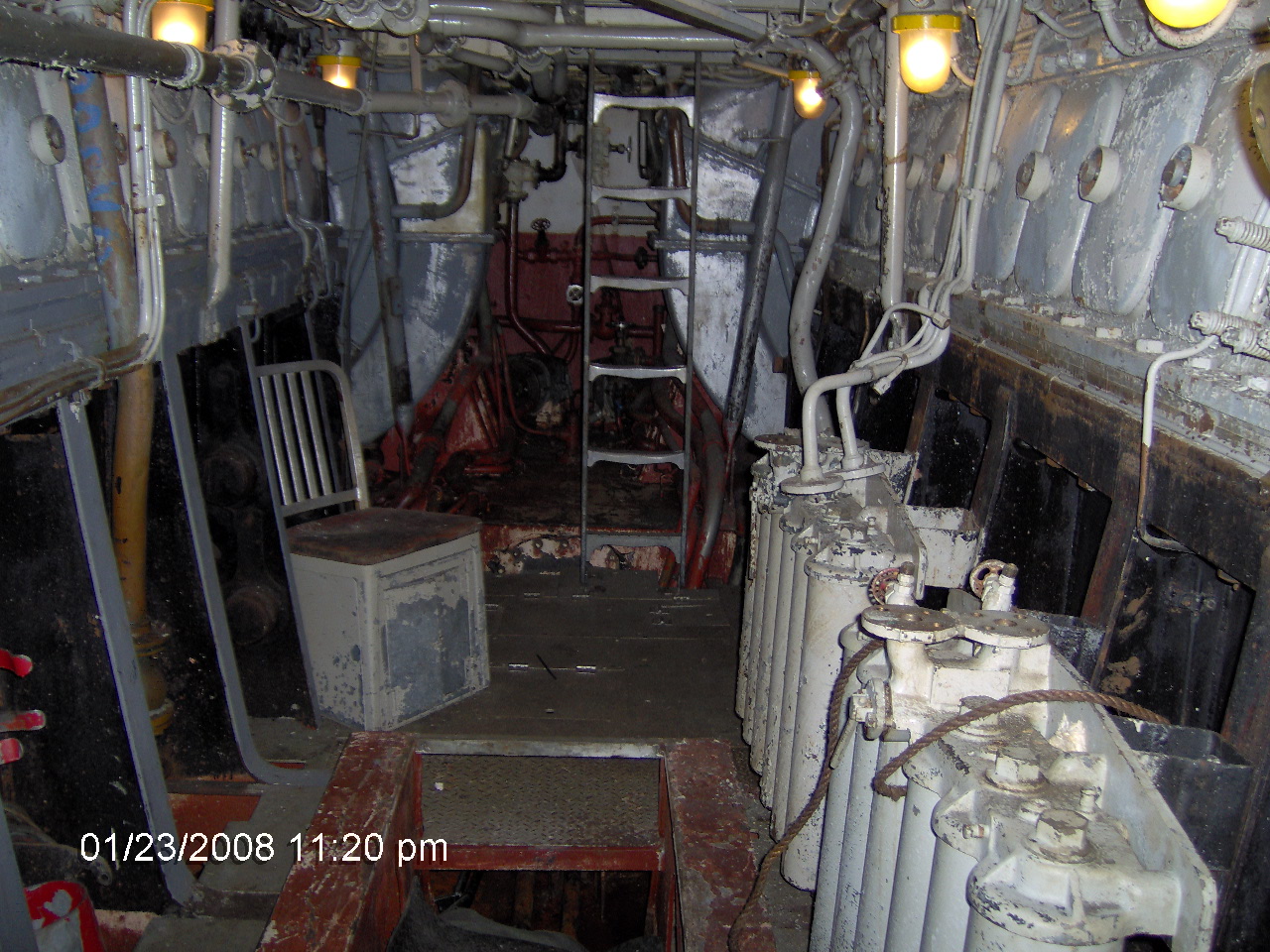

Lower Level Engine Room

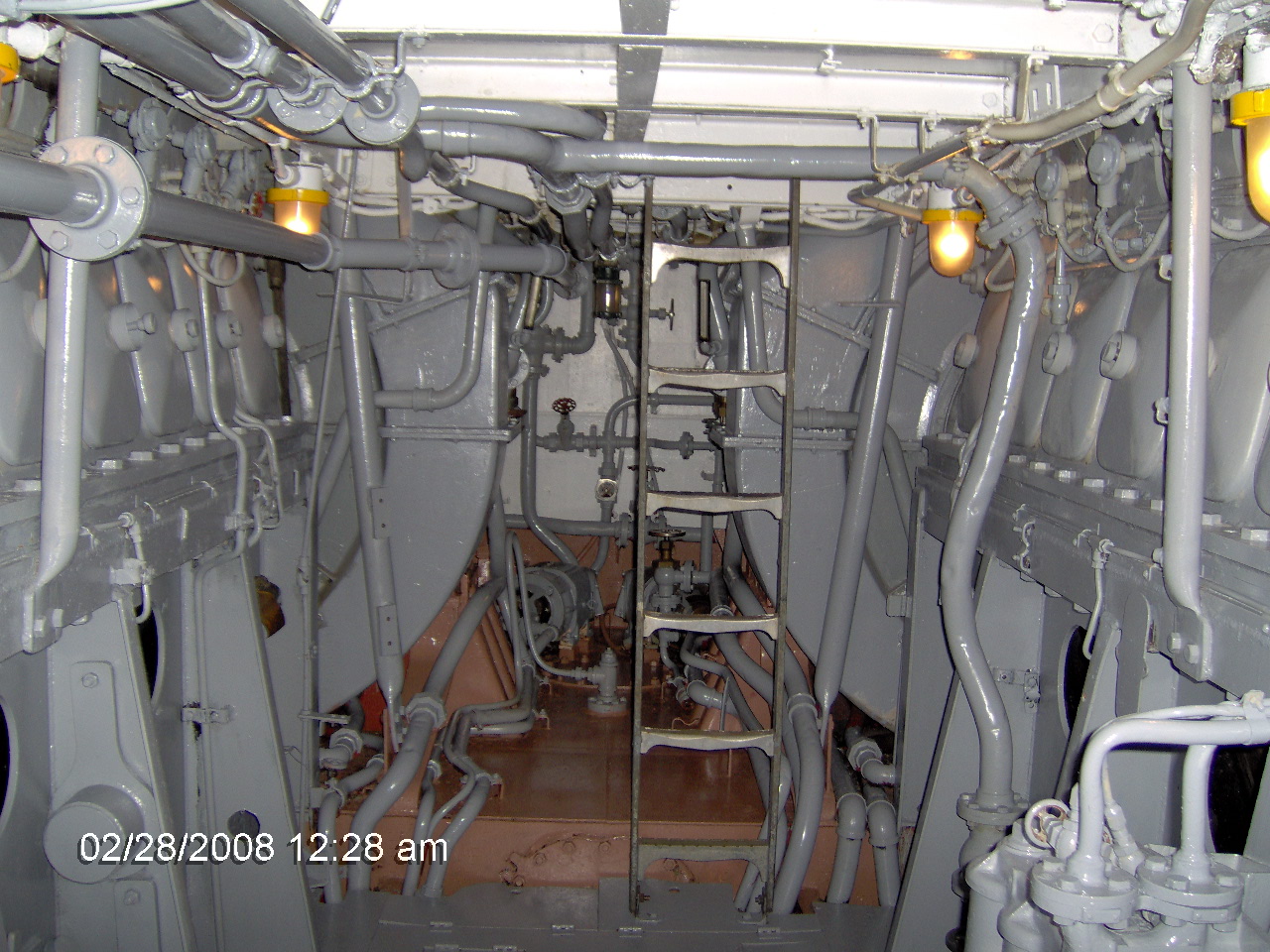

LLER2 before LLER2 before LLER2 after LLER2 after

February 2008

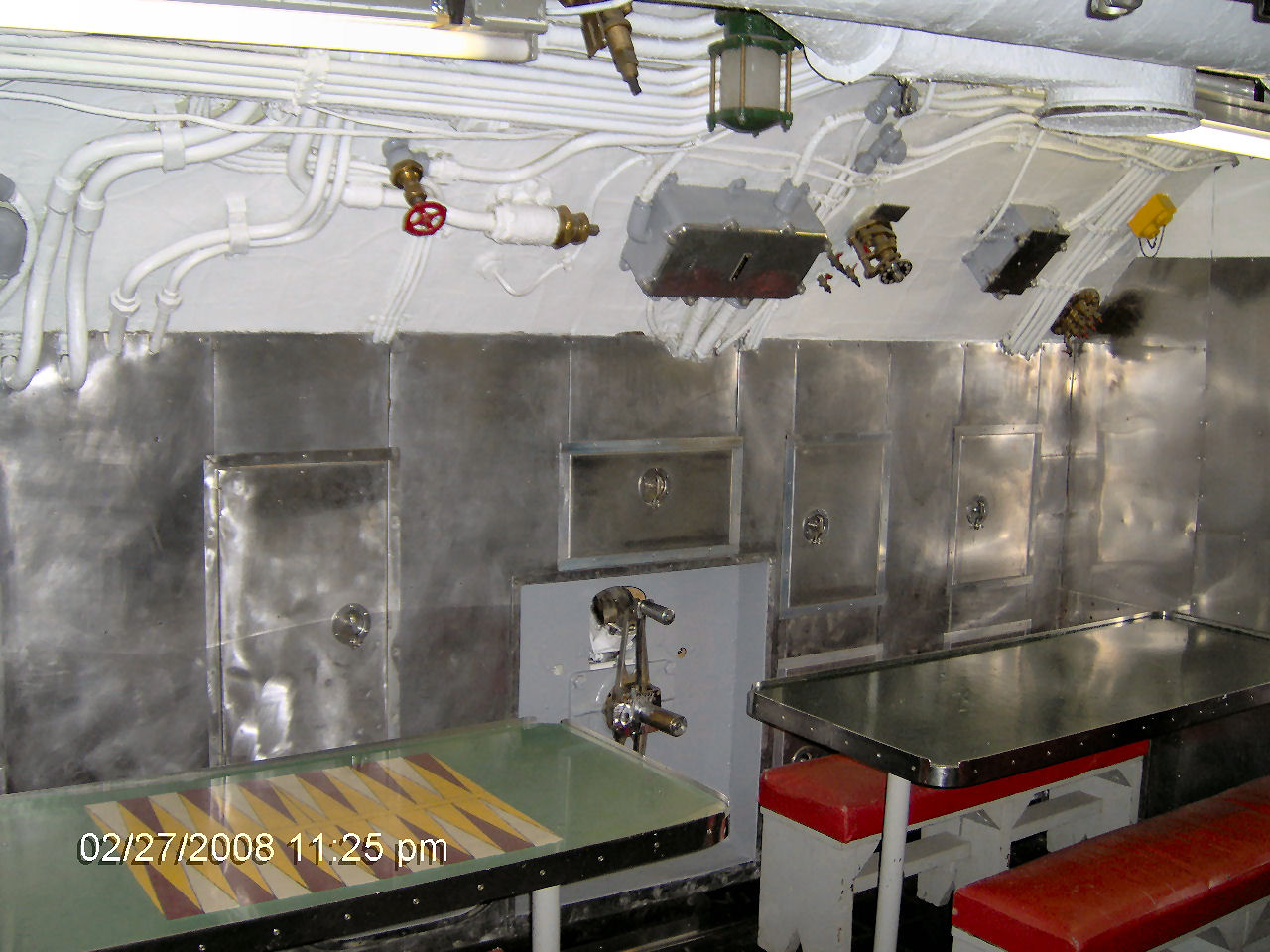

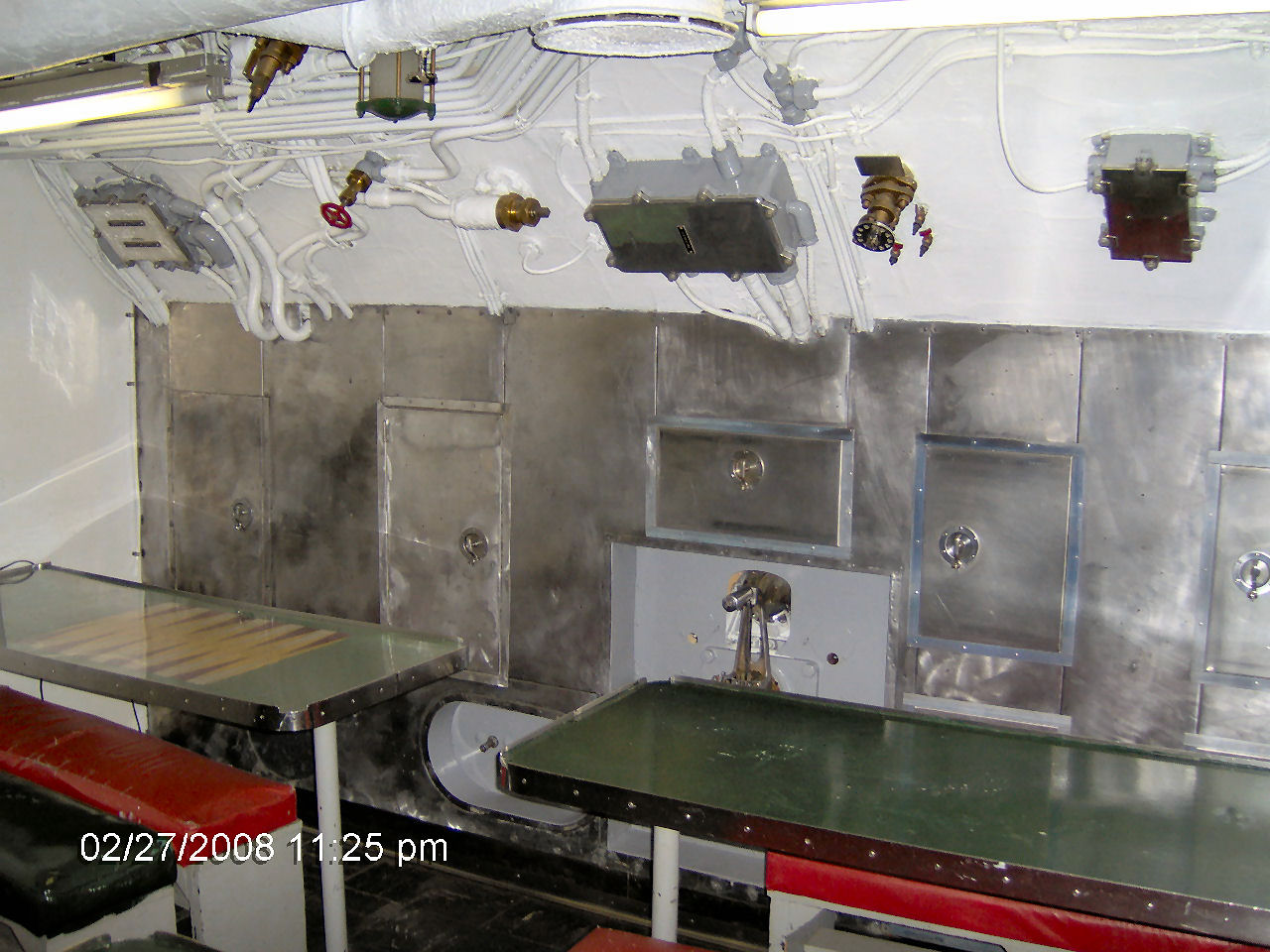

Crew's Mess

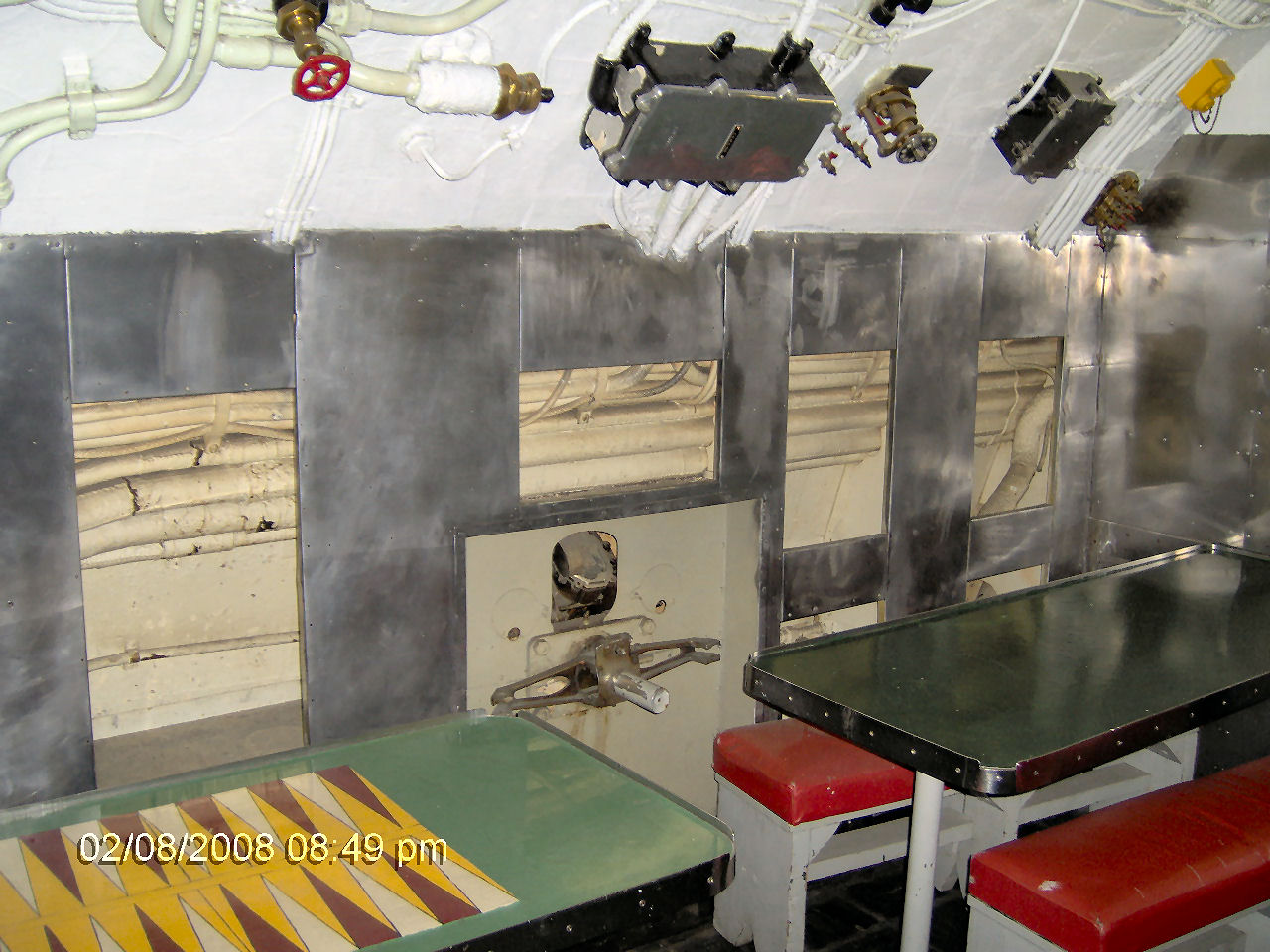

Crew's Mess before Crew's Mess after Crew's Mess after

December 2007

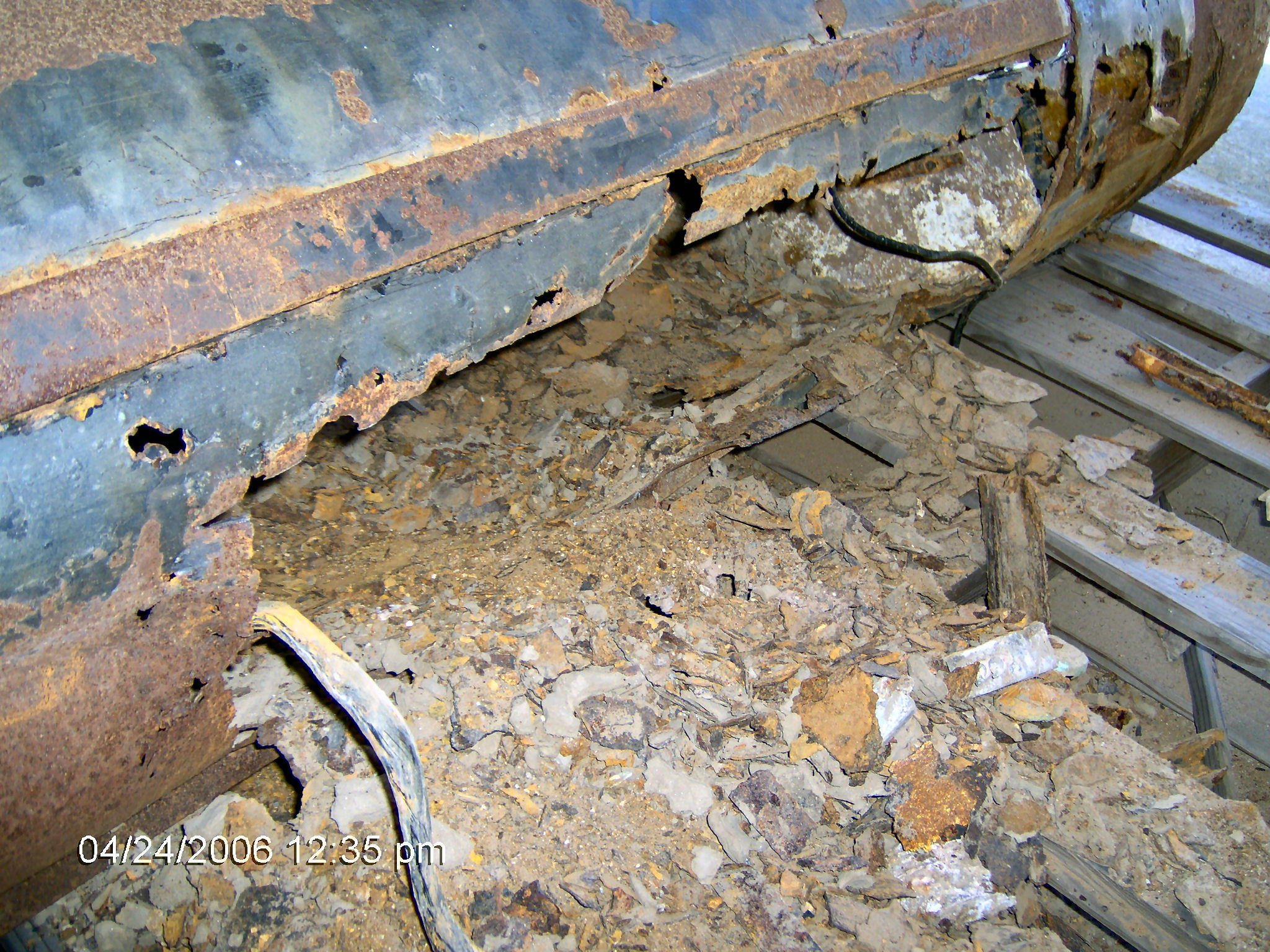

Mark 27, electric, passive acoustic homing torpedo aka "Cutie"

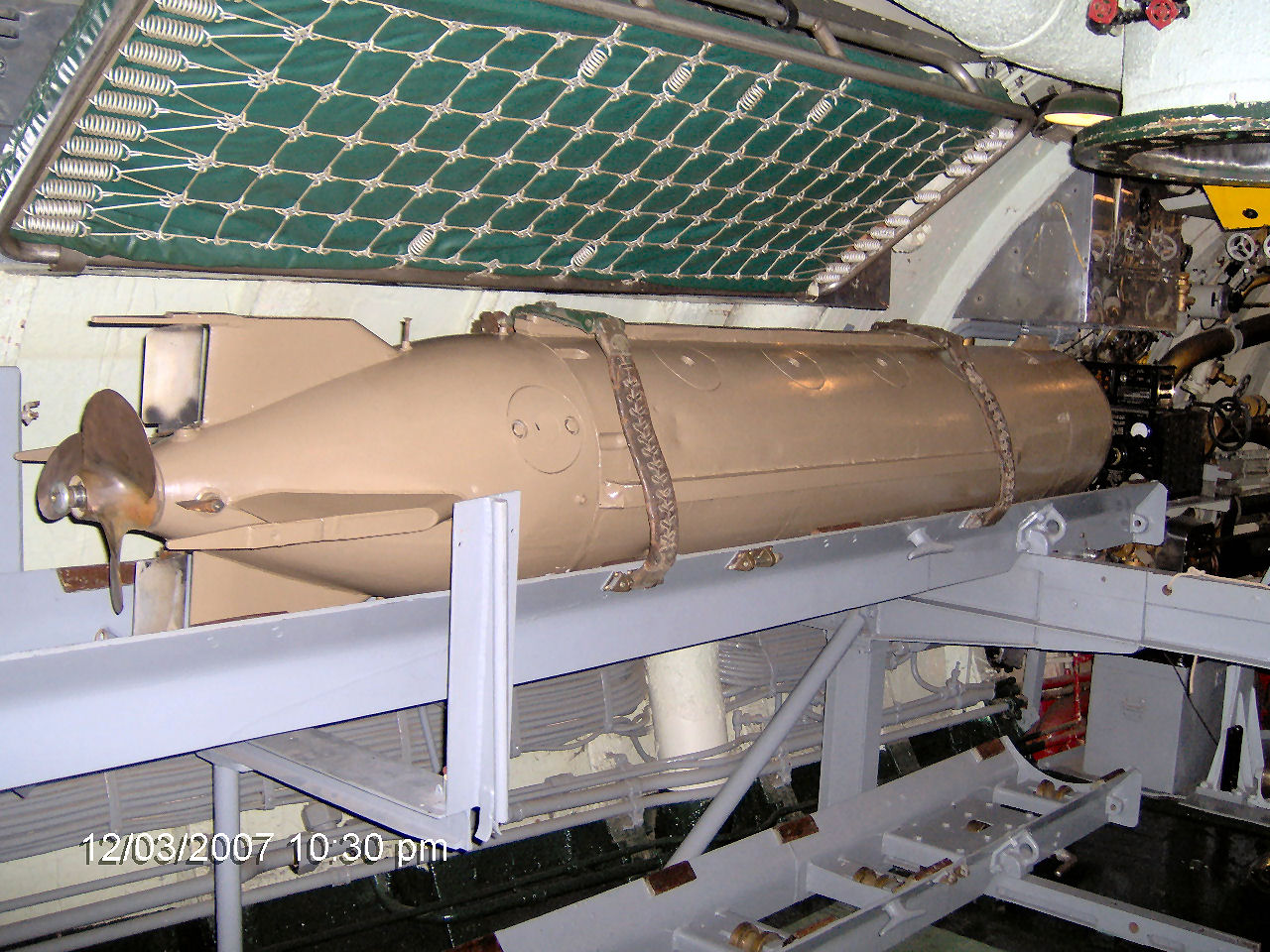

Mk27 Torpedo before Mk27 Torpedo after

December 2007

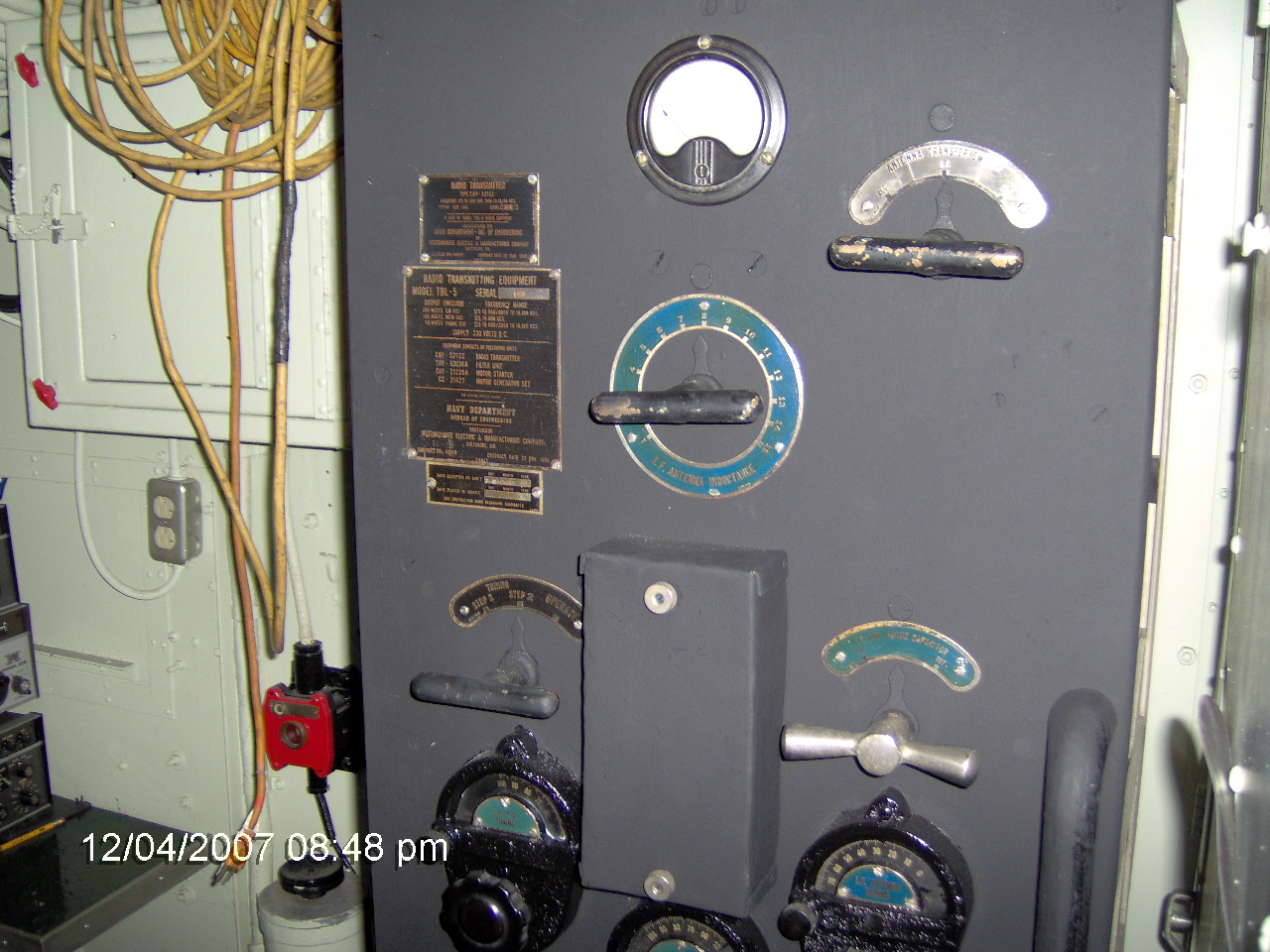

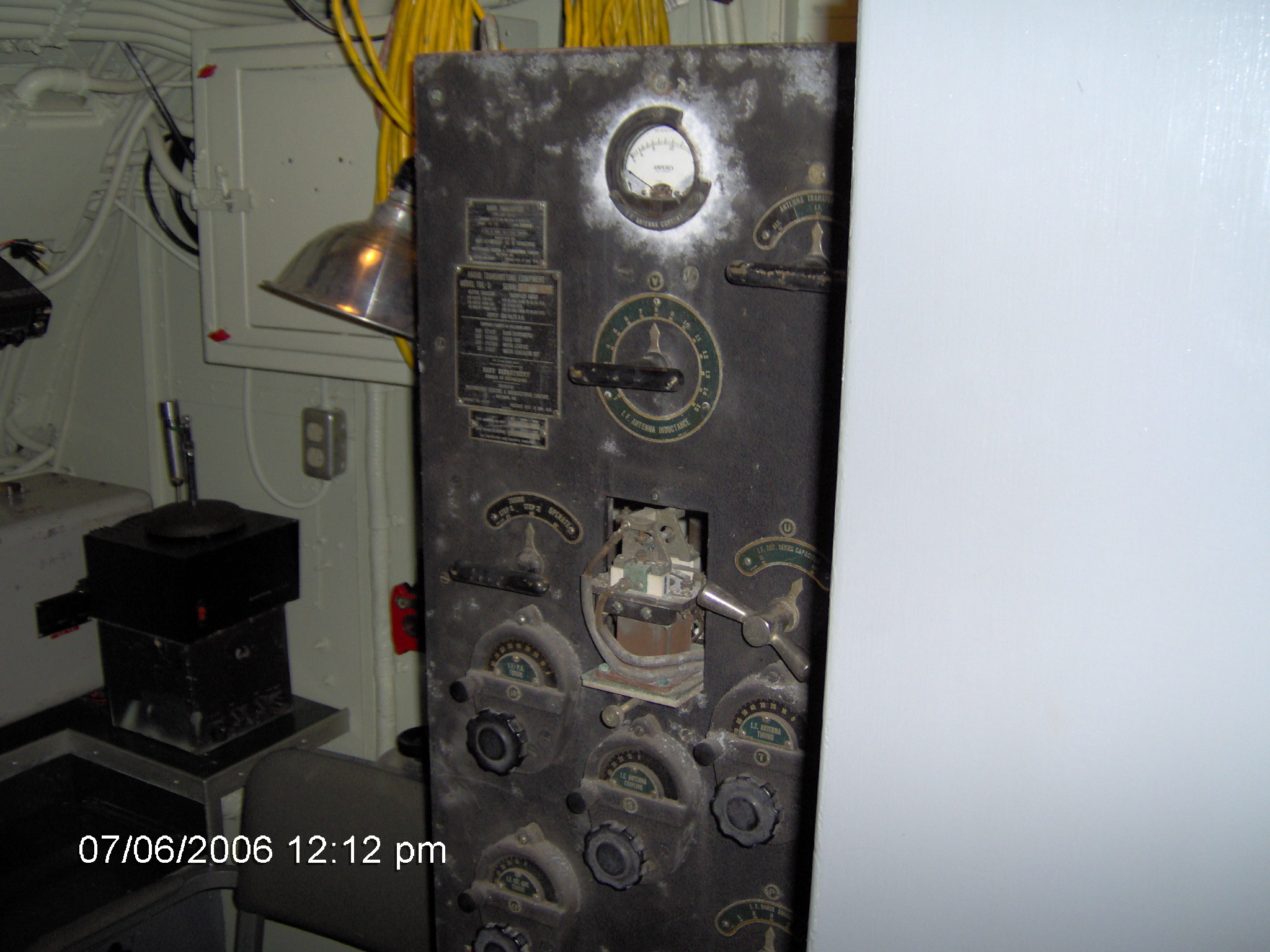

Radio Transmitter

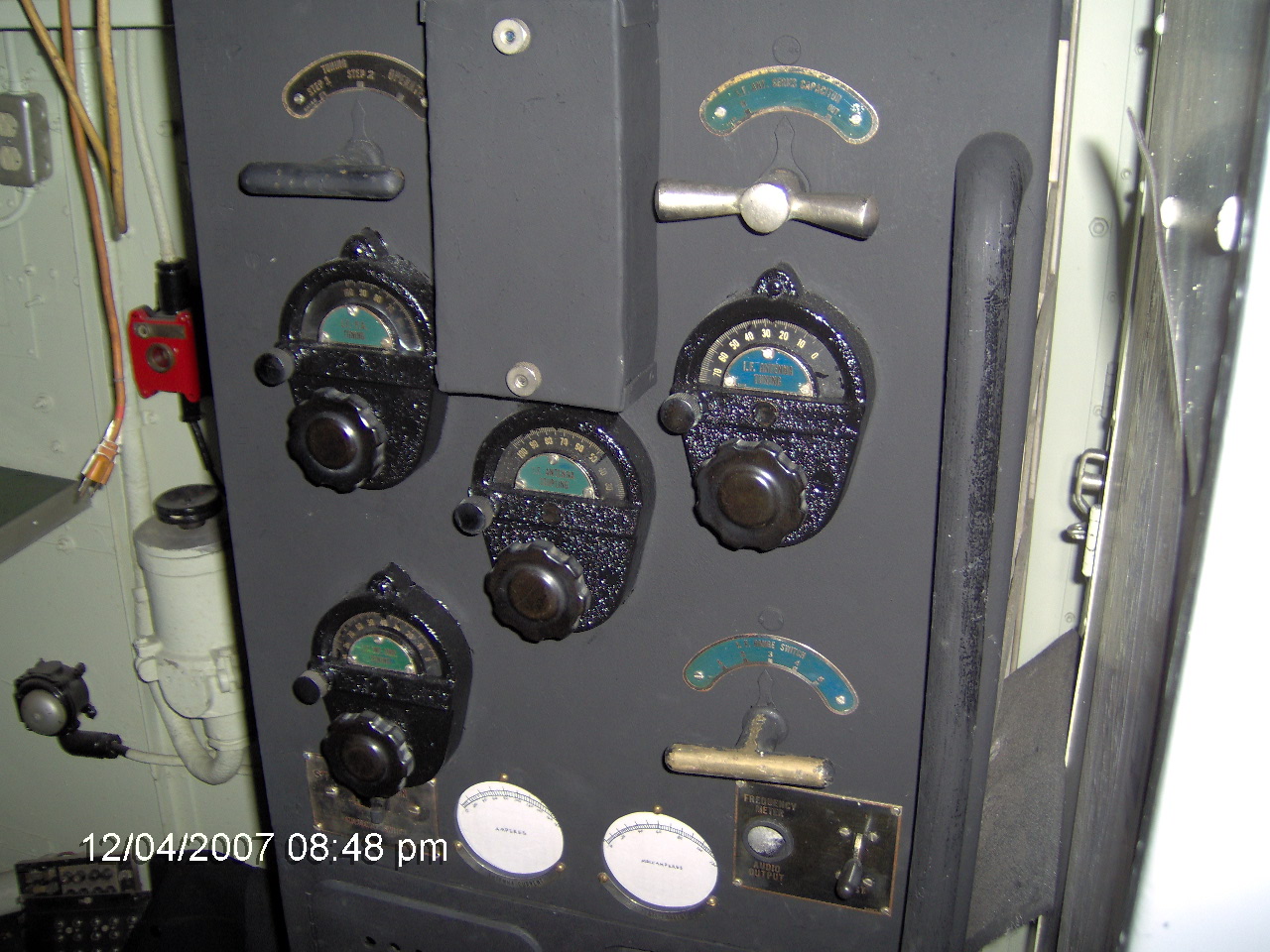

Radio Transmitter before Radio Transmitter after Radio Transmitter after

This page last updated 2/4/2010
DRUM228.ORG created 10/3/2008
email
